Capital Project

About the Capital Project

Overview | Before the Build: Photos | Project Timeline | Project Progress | Project Funding Breakdown | Frequently Asked Questions

Project Progress

Elementary School | Junior-Senior High School | Transportation Building

Overview

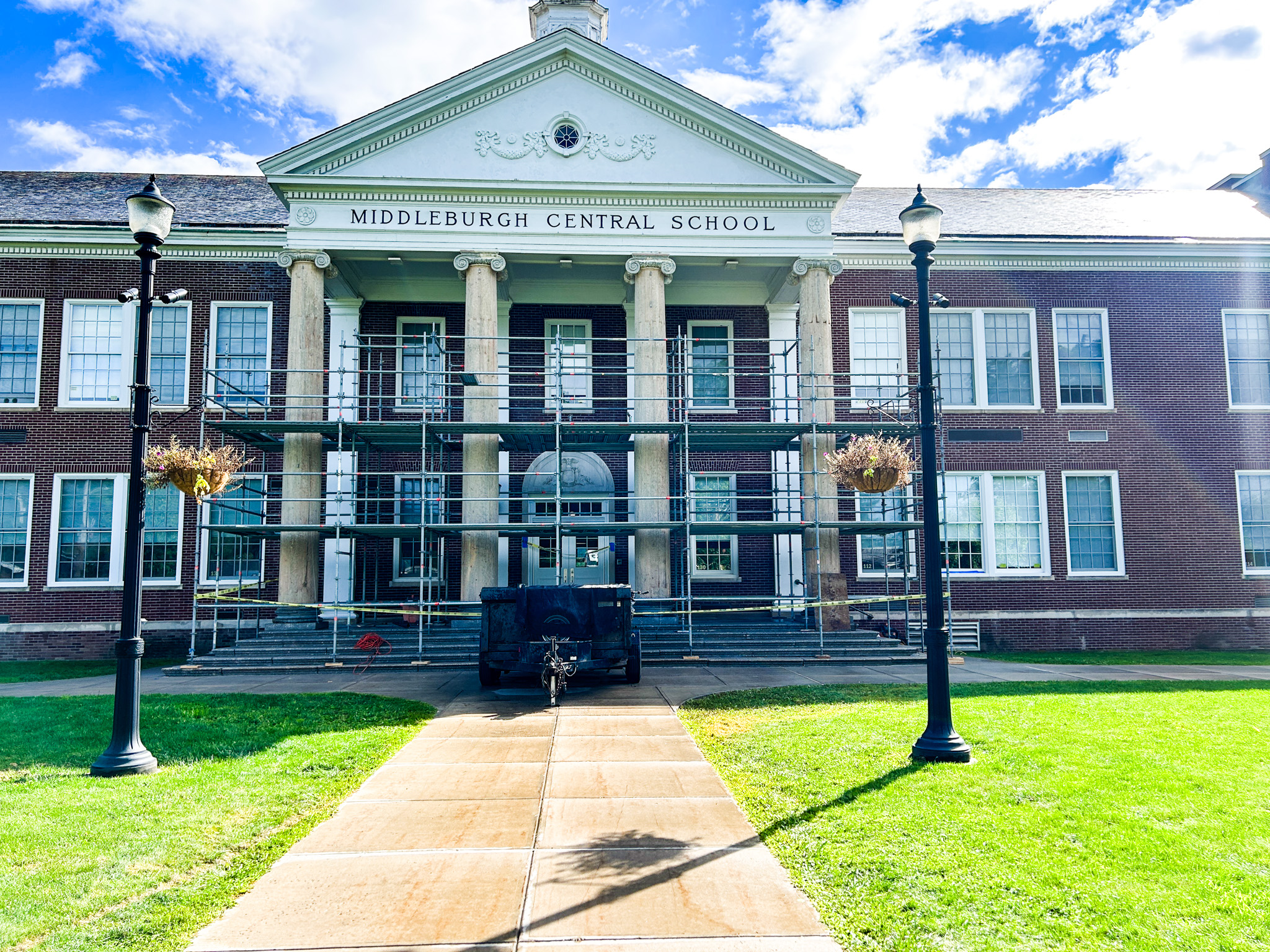

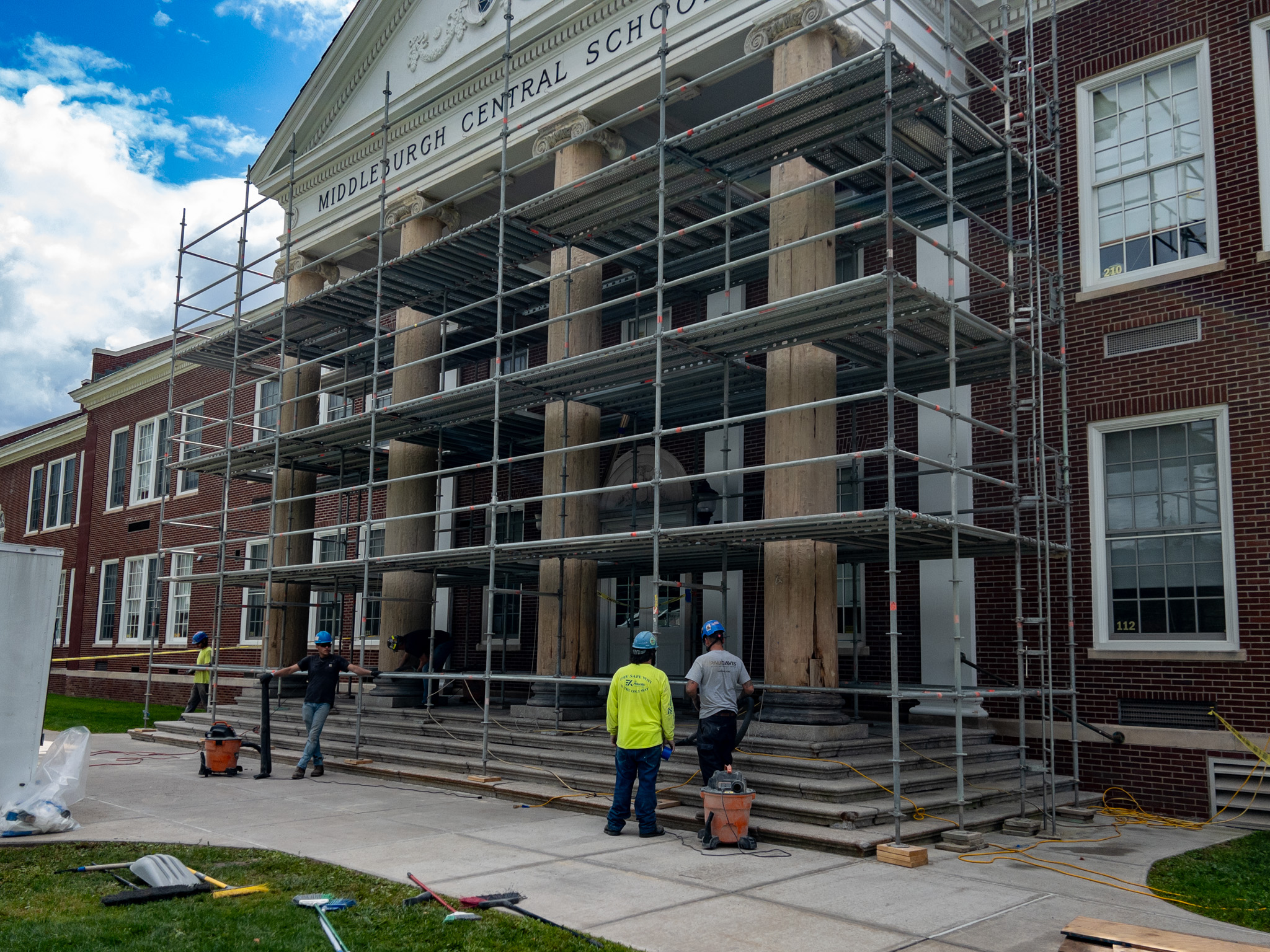

Front entrance of Middleburgh Central School, a red-brick building with white columns and a classical pediment.

In May 2025, district residents approved an $8.1 million capital project to fortify and improve facilities for current and future generations of students and preserve our buildings as an essential community resource. Through the use of state grants and $2 million from the MCSD Capital Reserve, the capital project has no additional impact on the tax levy.

Repairs and enhancements included in the 2026 Capital Project are focused on resolving and improving safety and services for students and staff, current facility repair needs, preparing our infrastructure for future needs, and supporting community services in our buildings.

Back to Top

Before the Build: Photos

As the work begins, take a look at the facilities that will be improved through the approved capital project. These investments are designed to support students, staff, and our community for years to come.

Back to Top

Project Timeline

Major construction began in May 2026, with smaller projects starting sooner. All work is planned to be completed by fall of 2026.

Timeline graphic showing steps of a school construction project from referendum vote in May 2025 through construction beginning in May 2026, including planning, SED approval, bidding, and award milestones.

  • Referendum Vote – May 2025
  • Architects Prepare Plans – May to August 2025
  • Plans Submitted to SED – September 2025
    (Plans are sent to the State Education Department (SED) for review.)
  • District Receives SED Approval – January 2026
    (The State Education Department (SED) grants permission to move forward.)
  • District Bids Project – February 2026
  • Bids Awarded by BOE – March 2026
    (The Board of Education (BOE) officially selects and approves the contractors.)
  • Construction Begins – May 2026

Back to Top

Project Progress

Elementary School

Planned renovations at the elementary school focus on safety, services and accessibility.

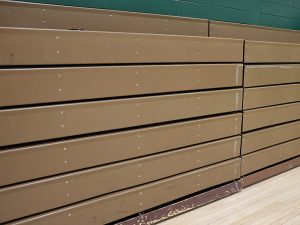

Bleachers

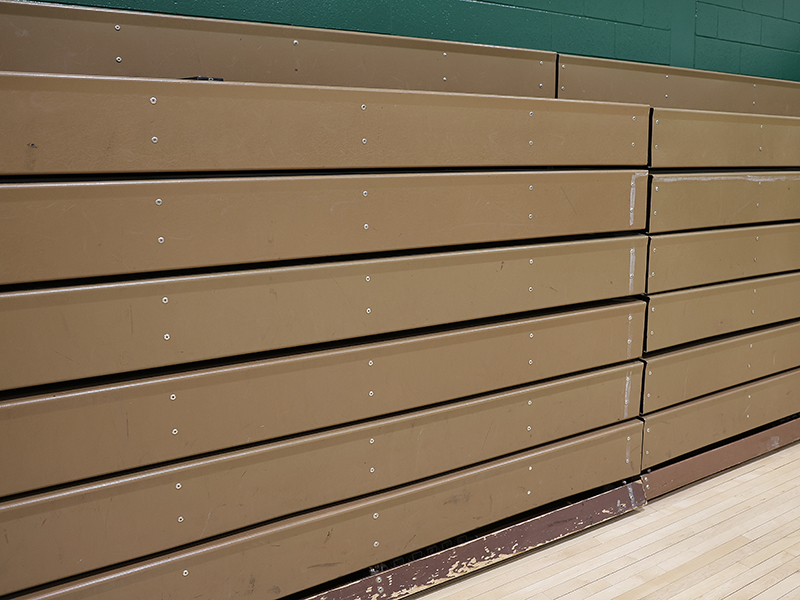

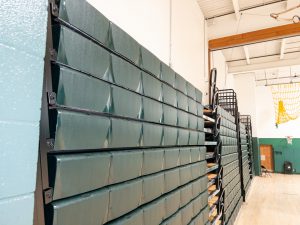

The gymnasium’s outdated bleachers, which have been unusable for years, will be replaced with a modern set featuring side rails and other enhancements. This work is anticipated for summer of 2026.

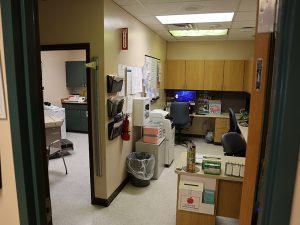

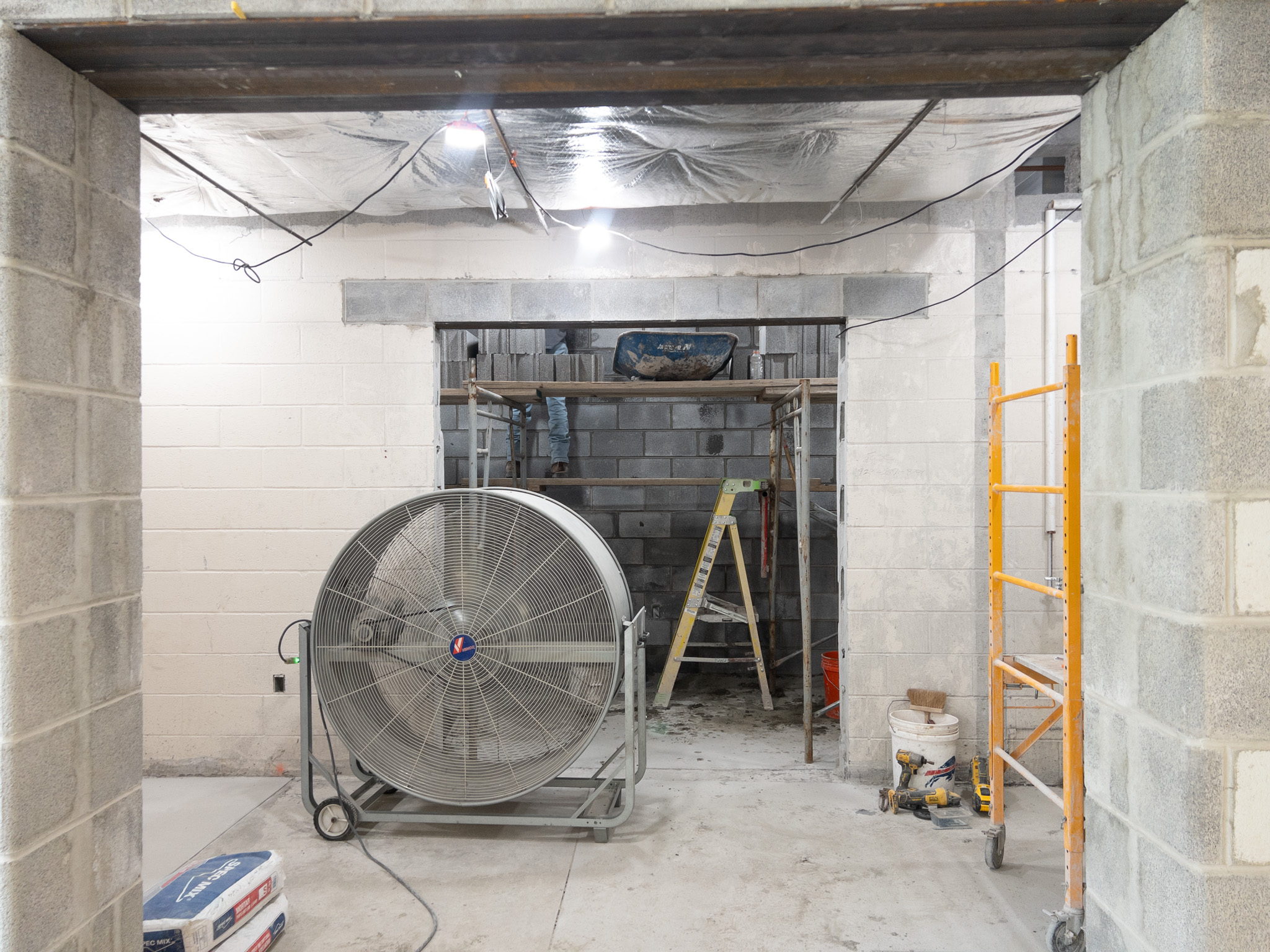

Health Center

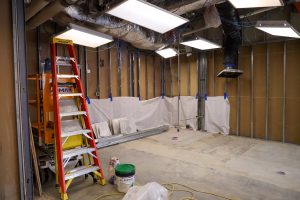

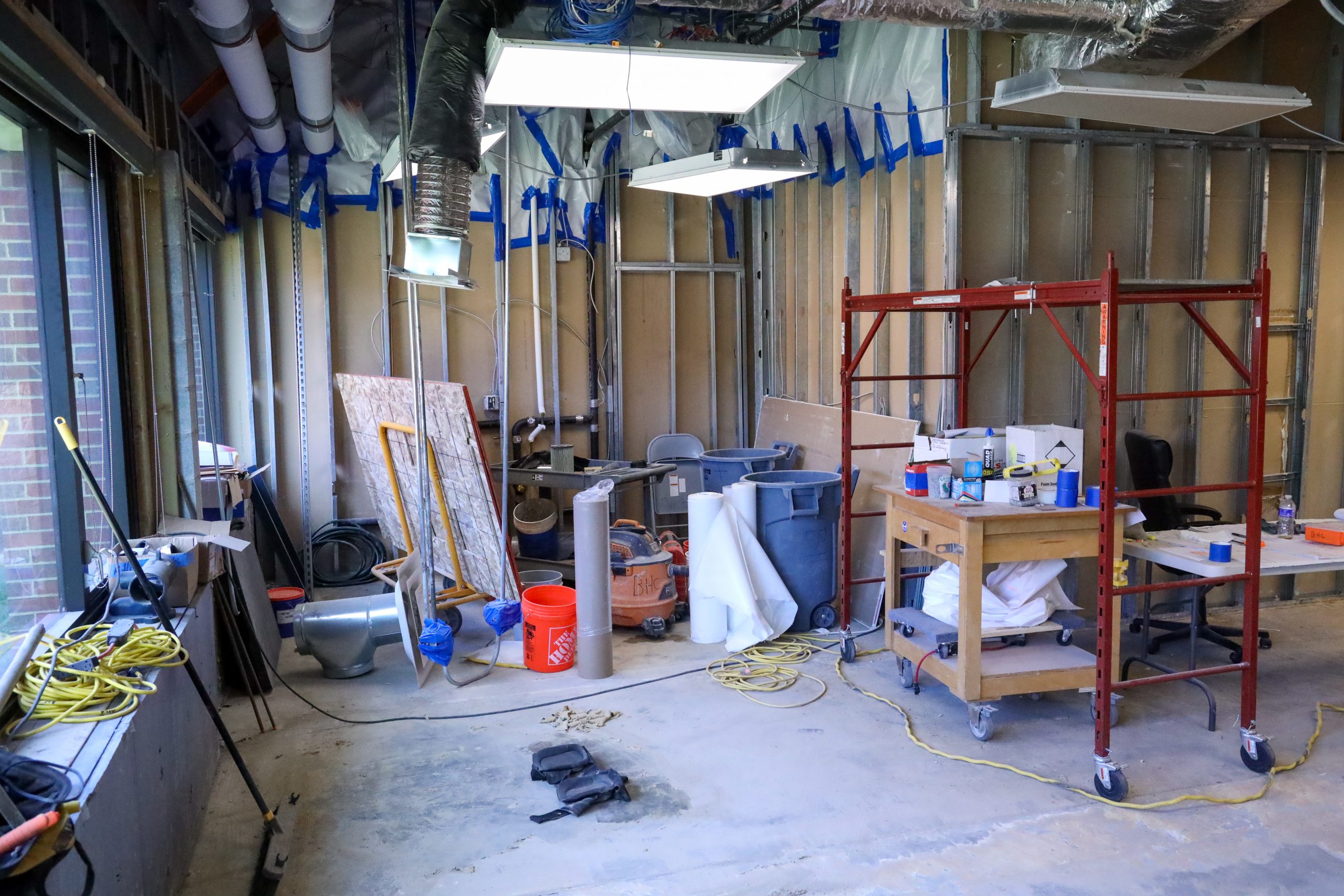

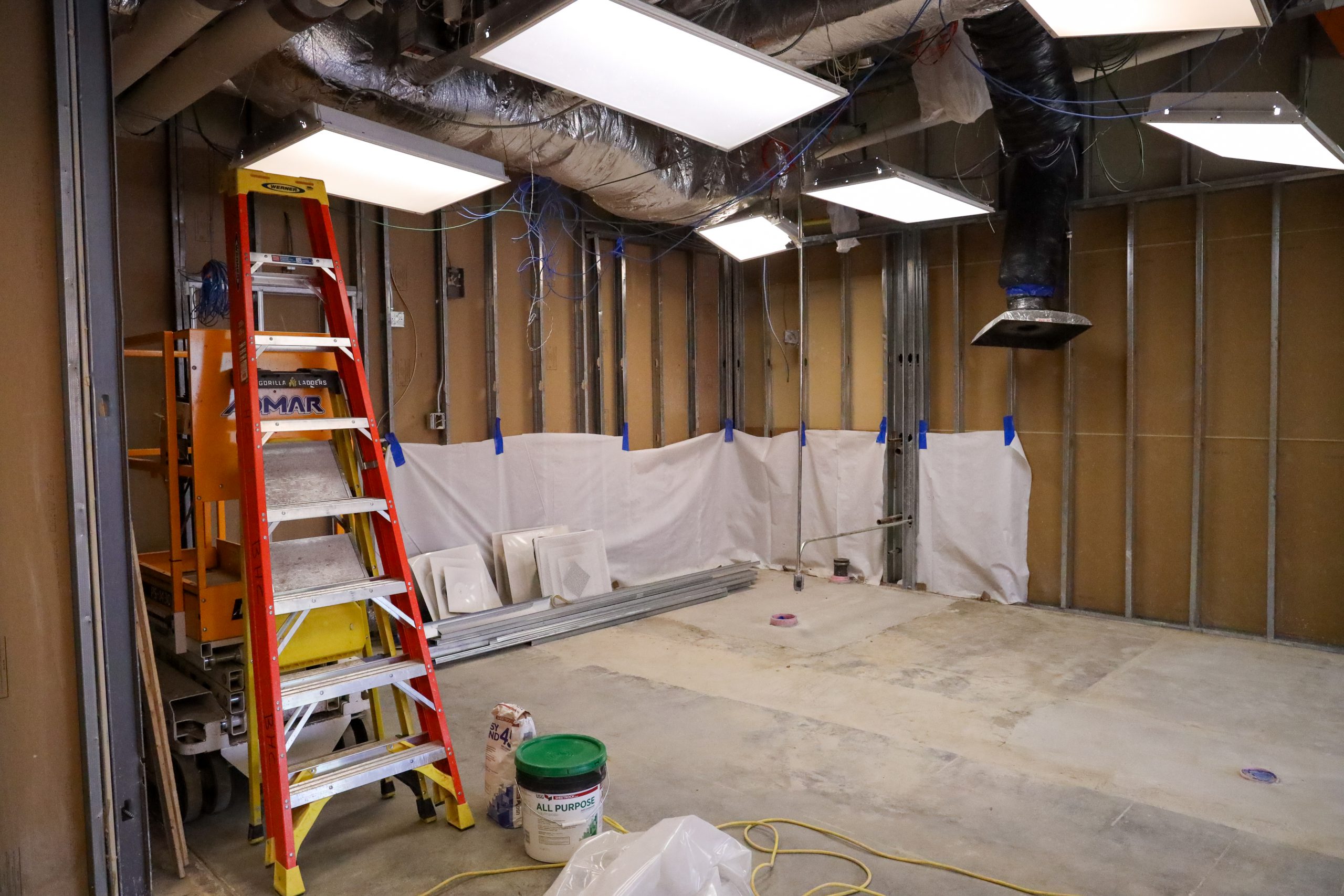

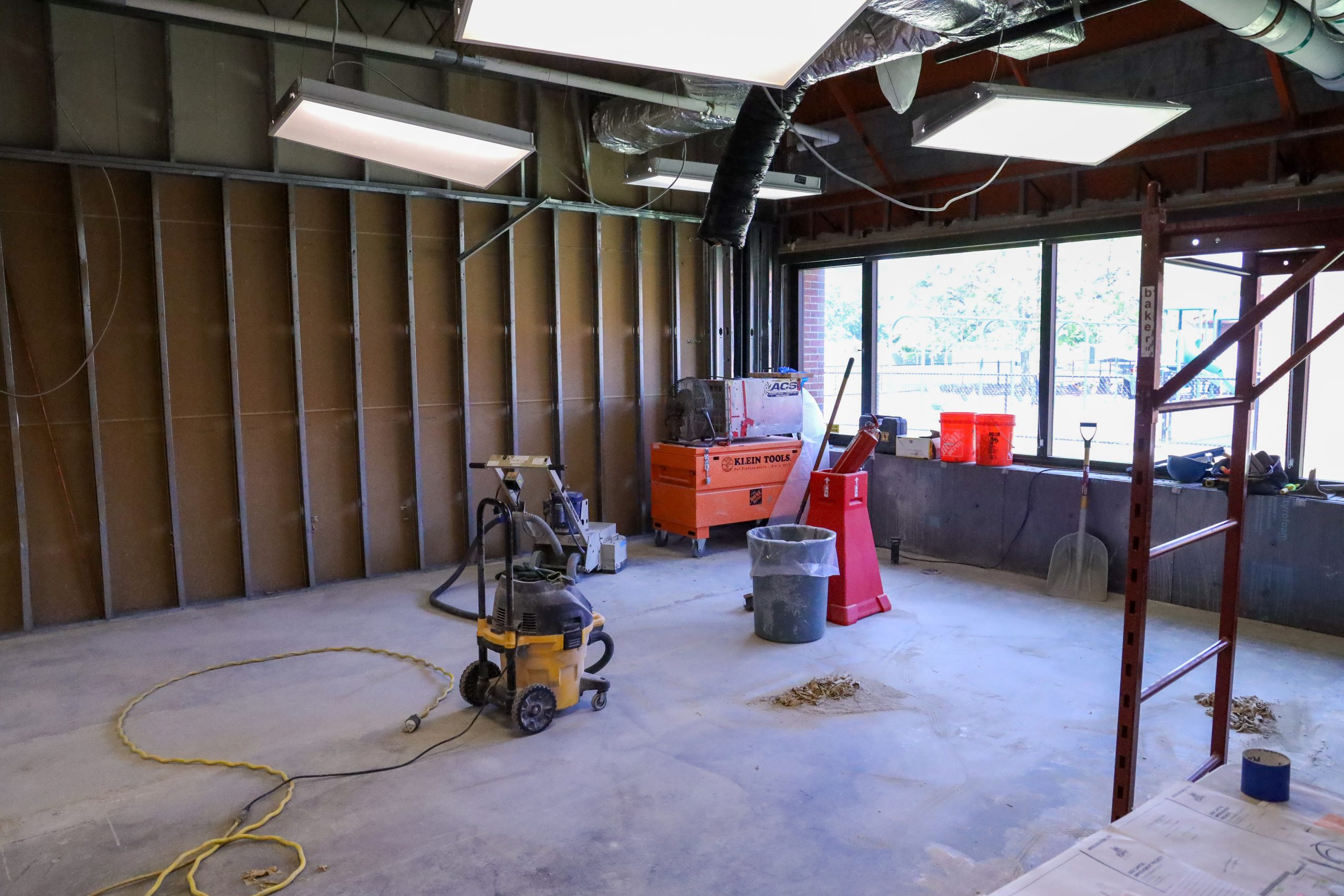

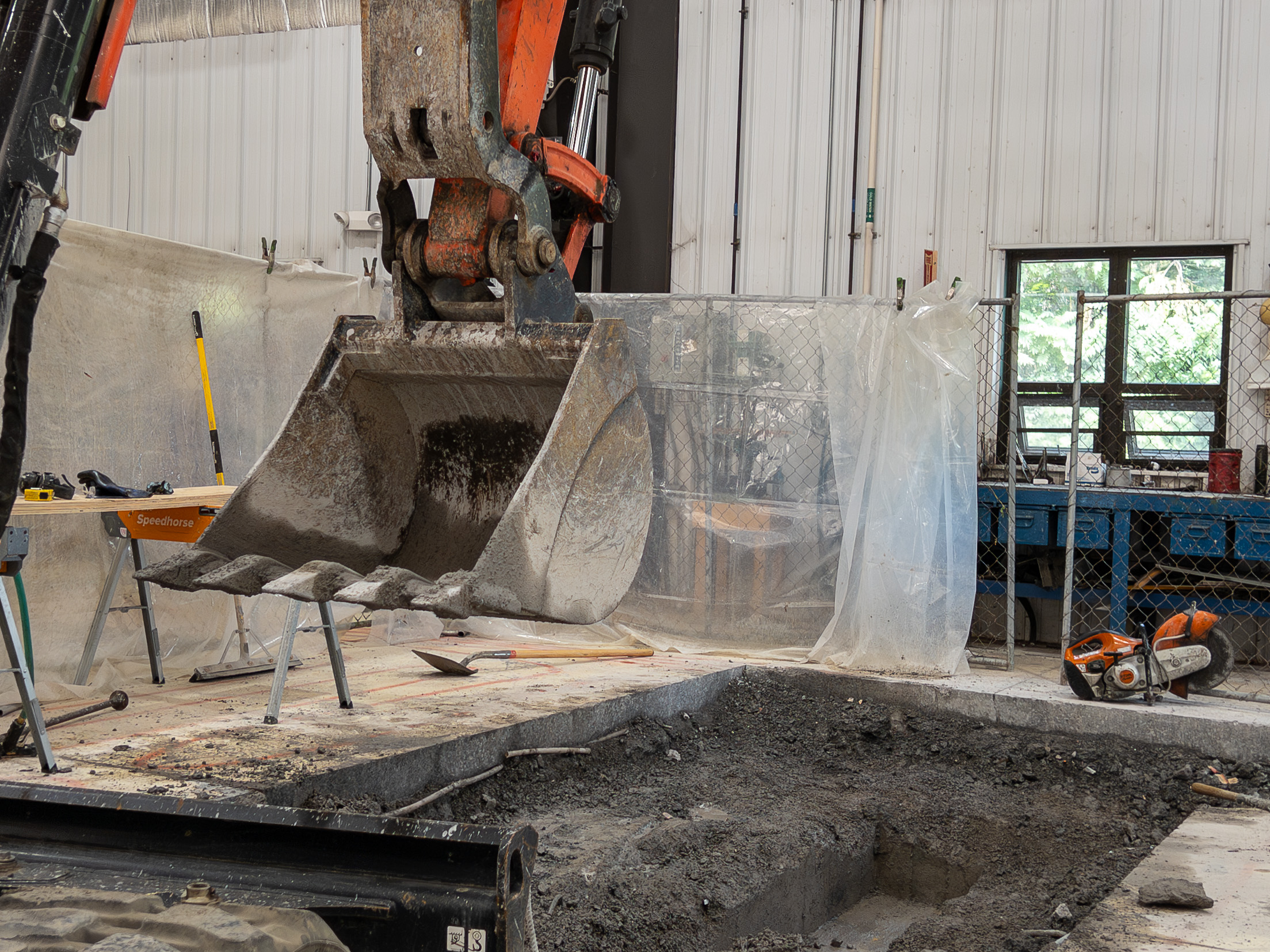

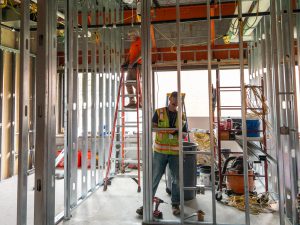

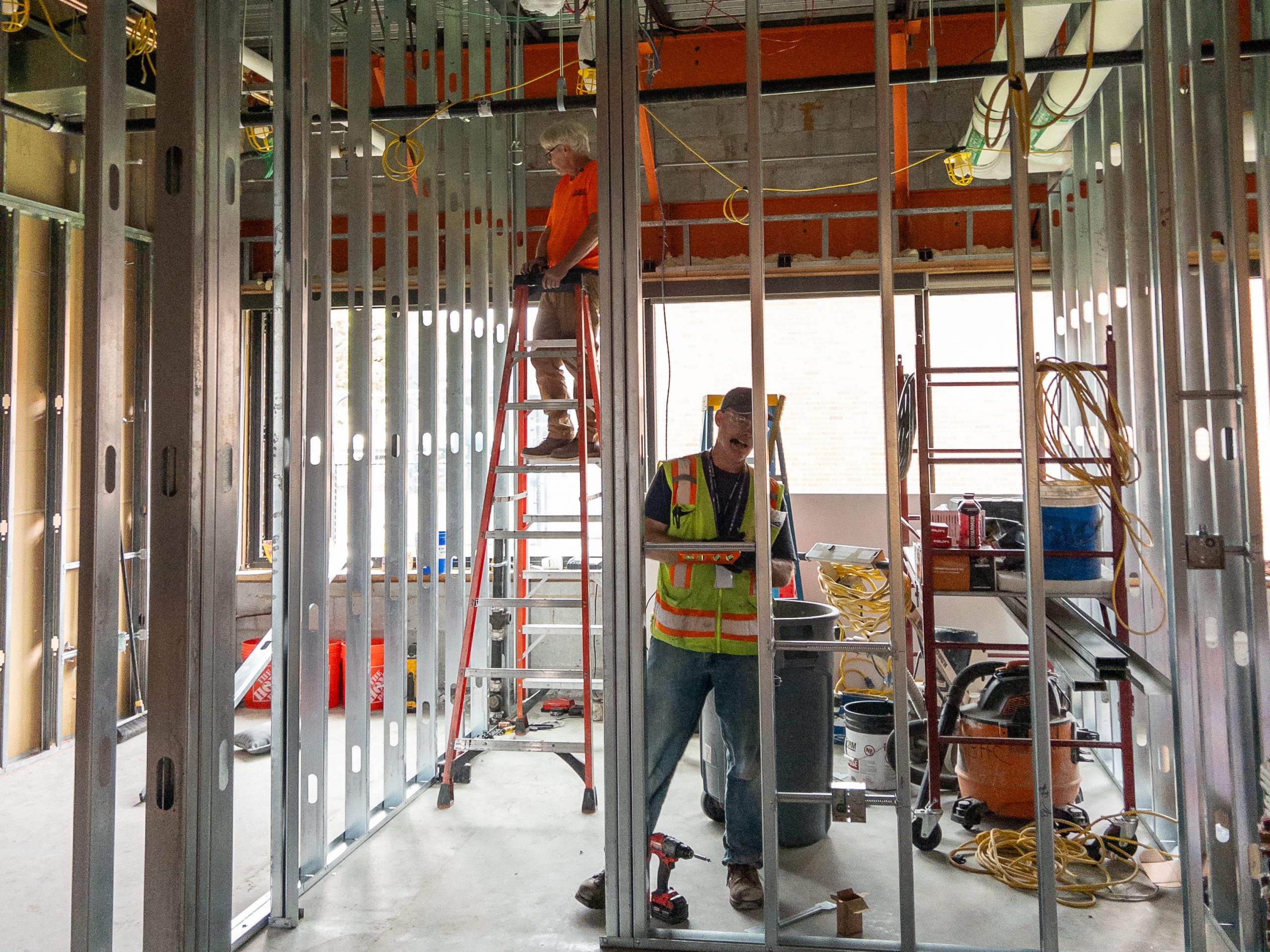

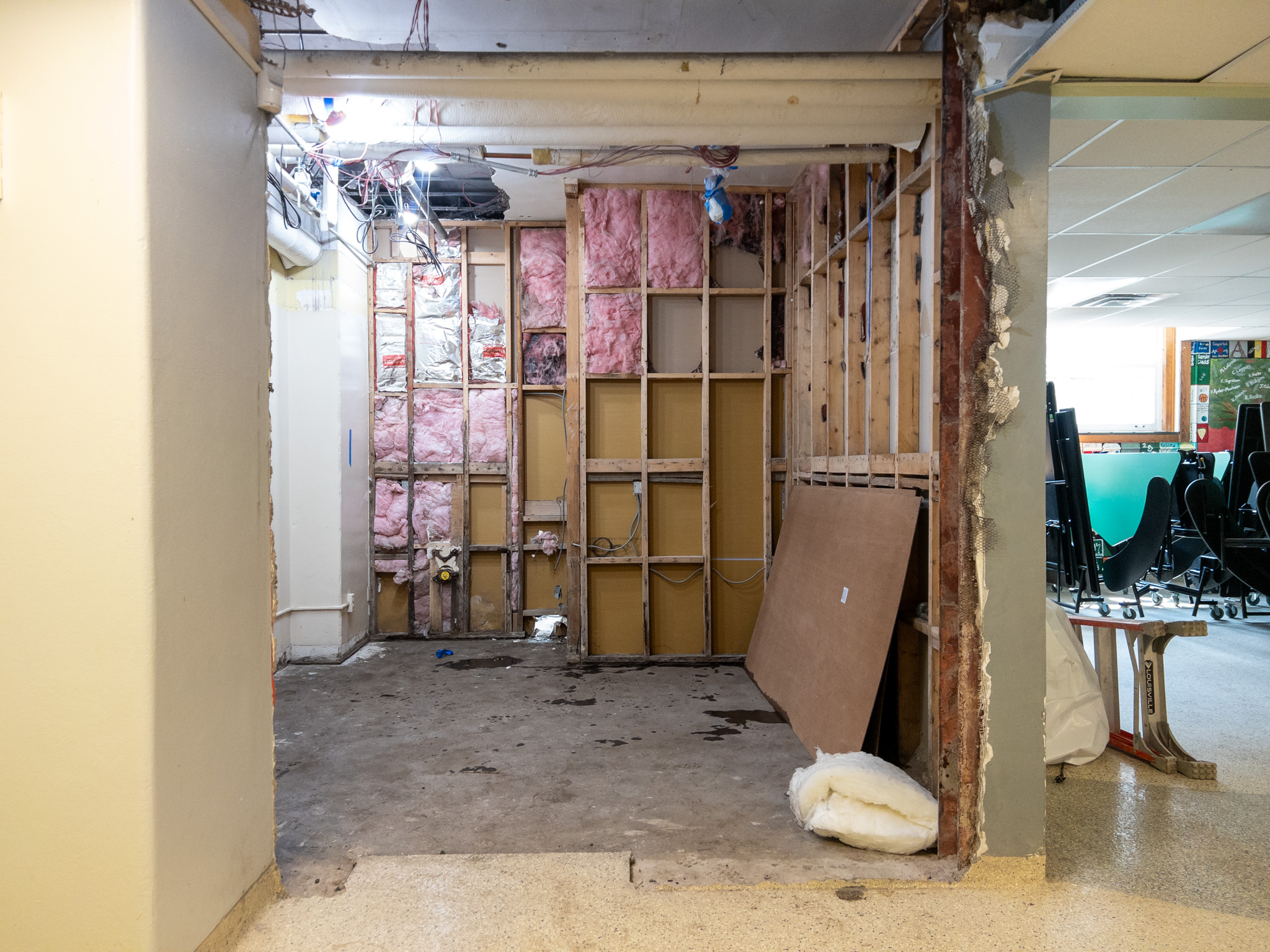

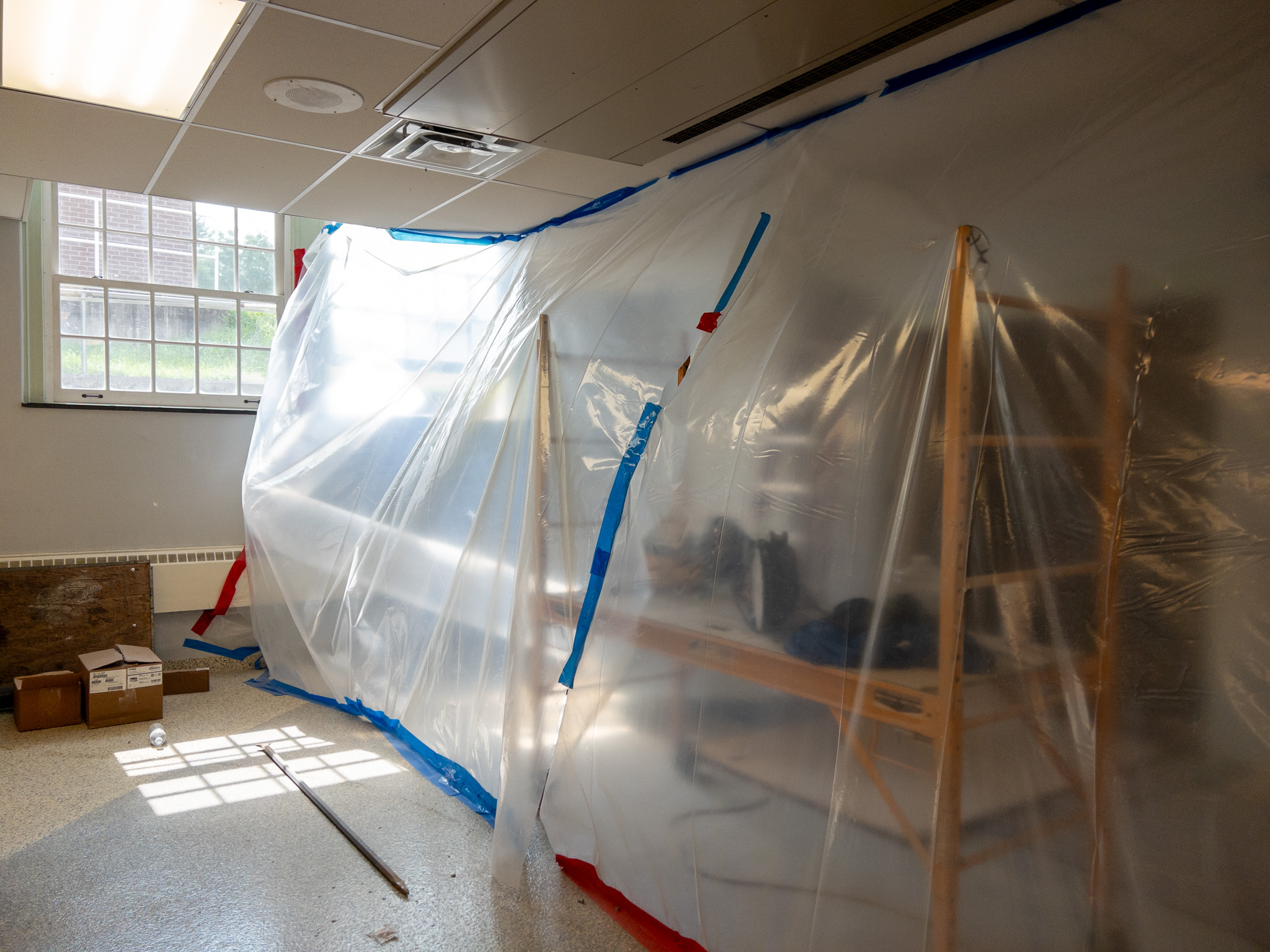

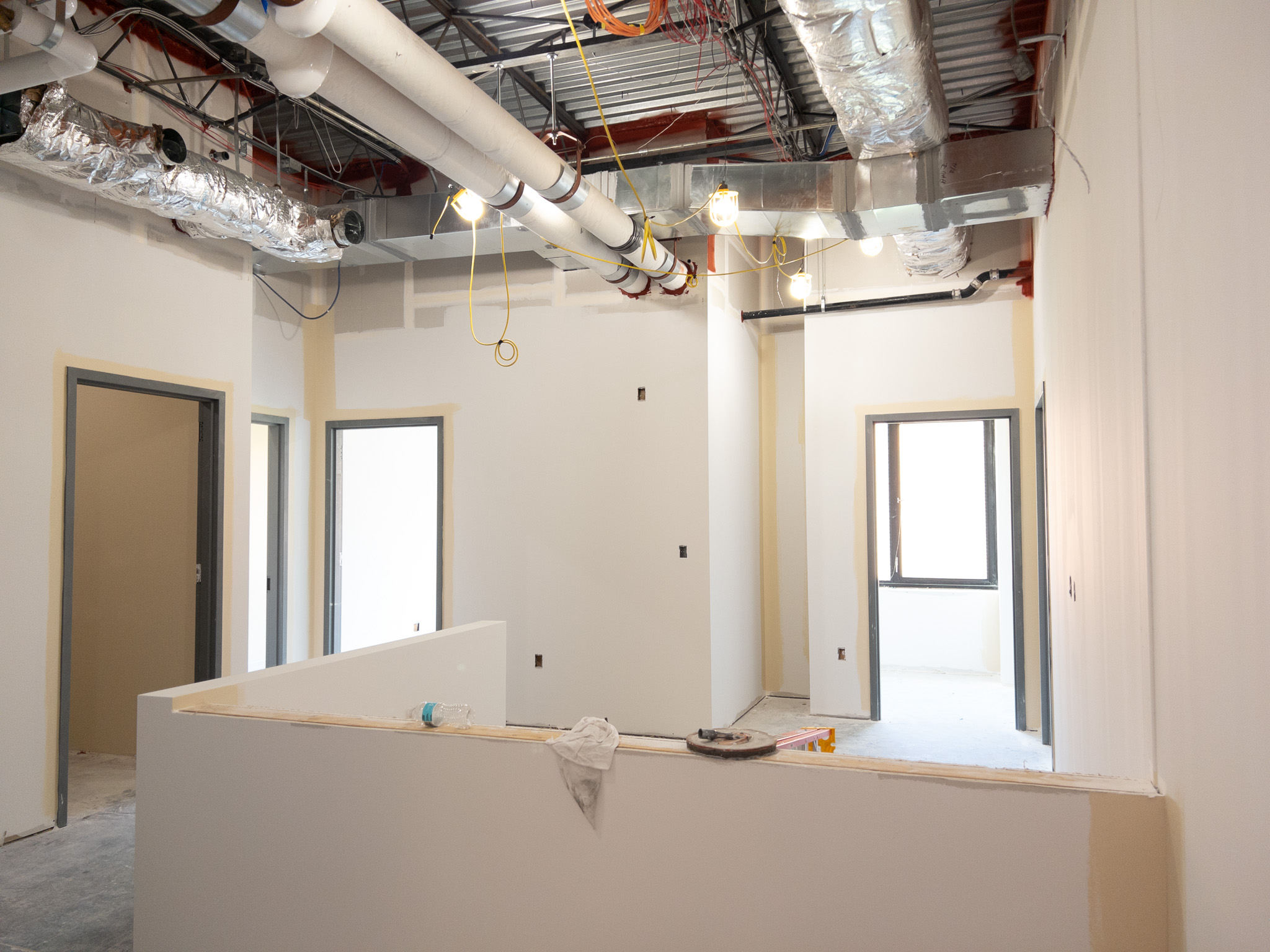

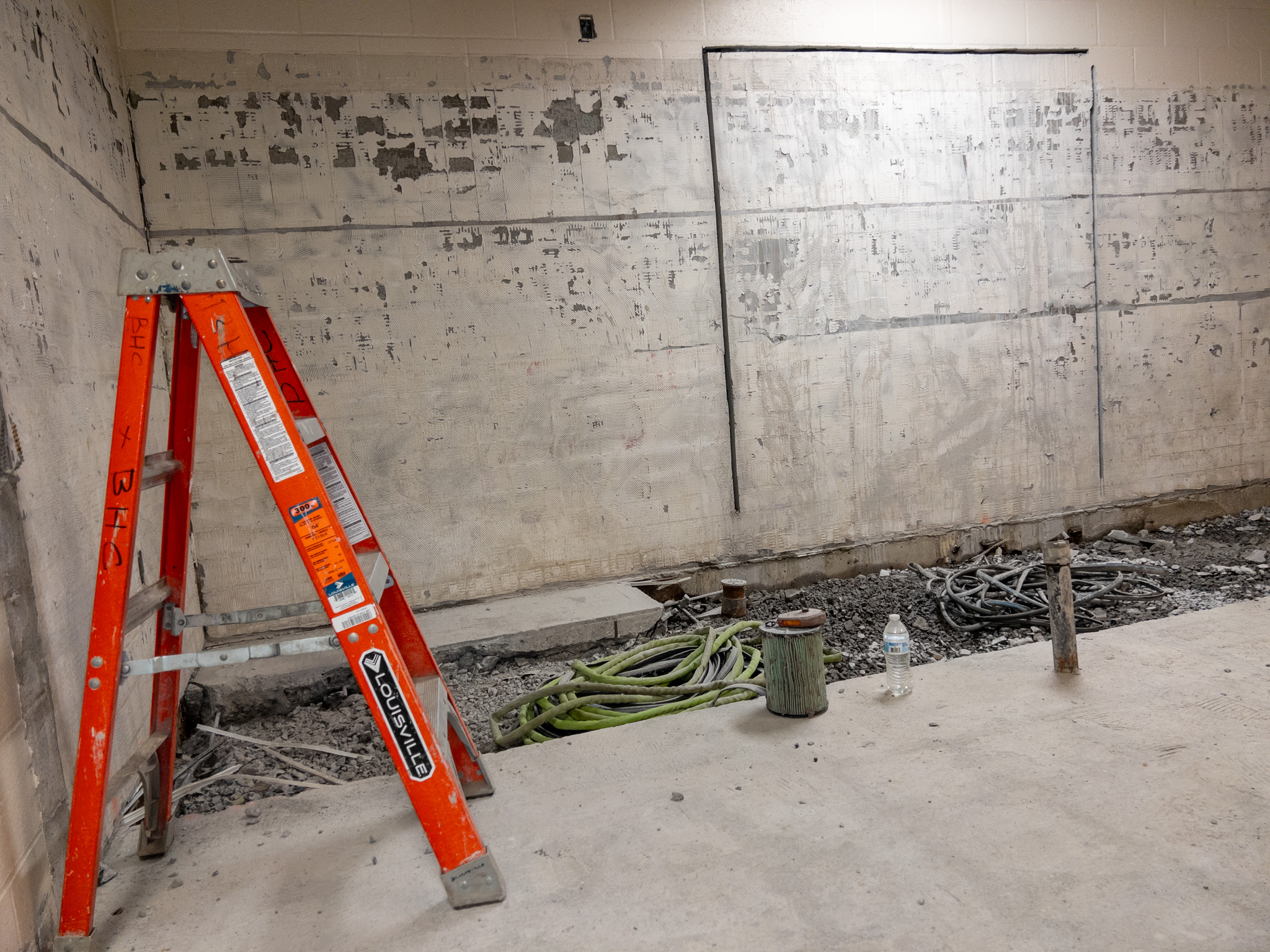

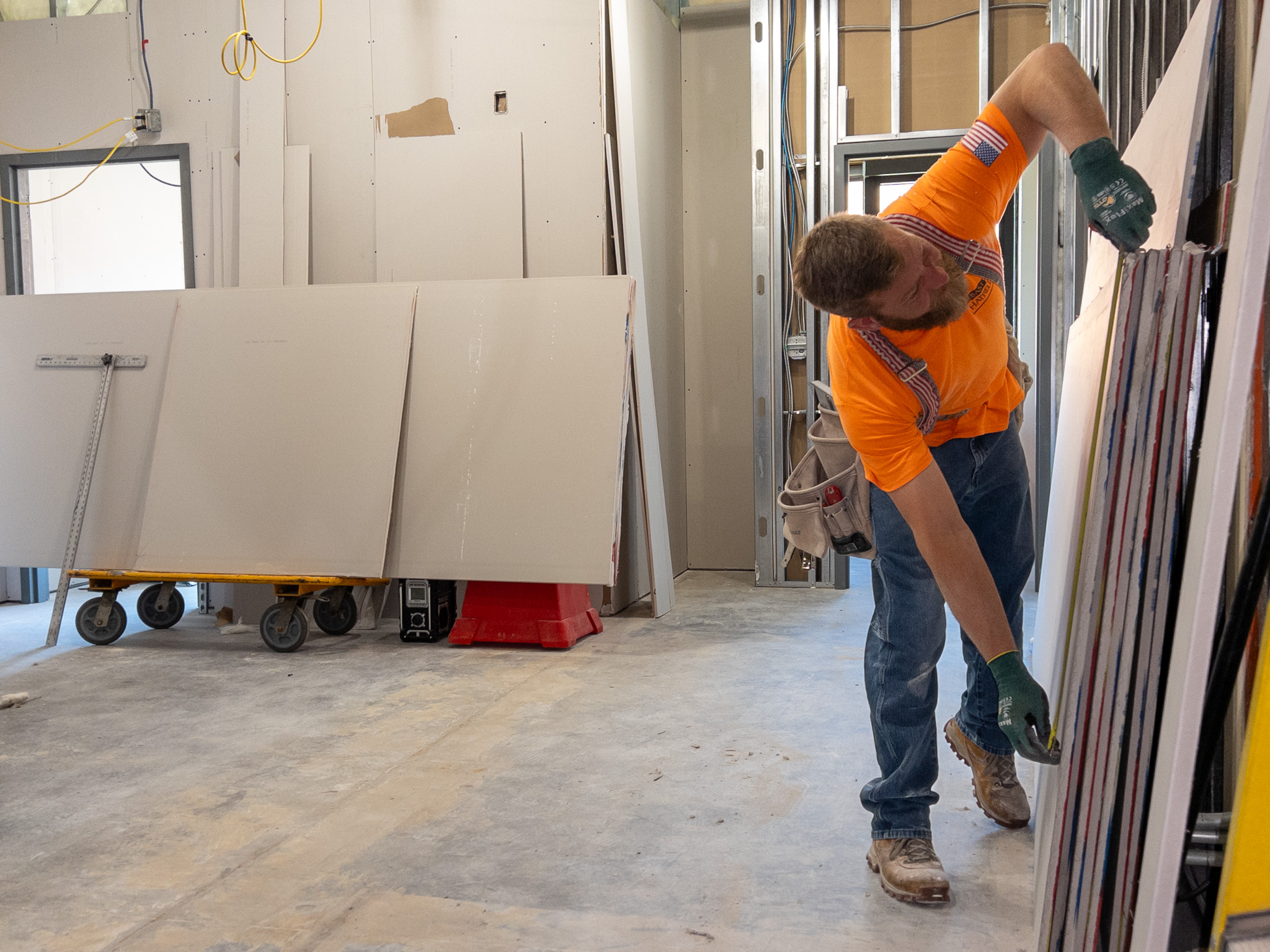

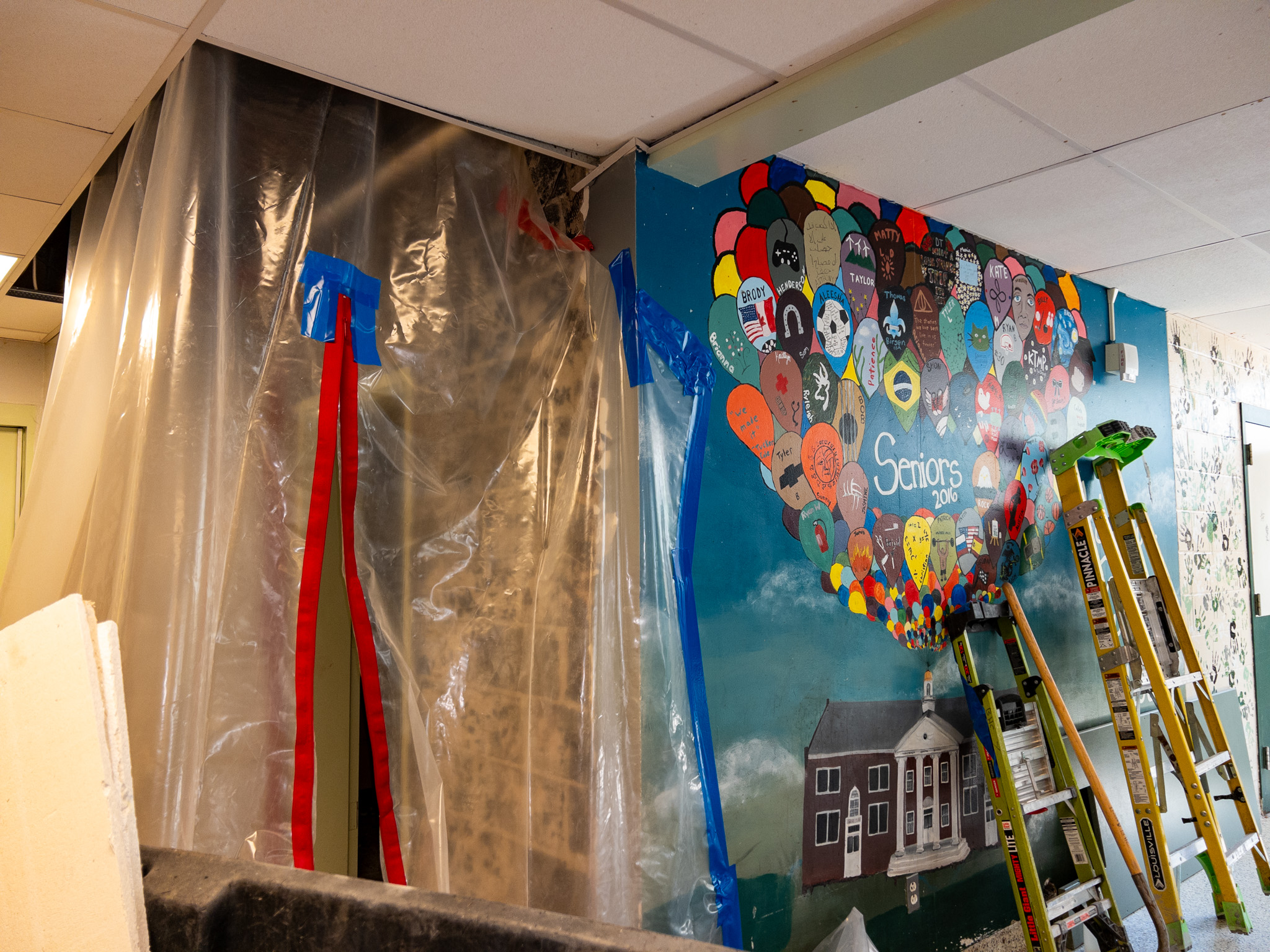

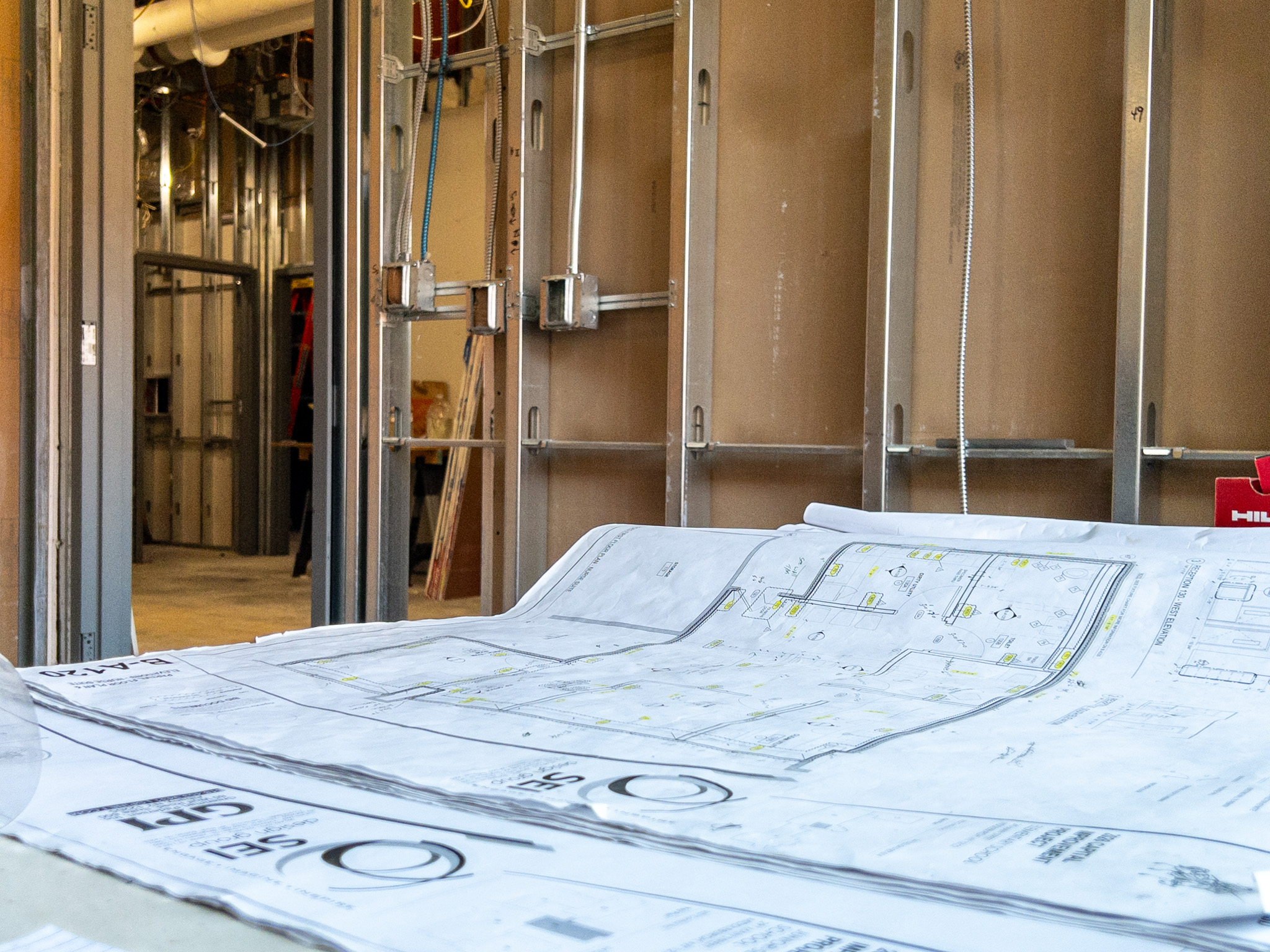

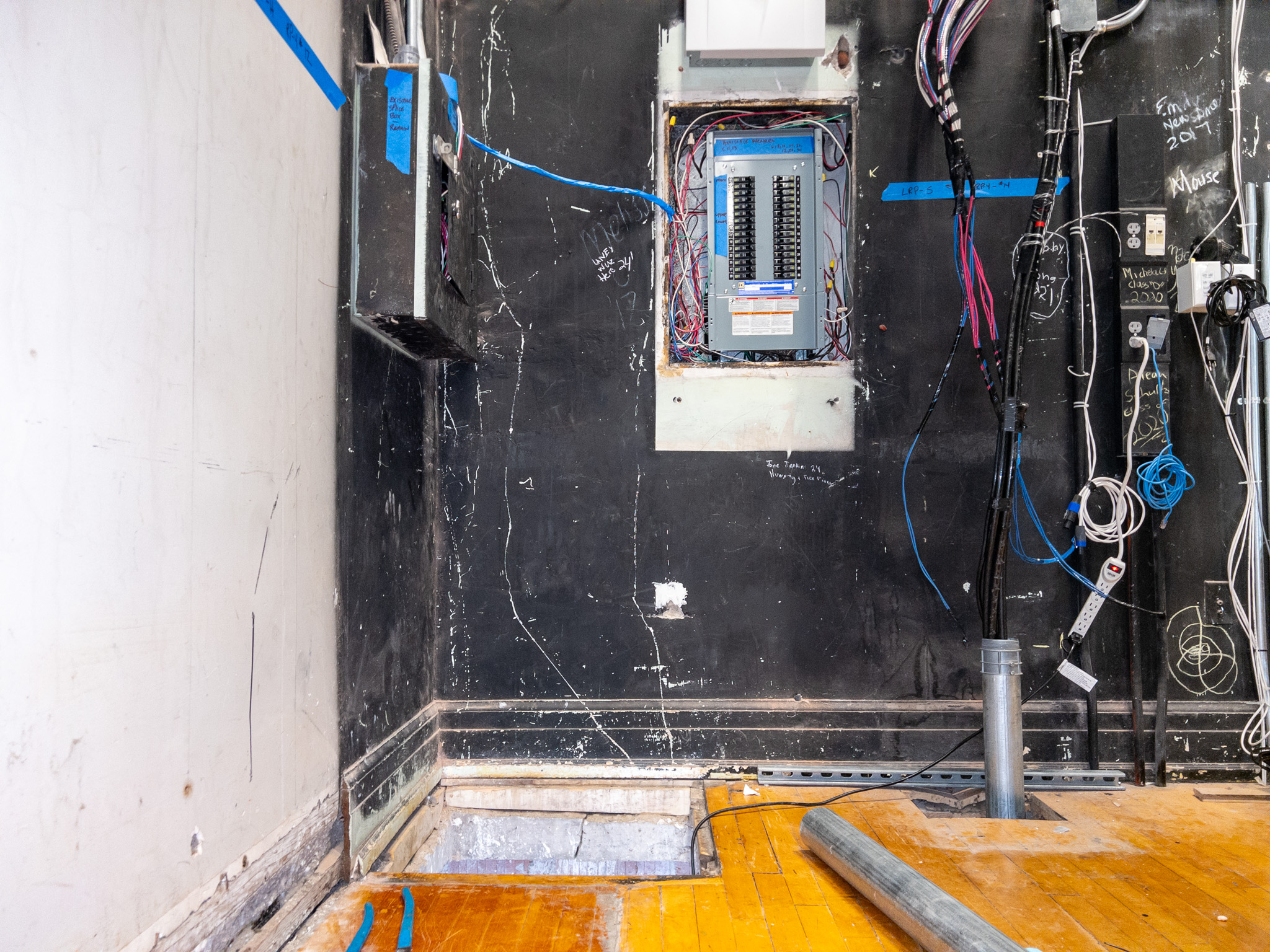

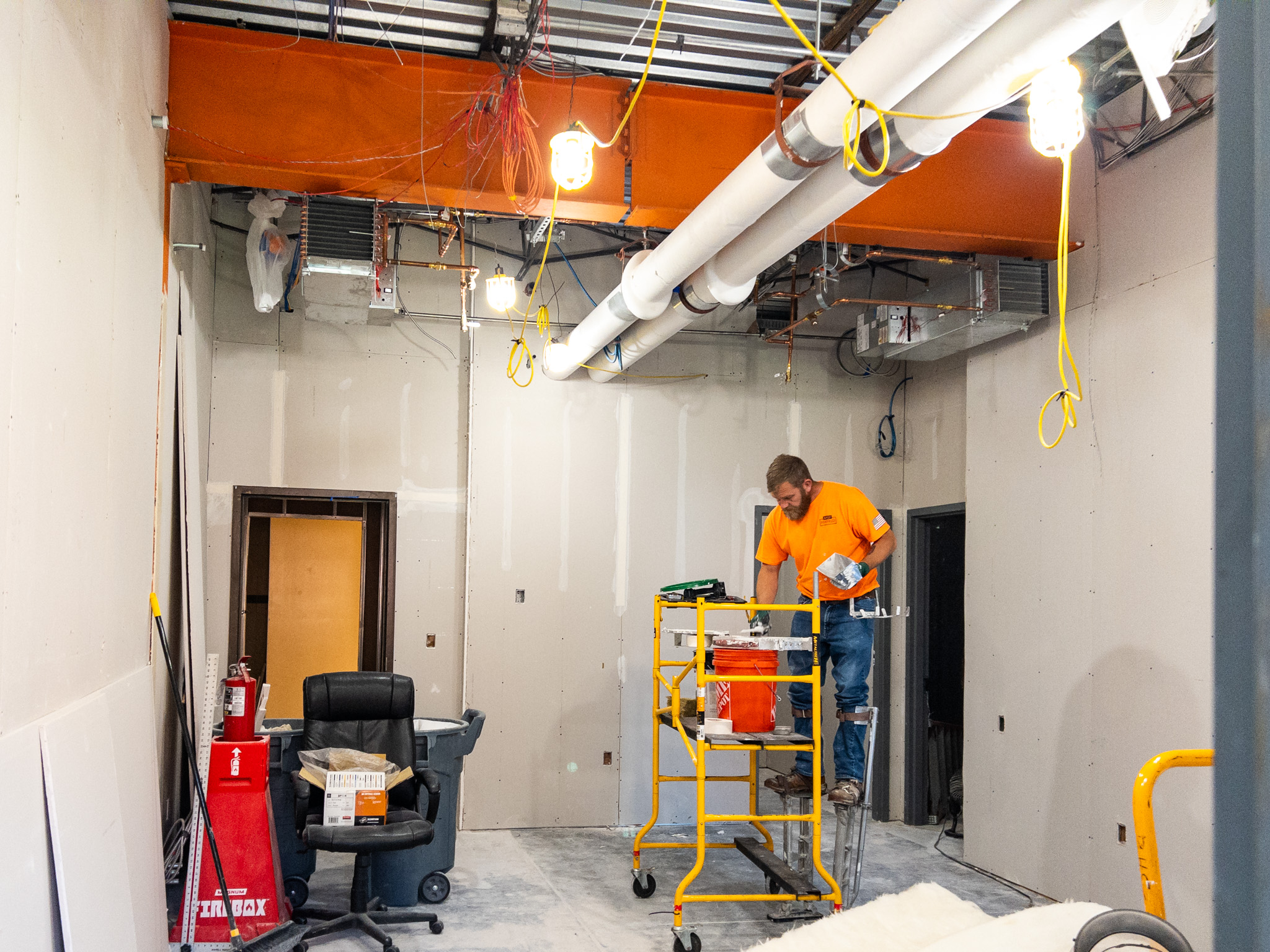

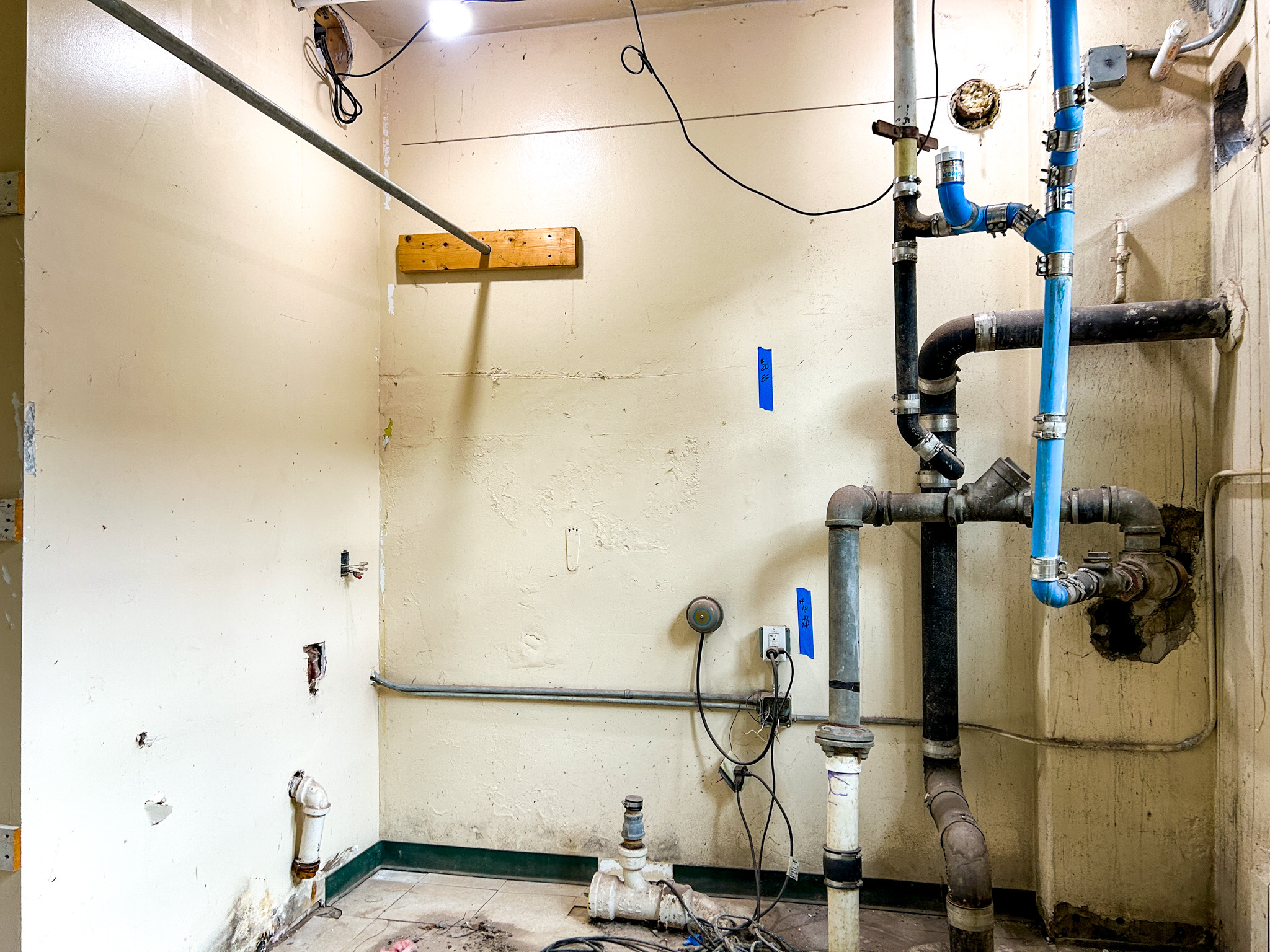

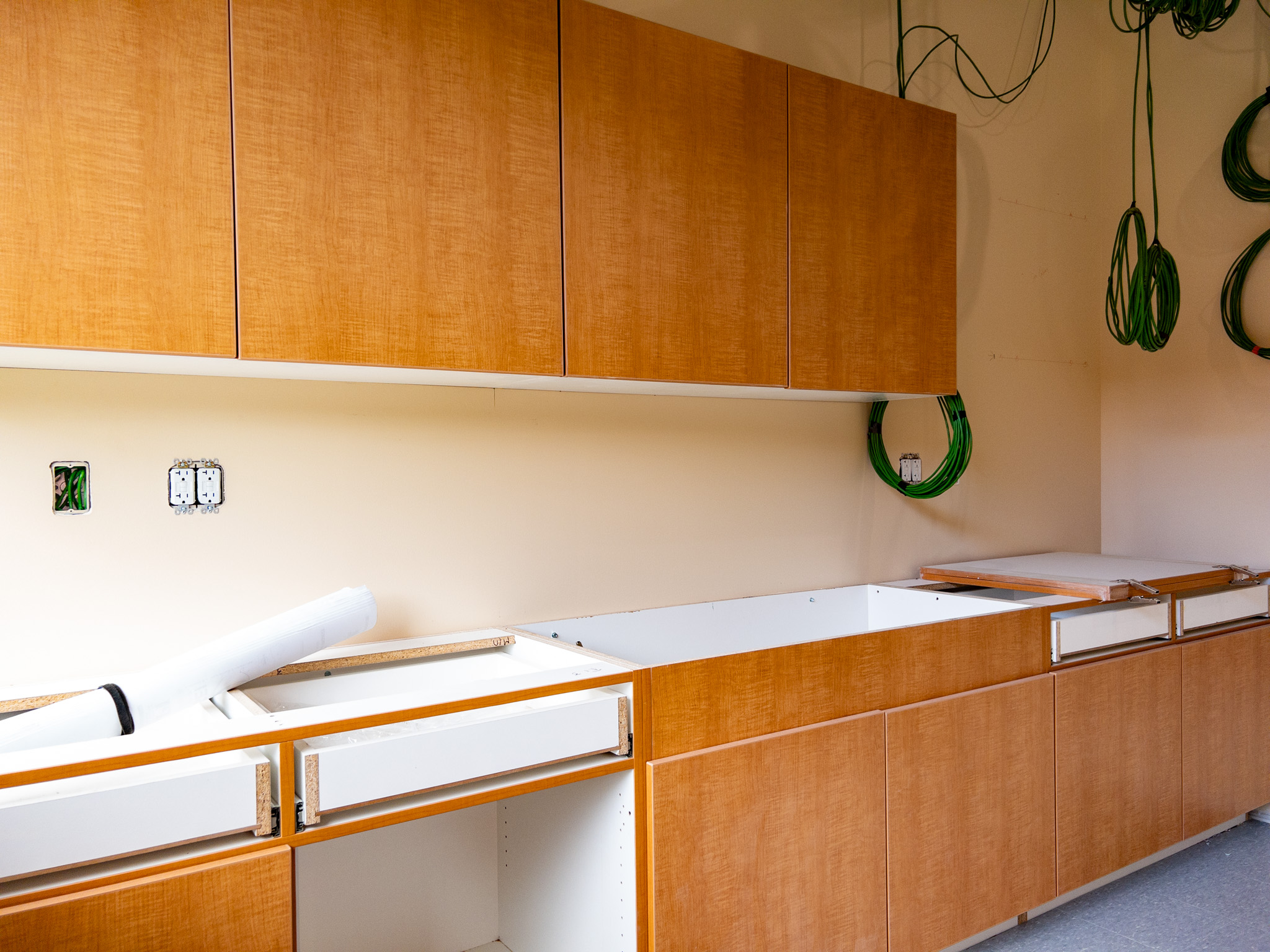

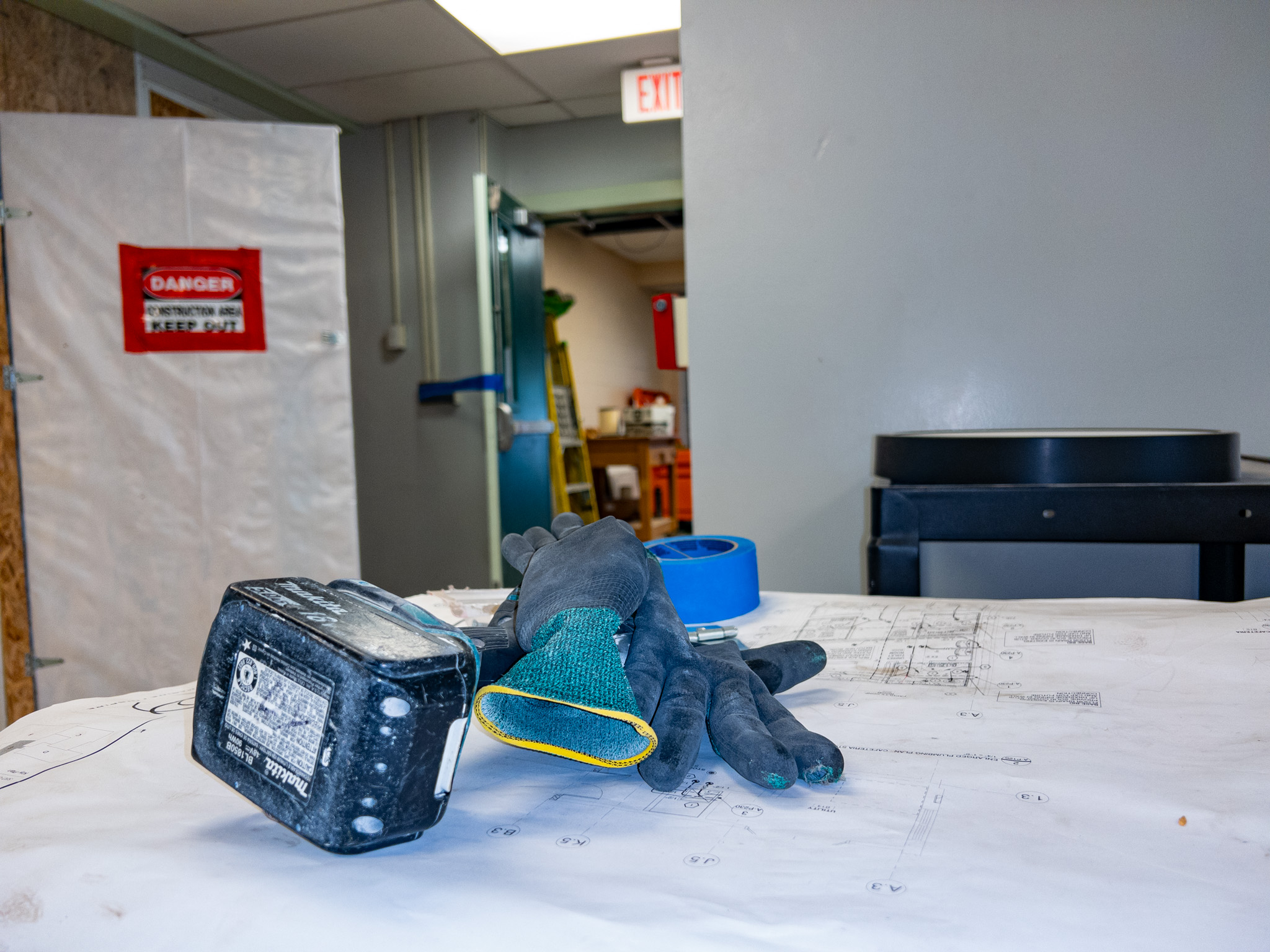

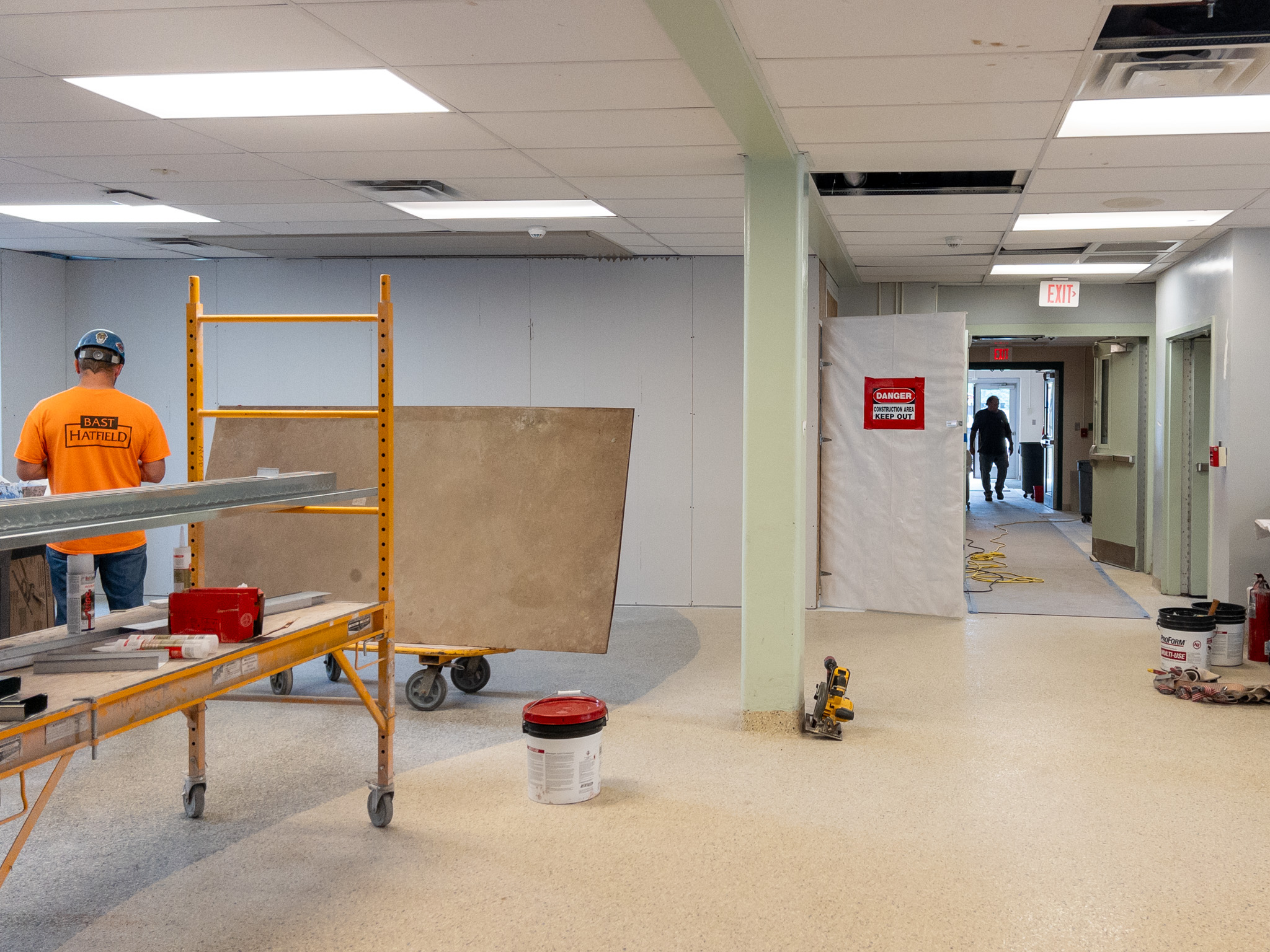

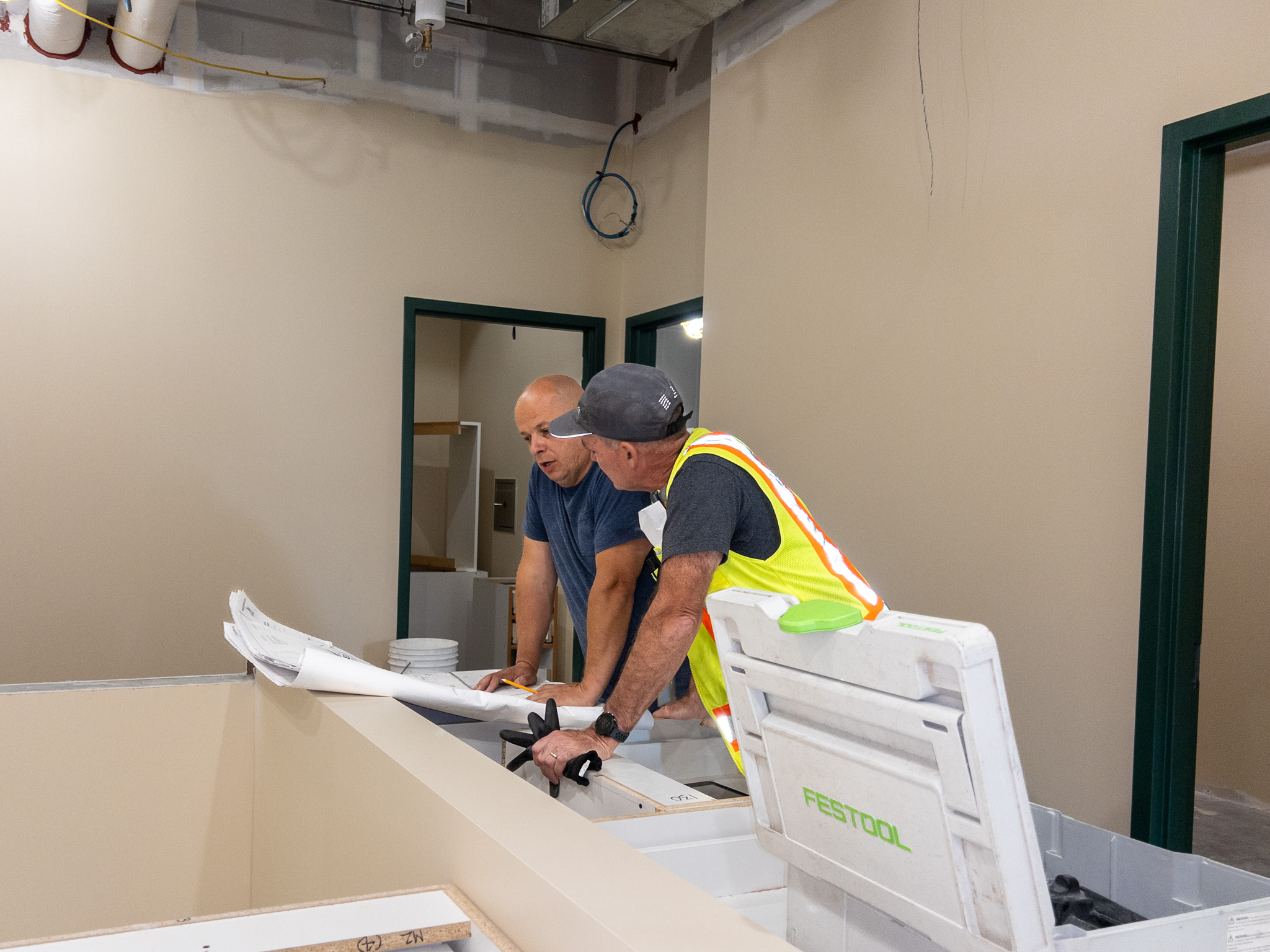

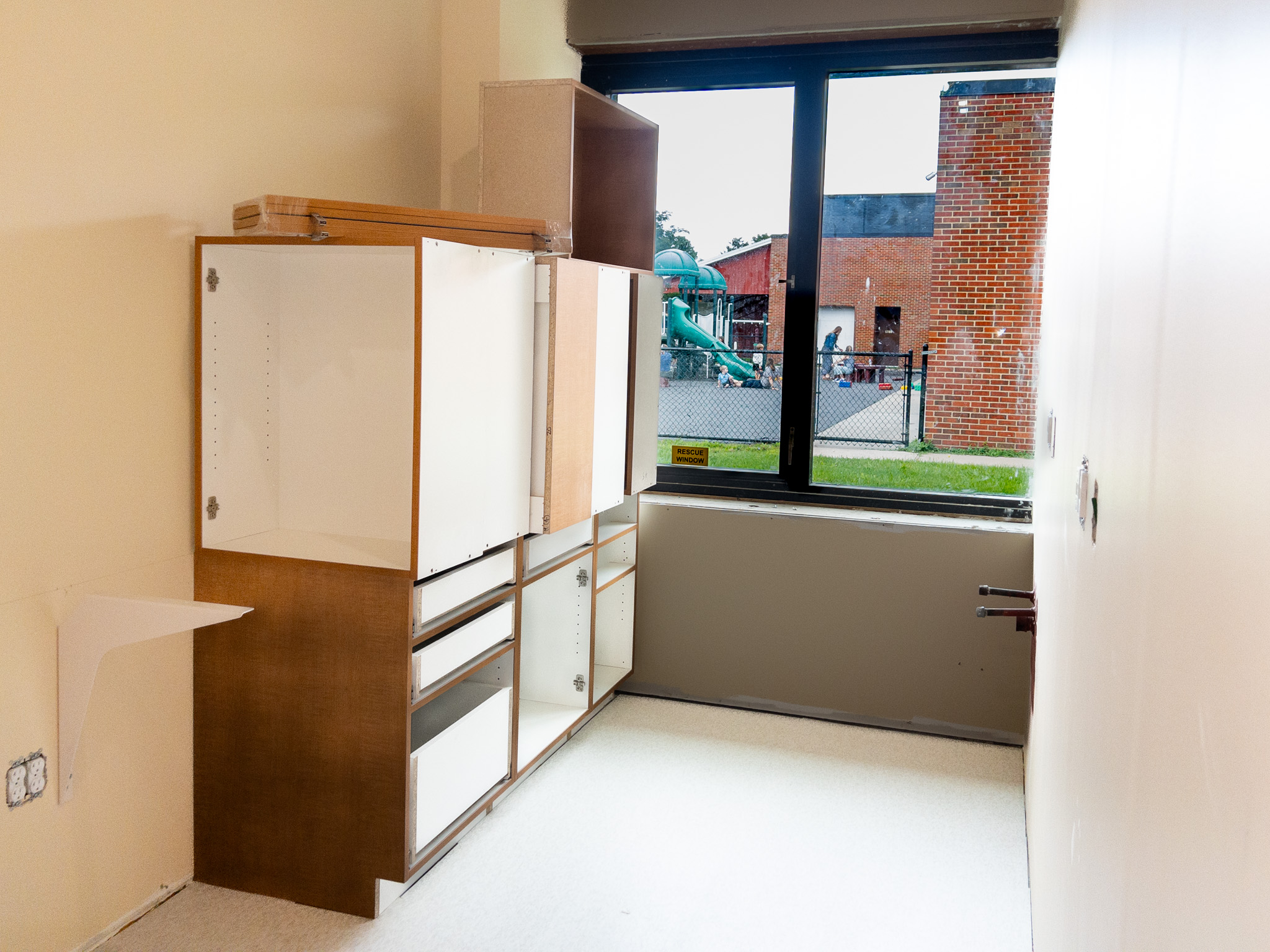

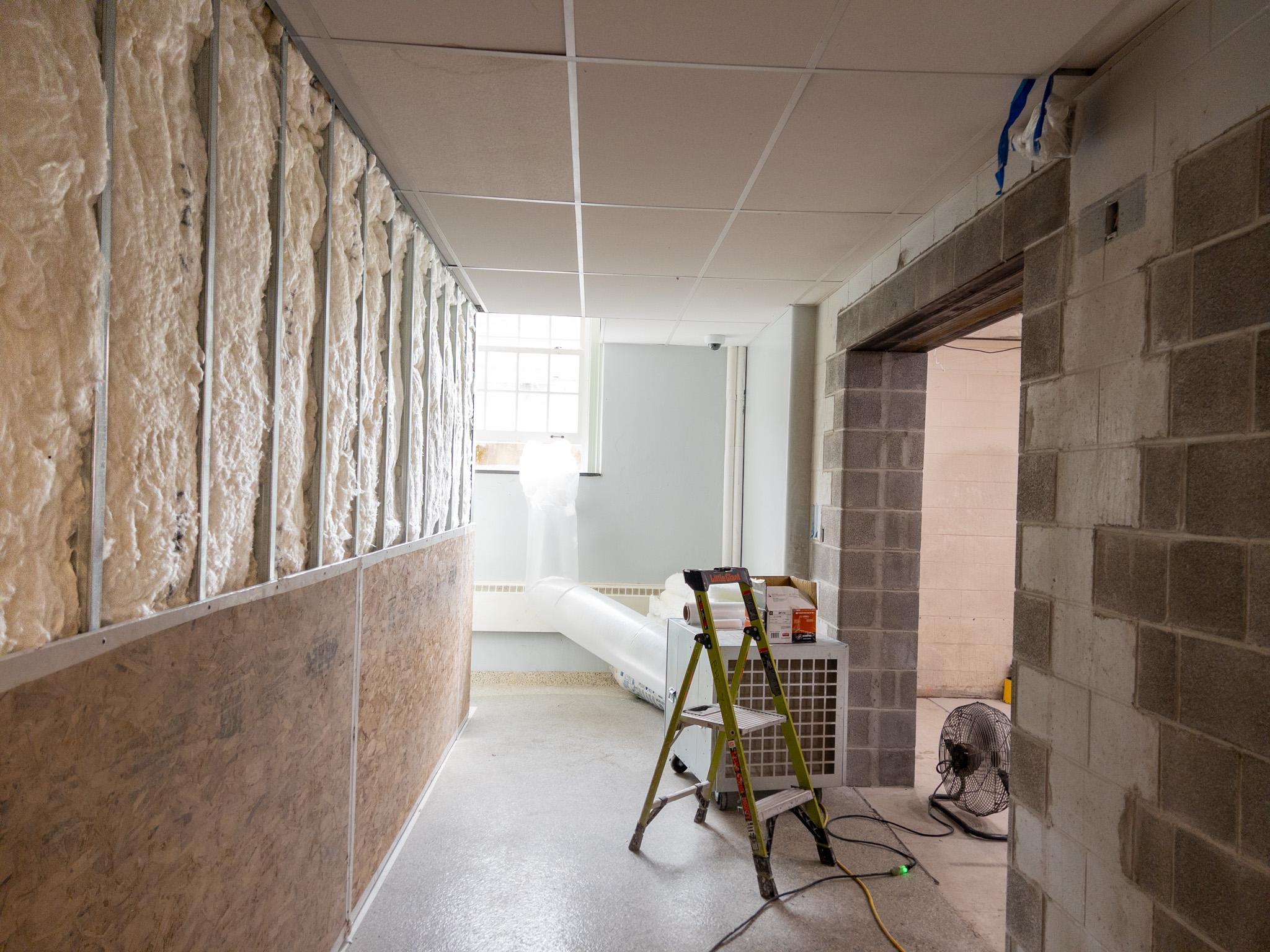

Space will be expanded at the school-based health center to provide free well-care and dental services to students. The new design will include the required wet and dry areas to ensure a safe environment. Health services support student learning and participation in athletics. Bids for this portion of the project were awarded in March with work began in May 2026.

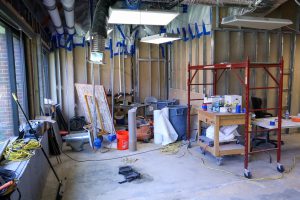

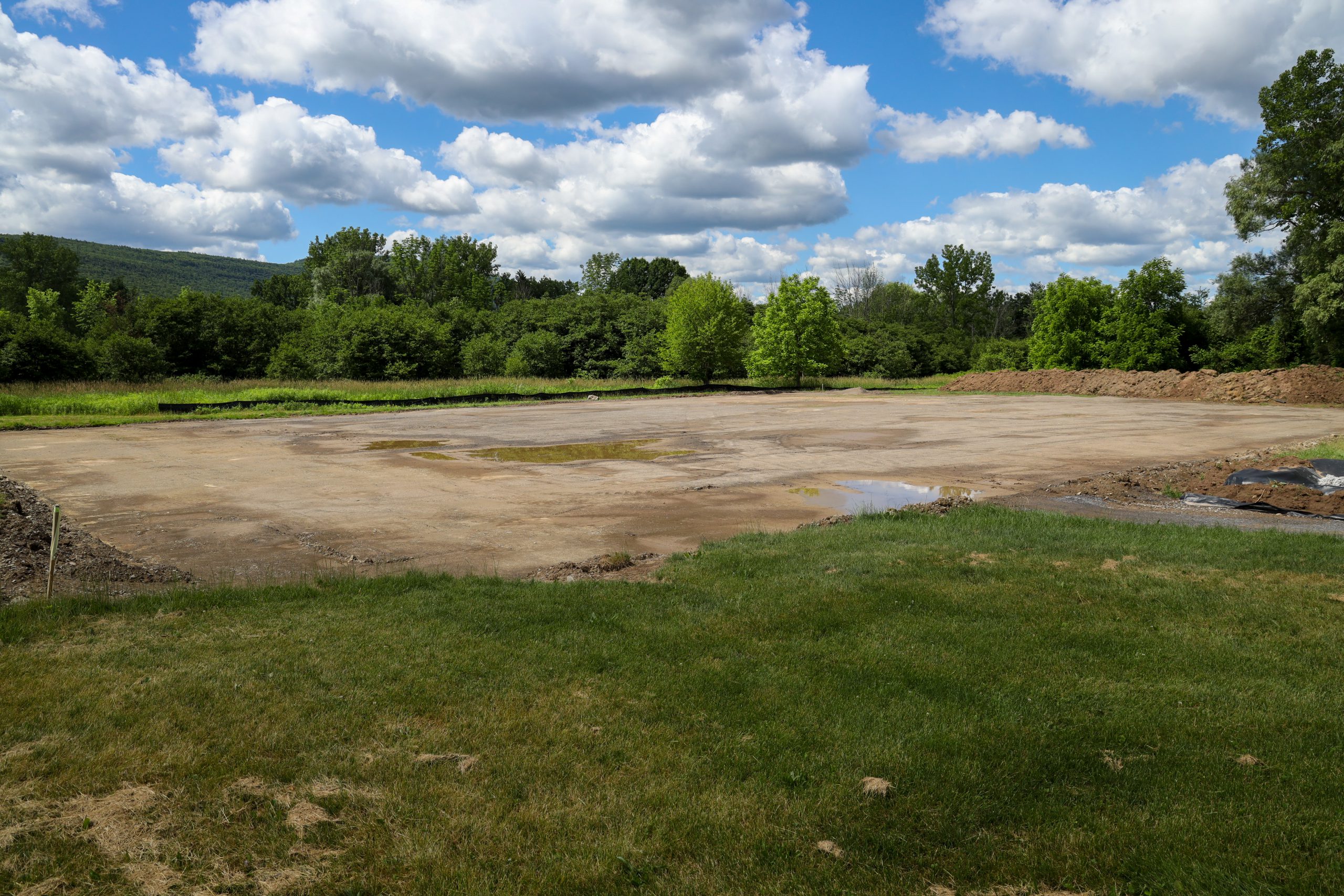

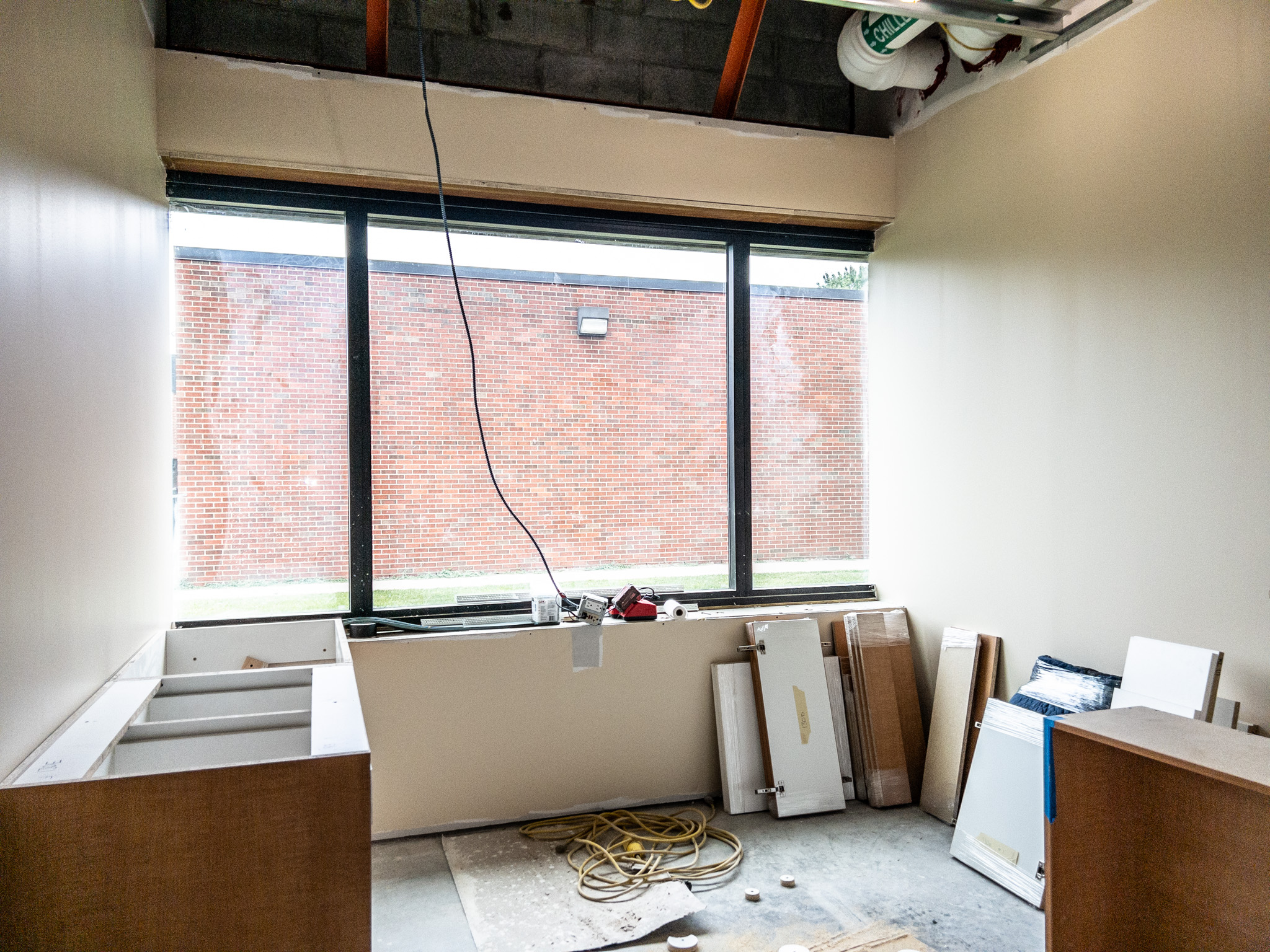

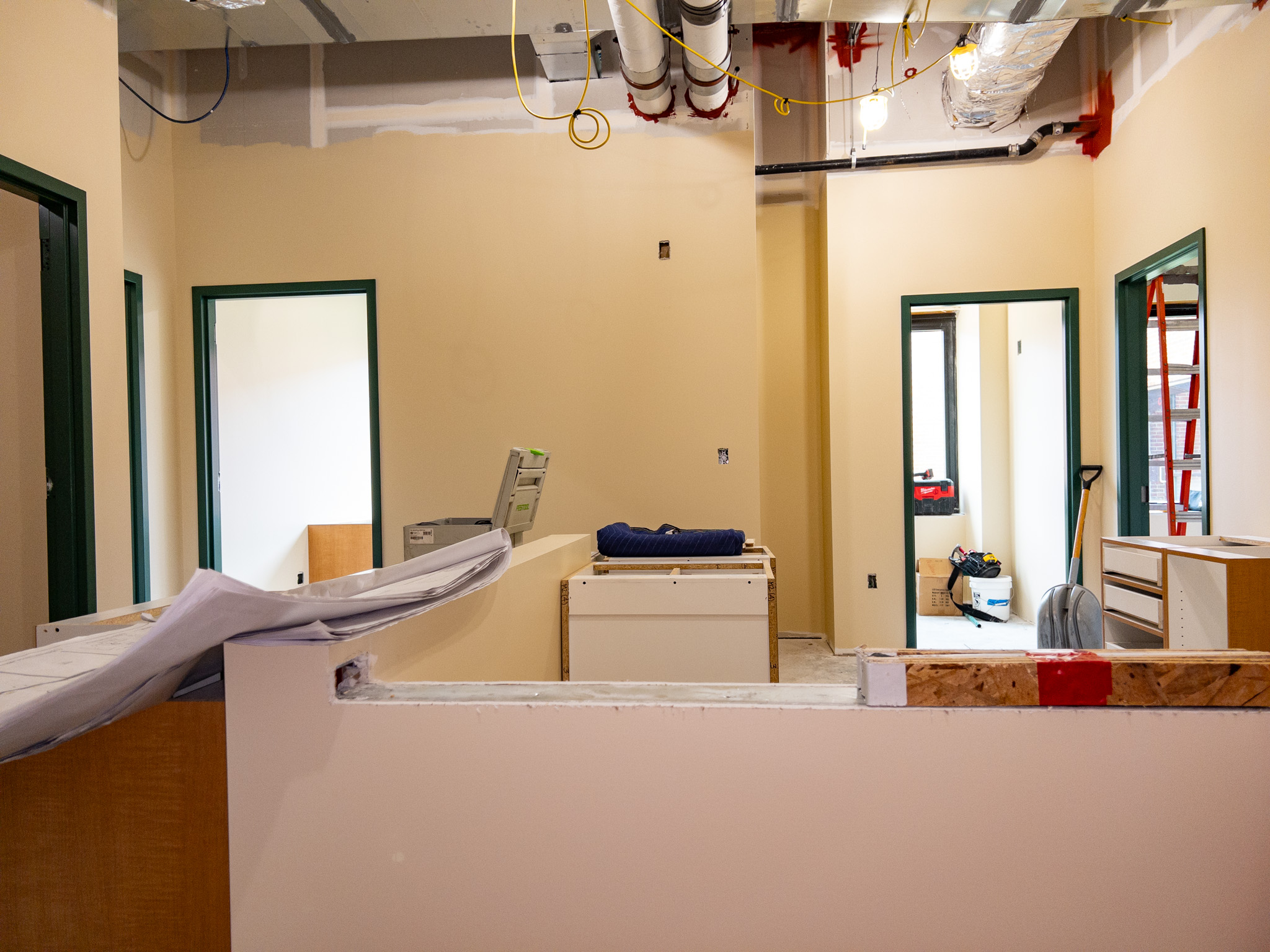

June 2026 Health Center Construction Progress

Playground

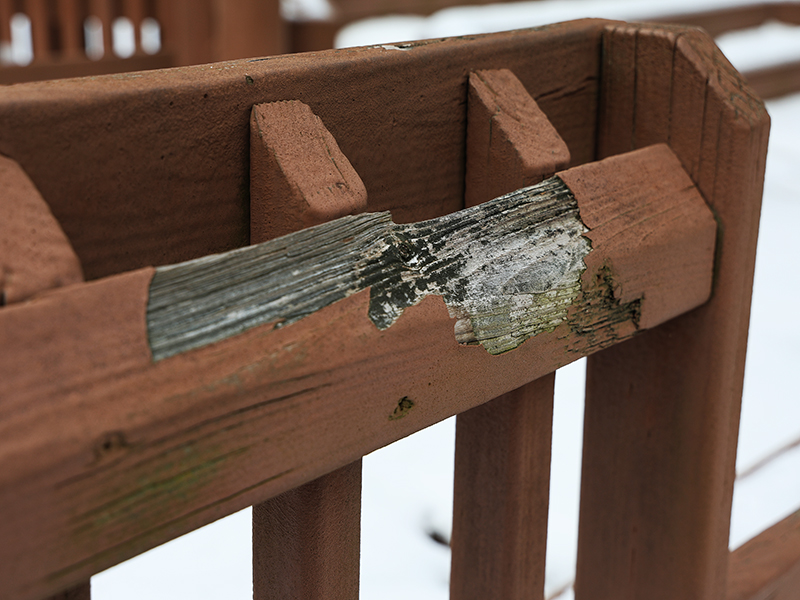

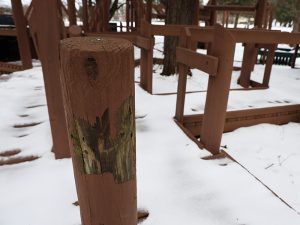

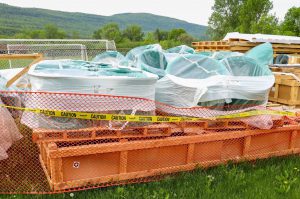

In 1989, the Middleburgh community came together for five days of ‘labor and love’ to build the iconic Maze Craze playground. As we look toward the 2026 Capital Project and the creation of a new, fully accessible play space, we invite you to look back at the incredible community spirit that started it all. Read The Maze Craze: Community Construction Leaves a Lasting Legacy and how the playground continues to inspire our vision for a barrier-free future for all students.

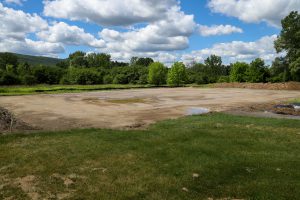

With community input helping to guide the process, the district will construct a new playground on the former Little League field — to meet current codes and create joyful, barrier-free experiences for every MCS student. Weather permitting, the district will welcome children to the new playground in October 2026.

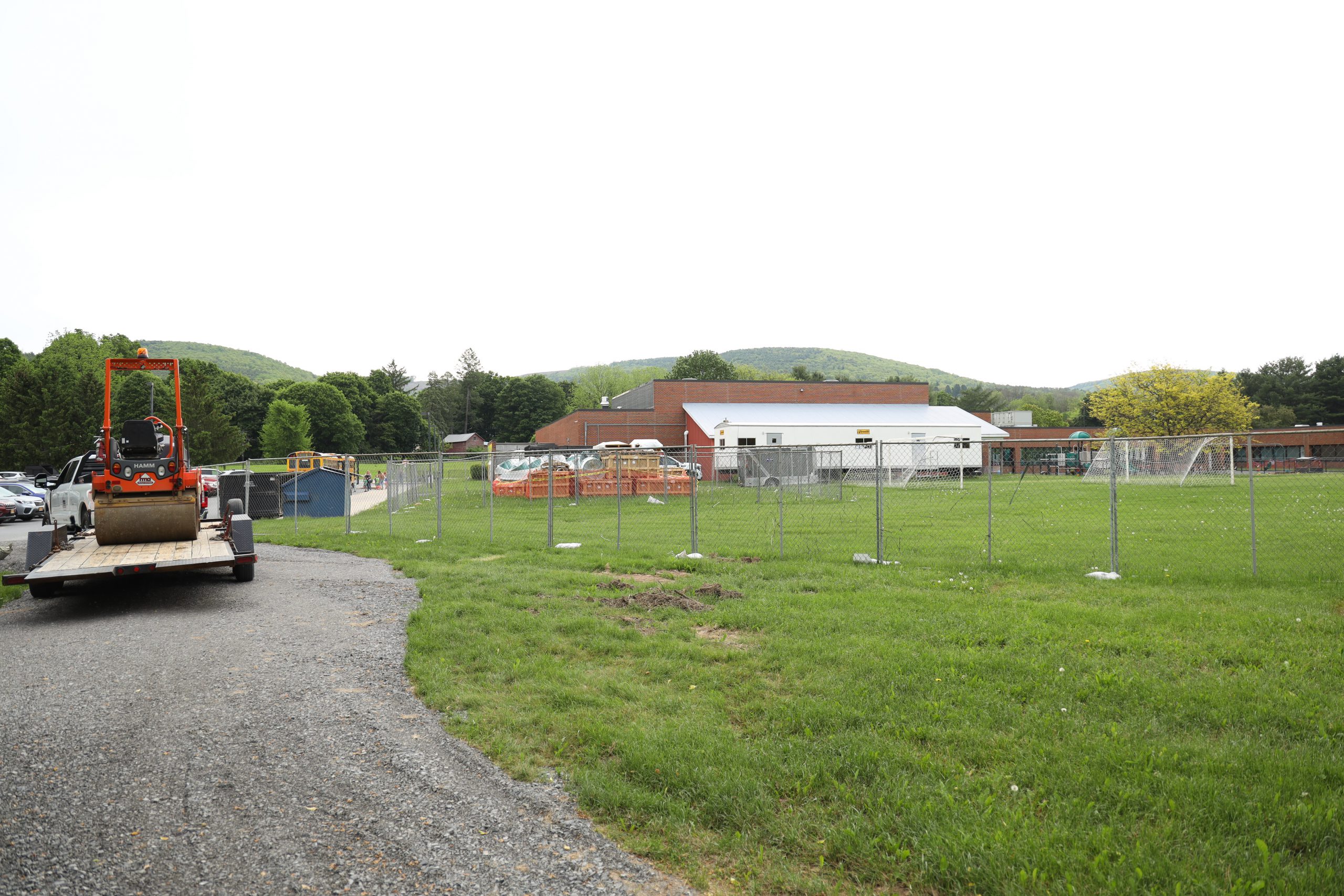

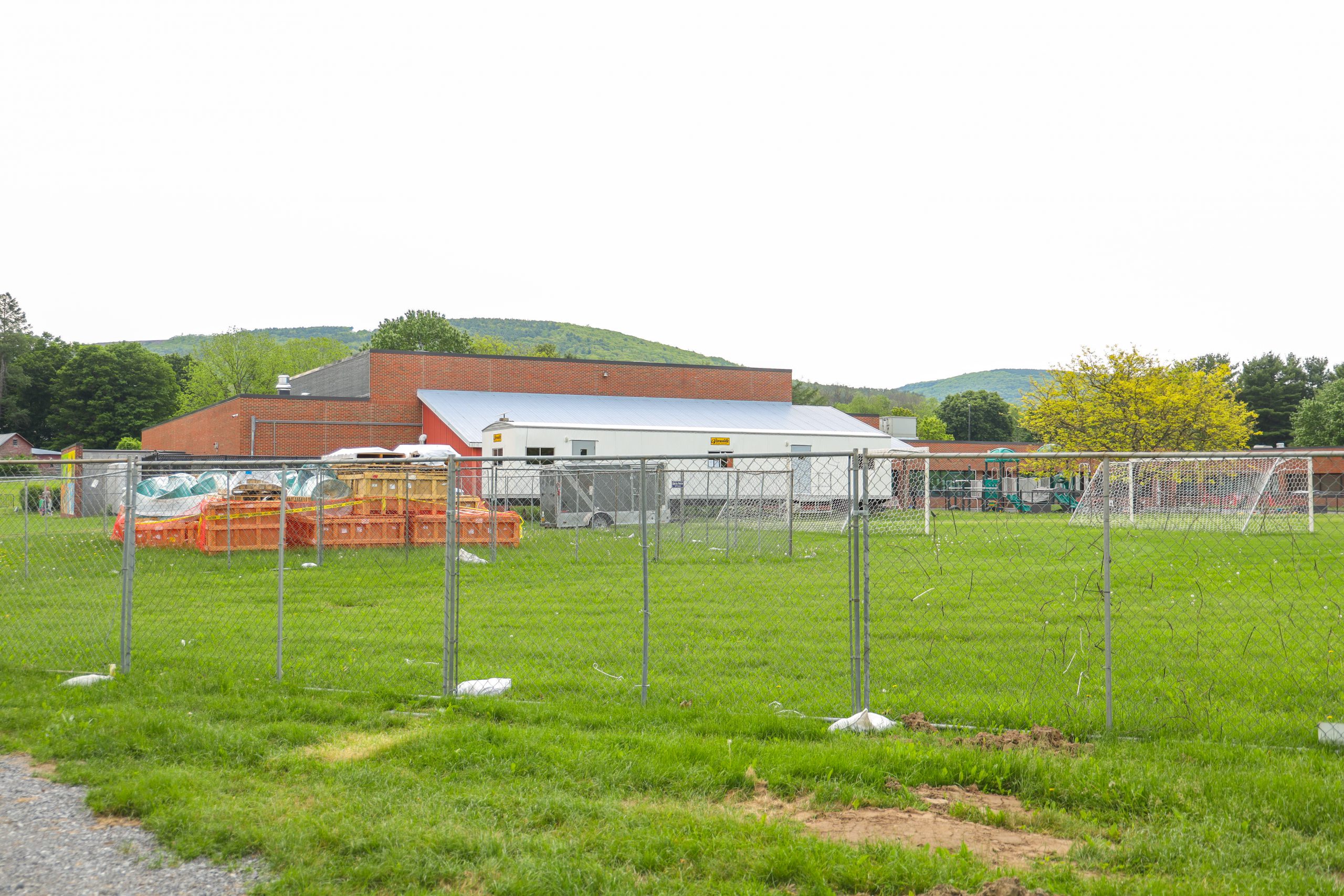

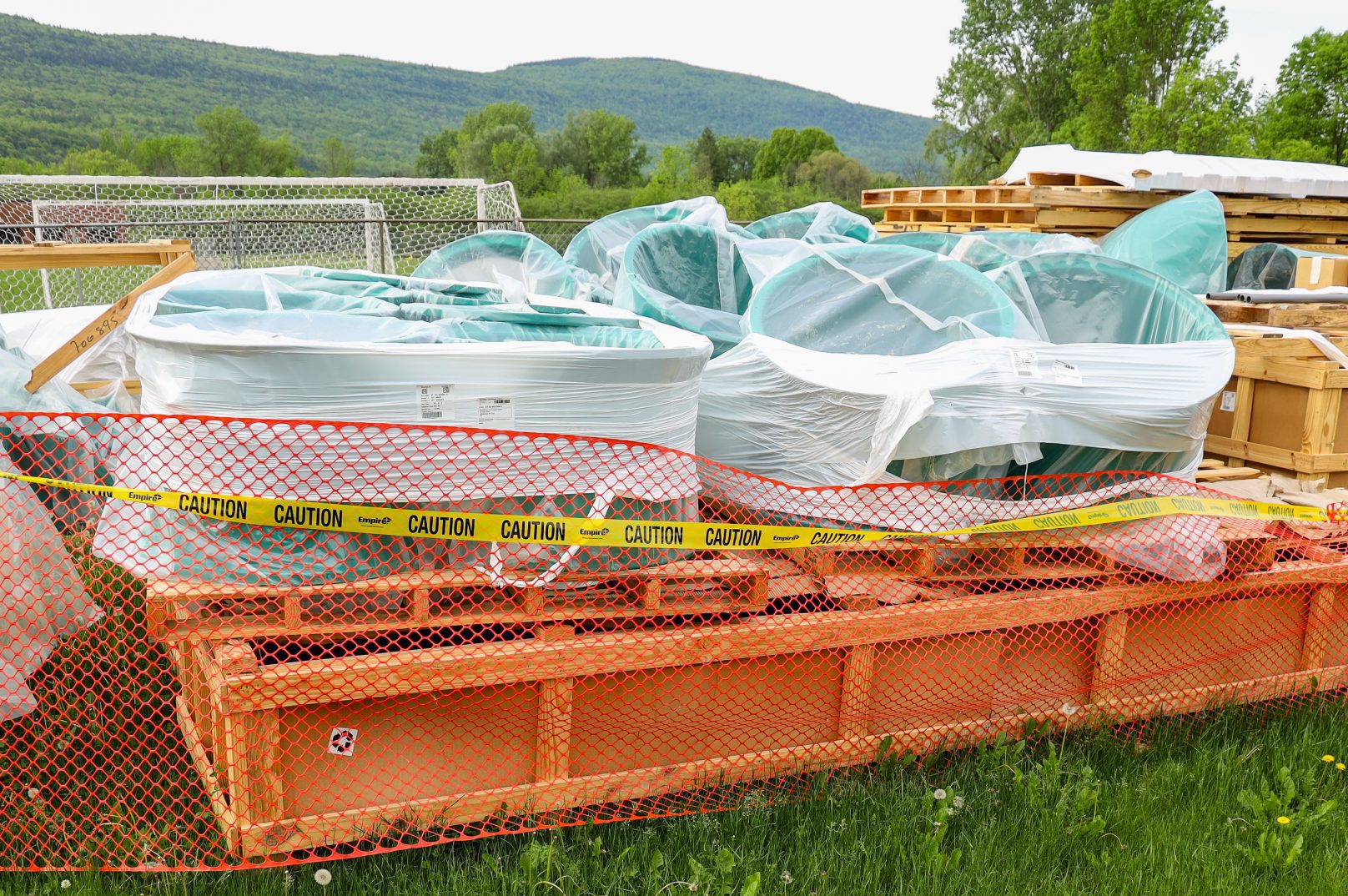

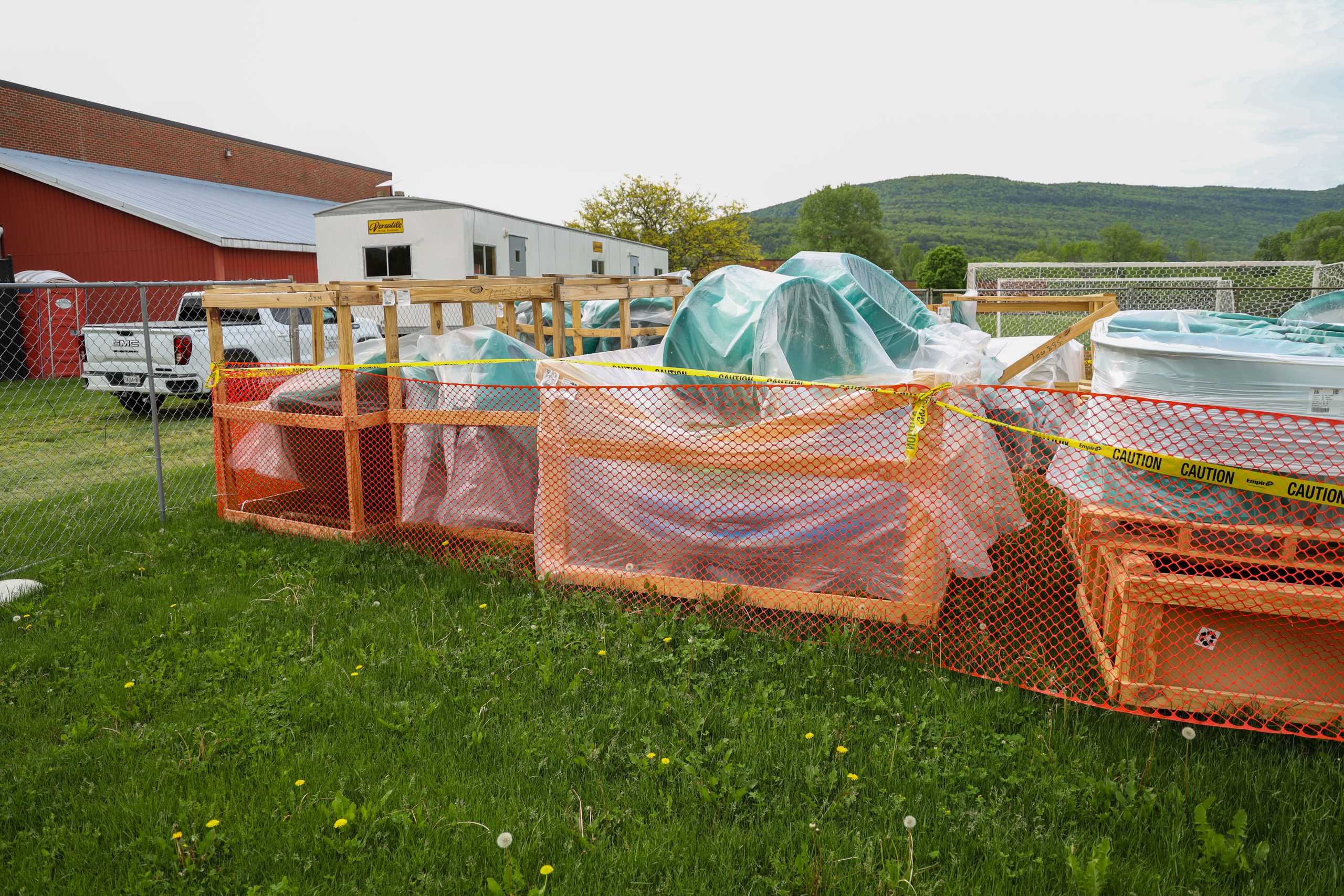

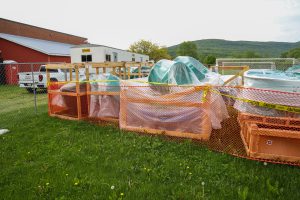

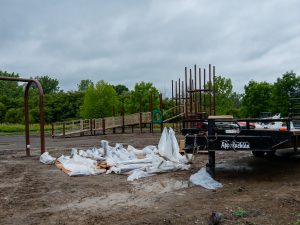

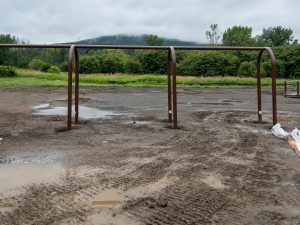

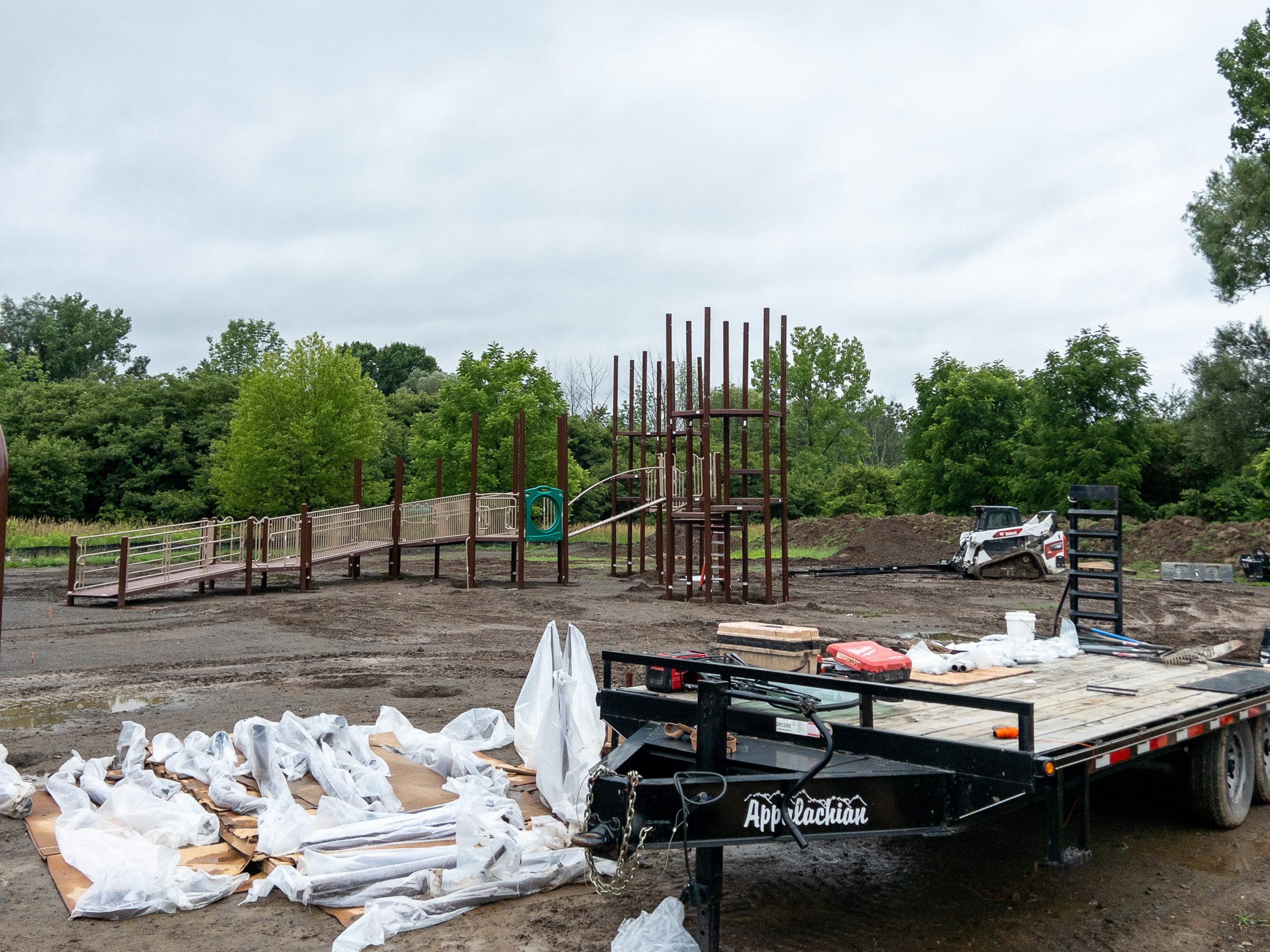

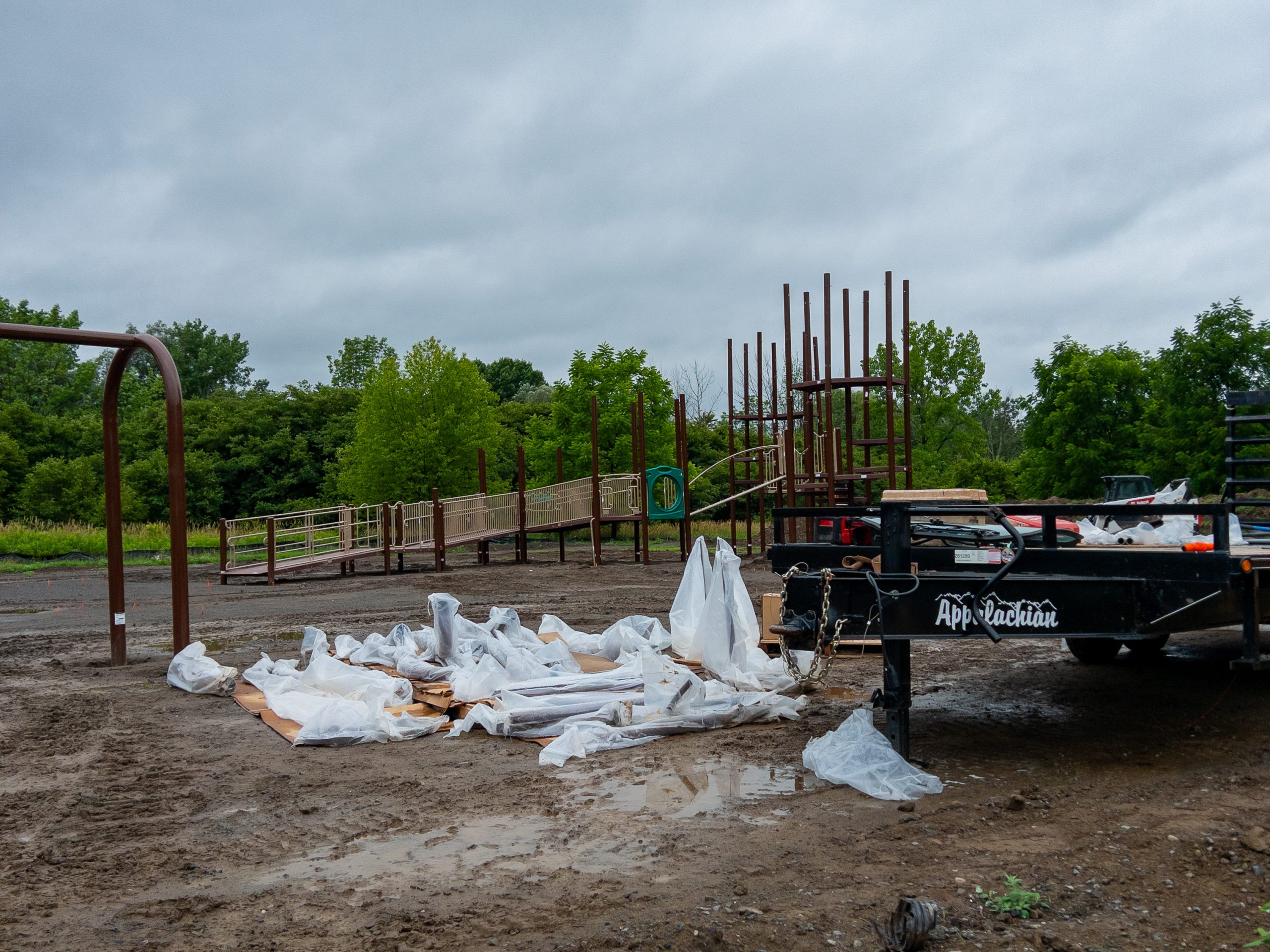

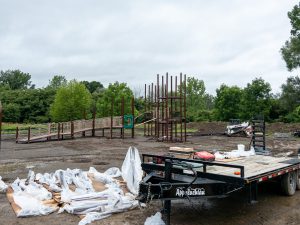

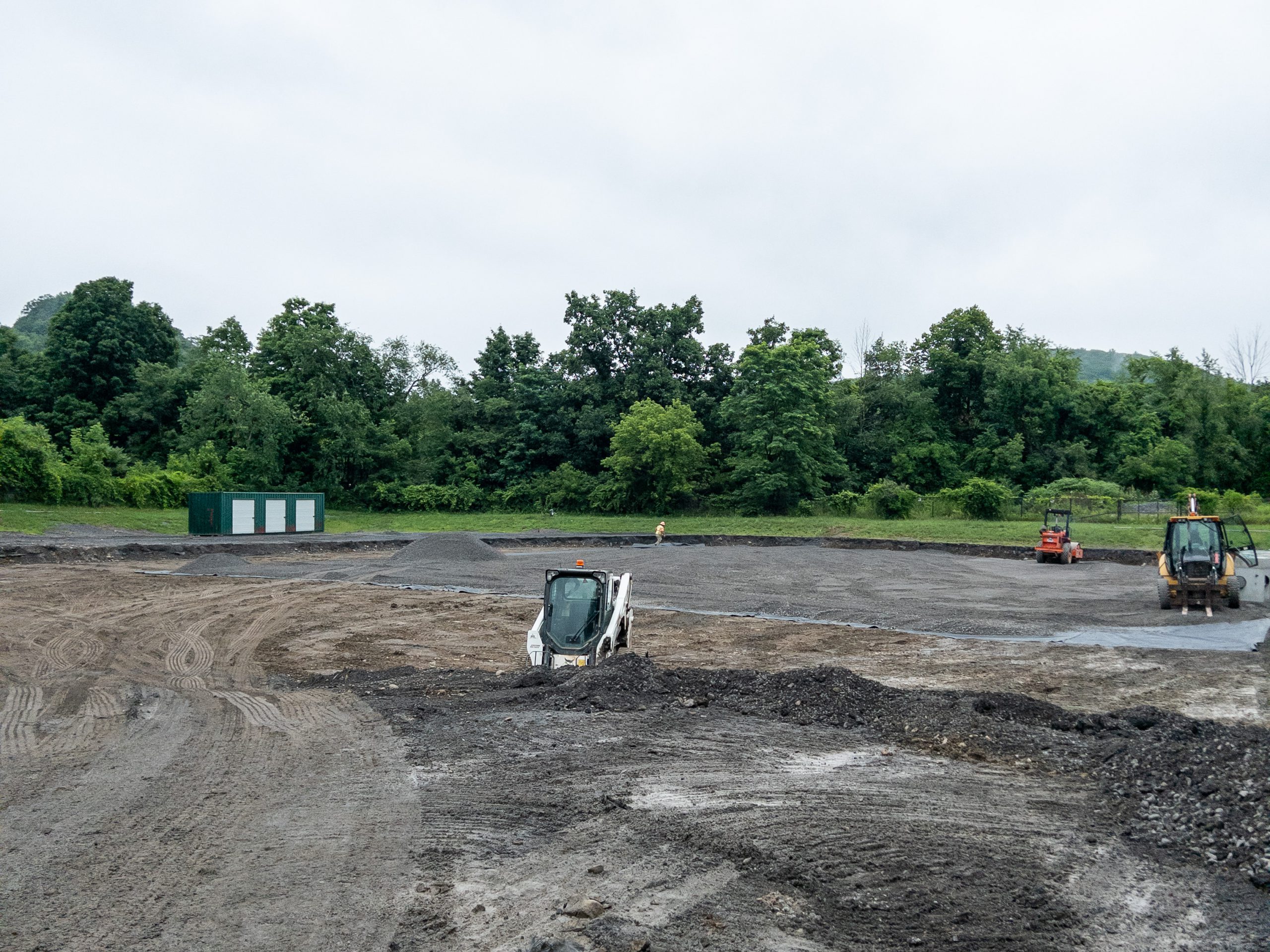

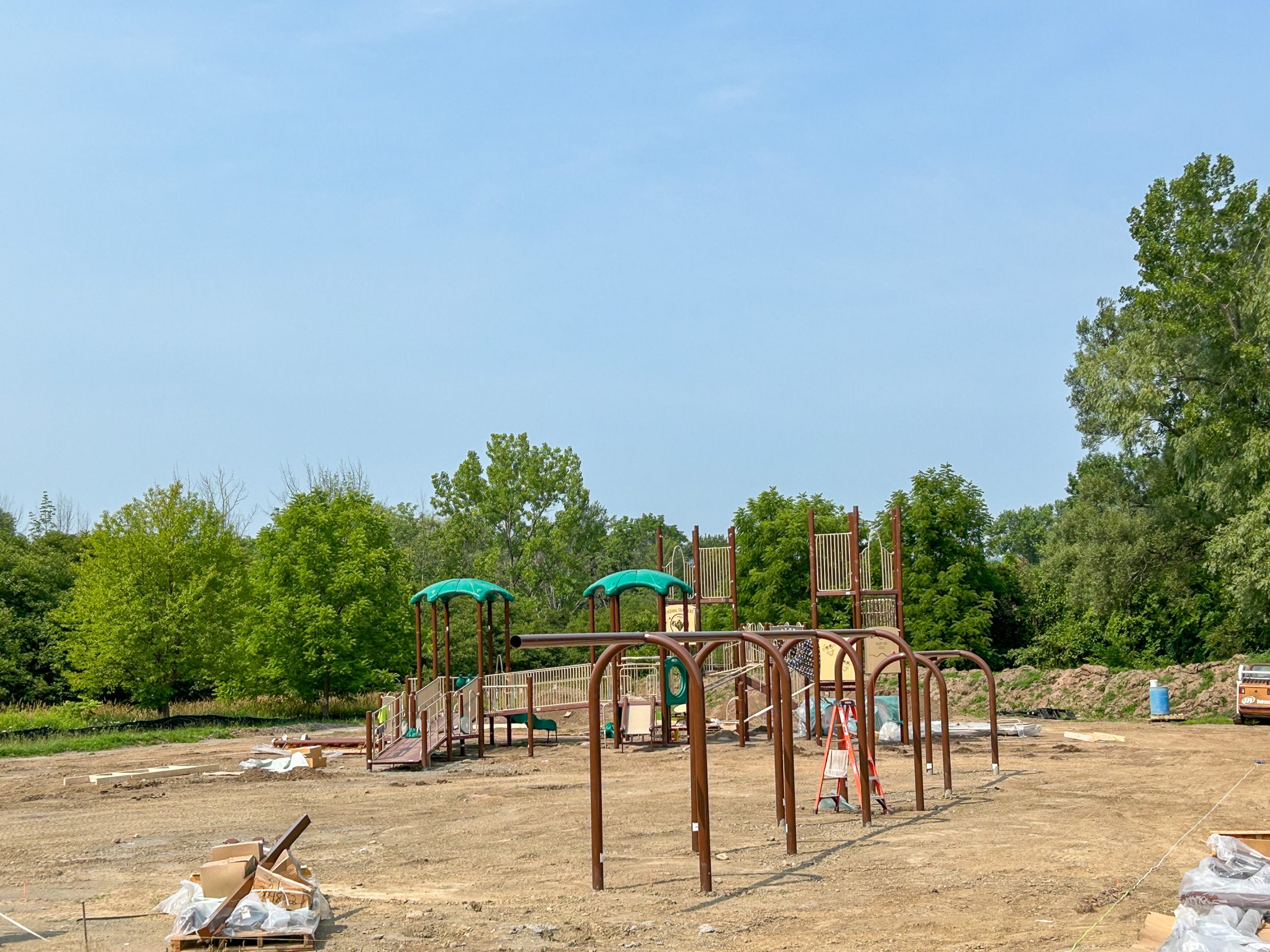

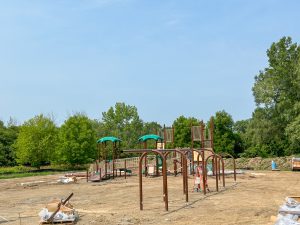

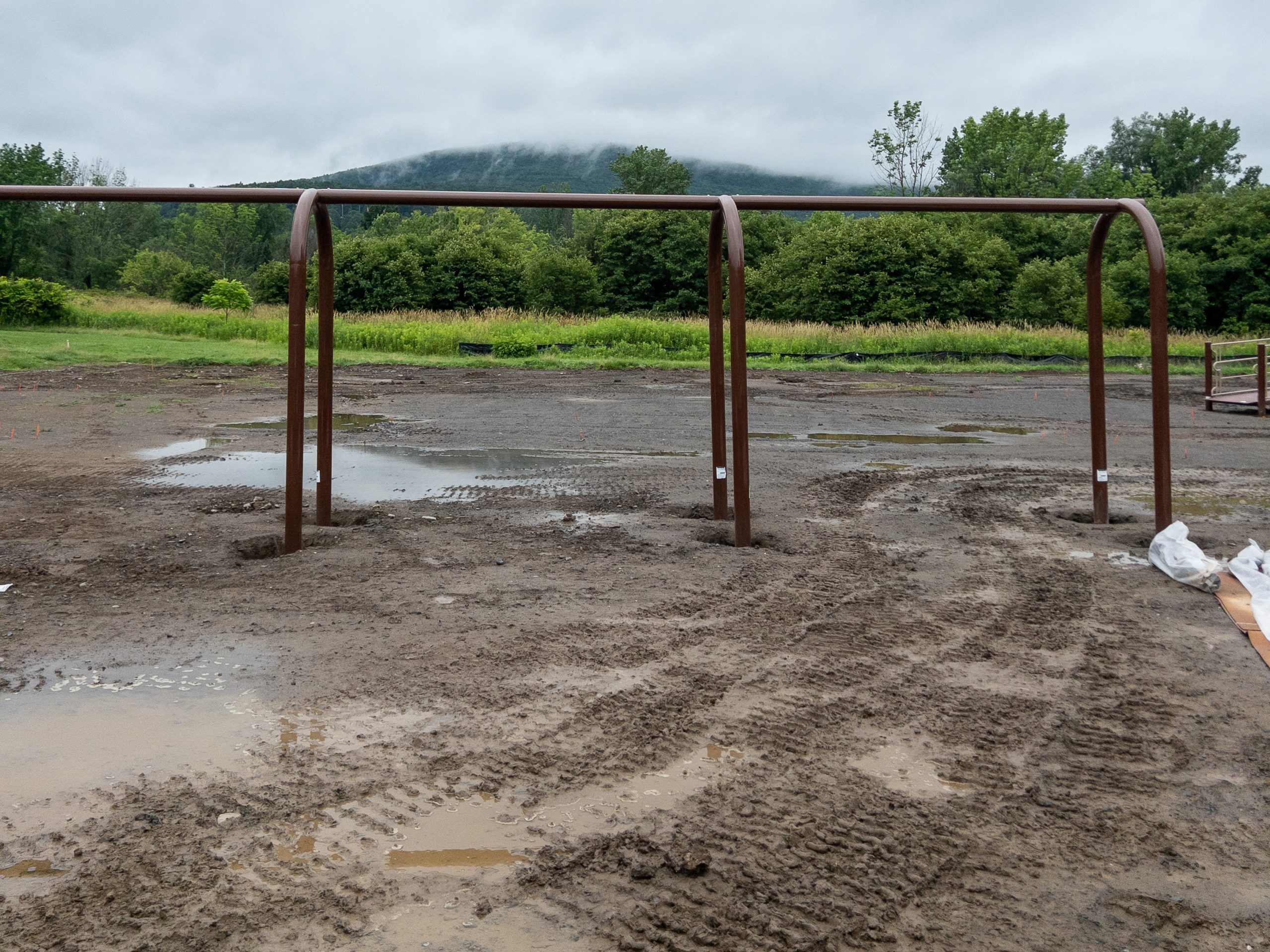

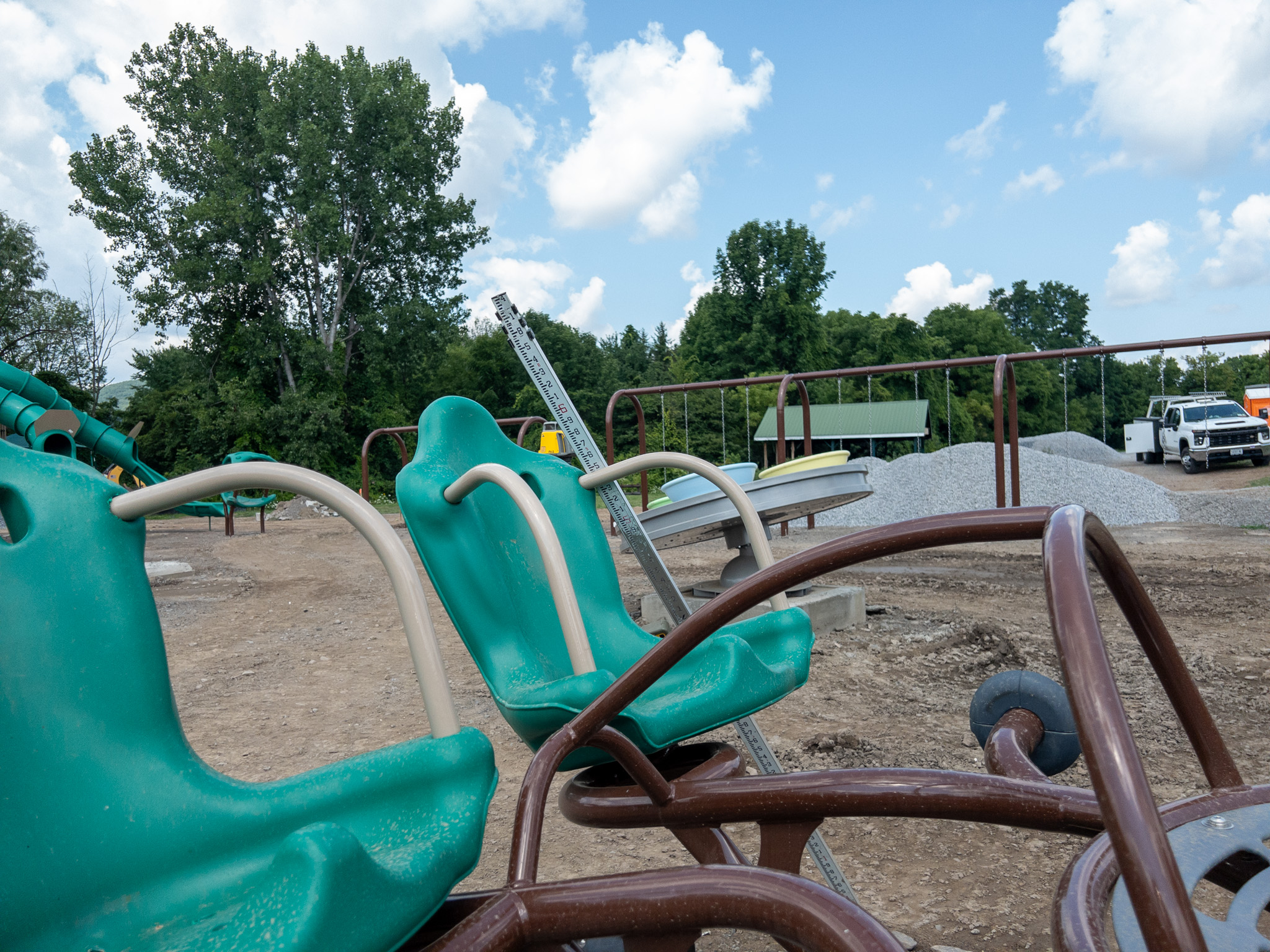

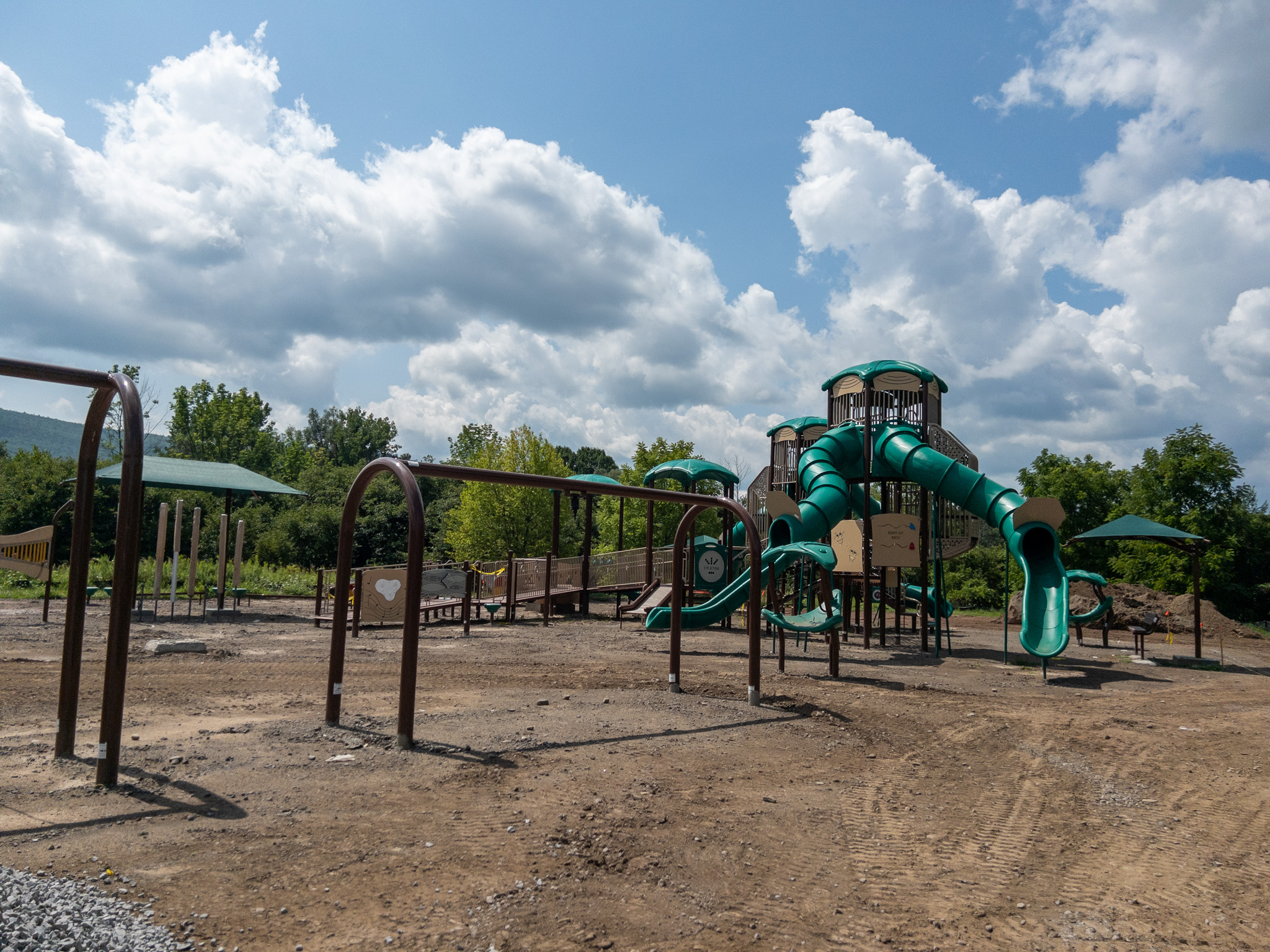

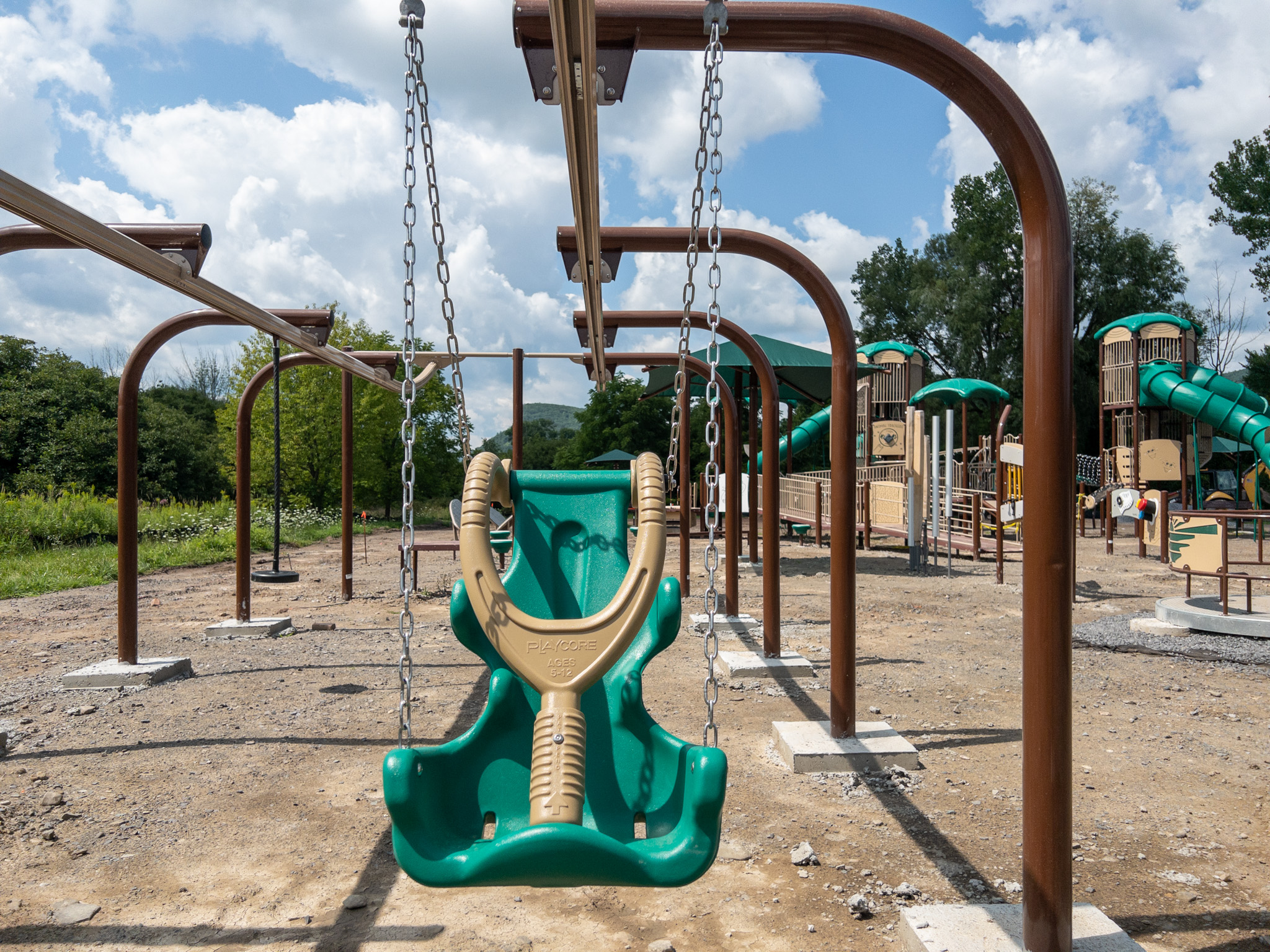

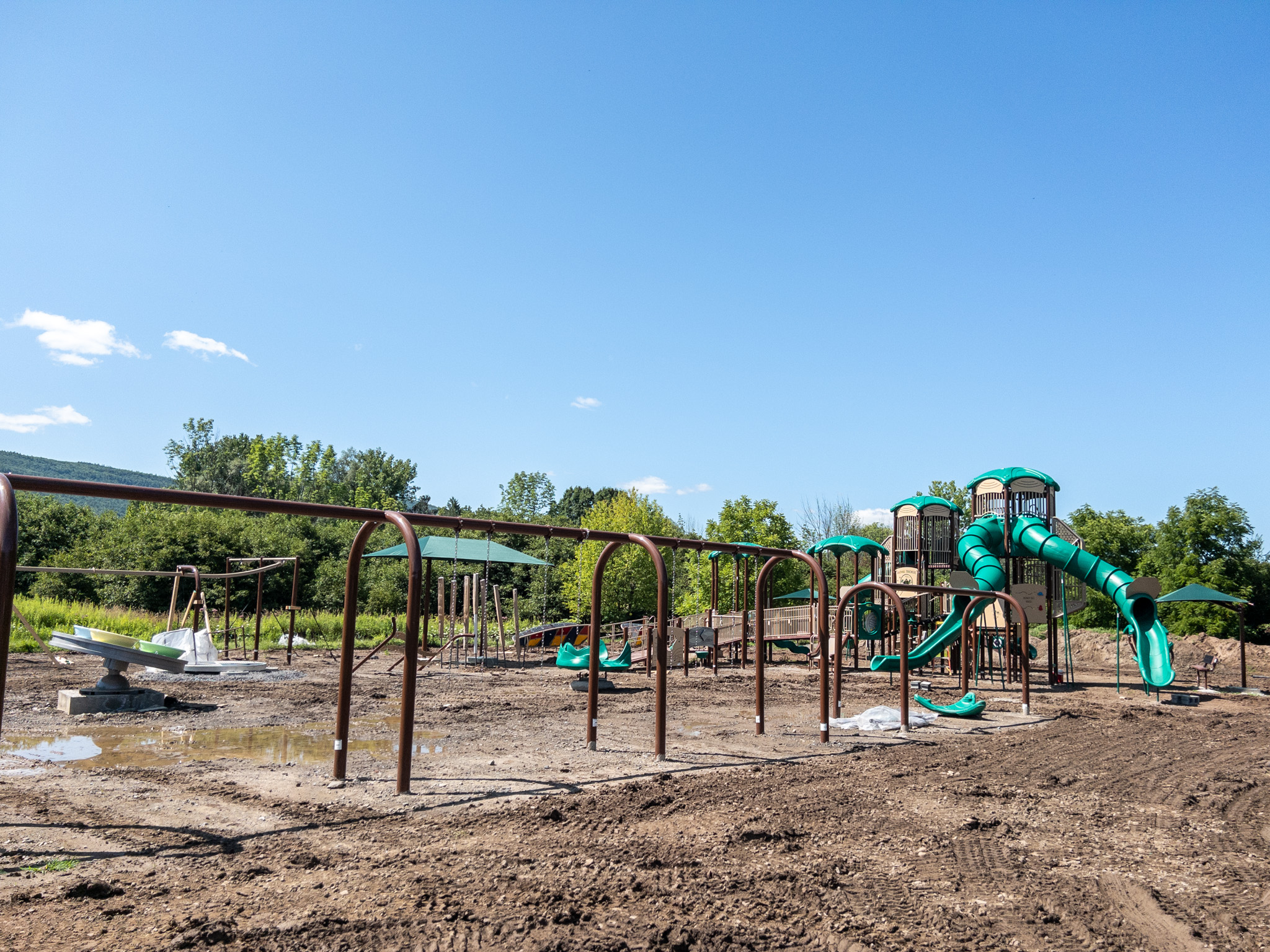

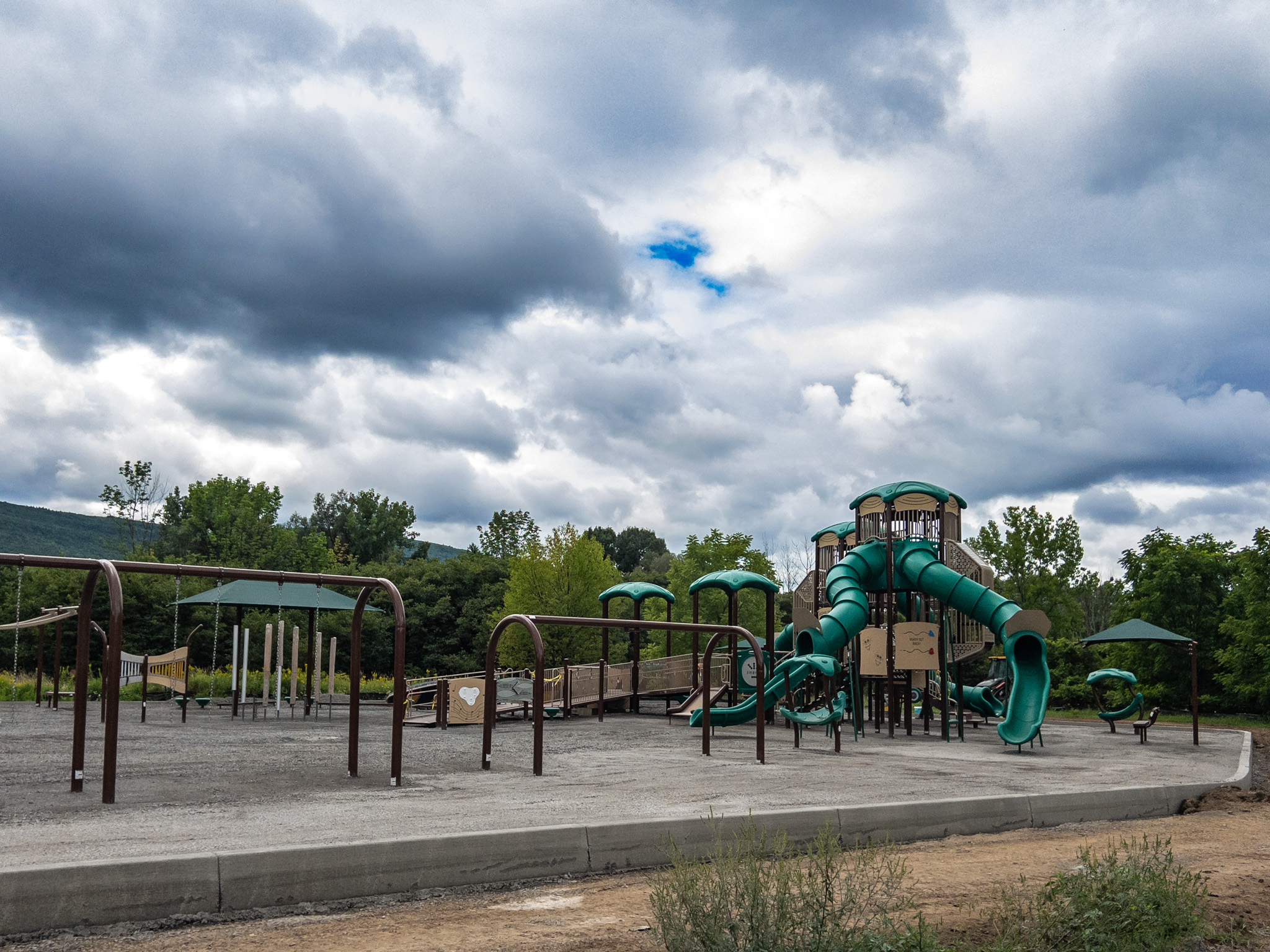

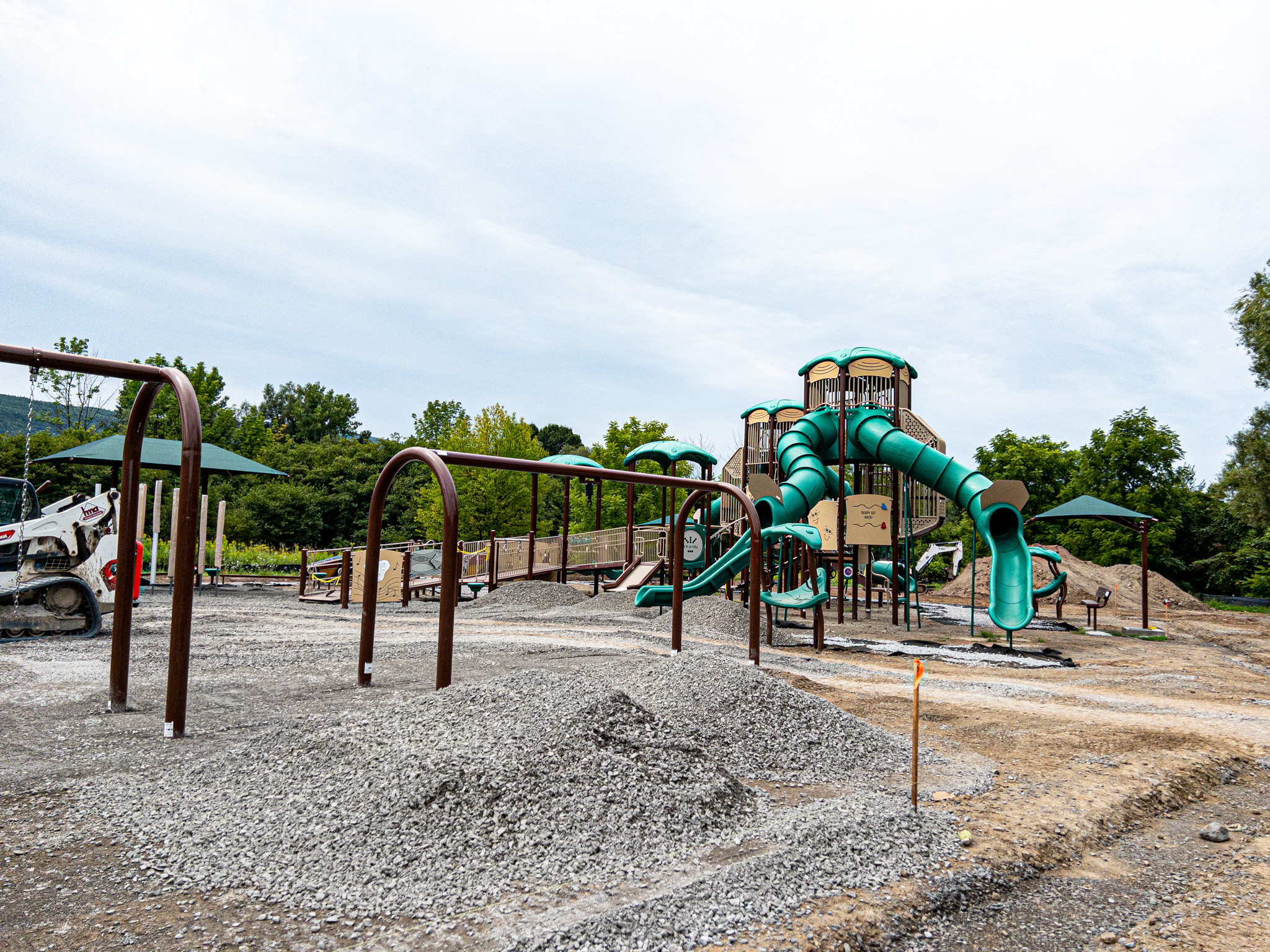

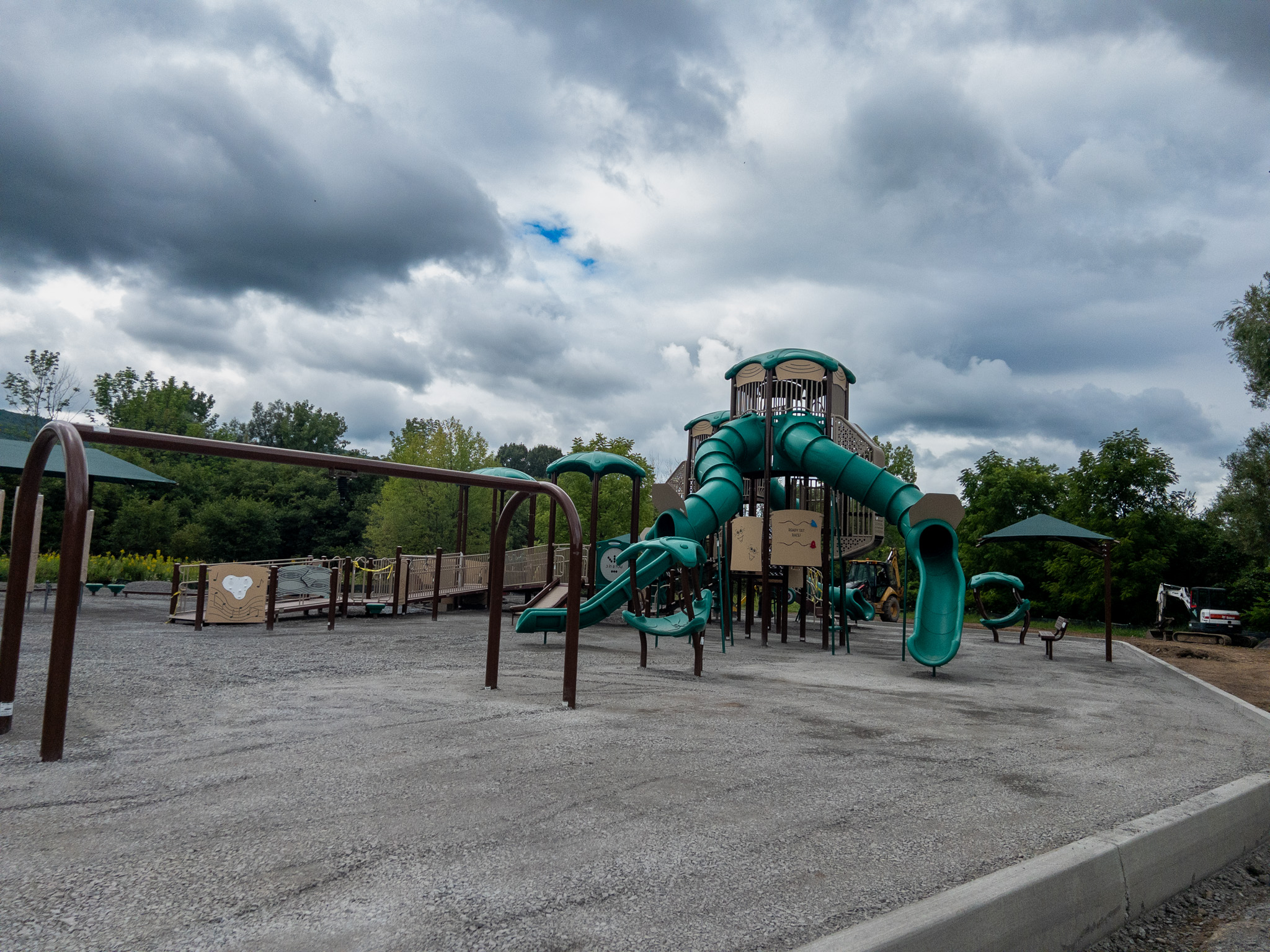

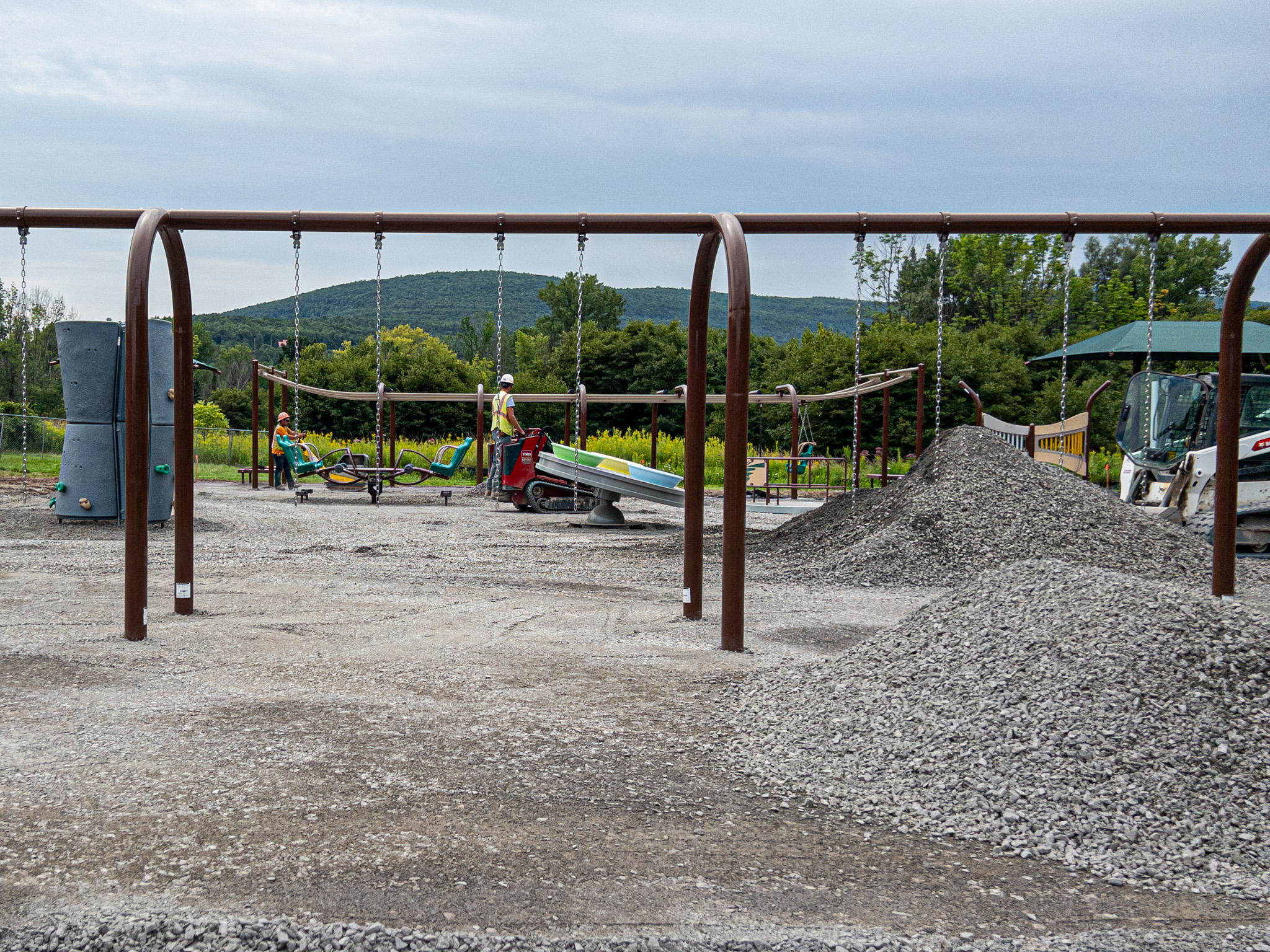

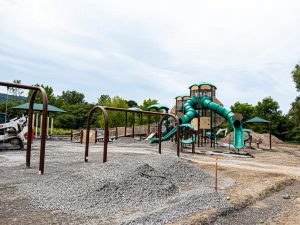

June 2026 Playground Construction Progress

Back to Top

Junior-Senior High School

The Junior-Senior High School is set to undergo critical facility upgrades to preserve its historic integrity and improve safety, efficiency and accessibility.

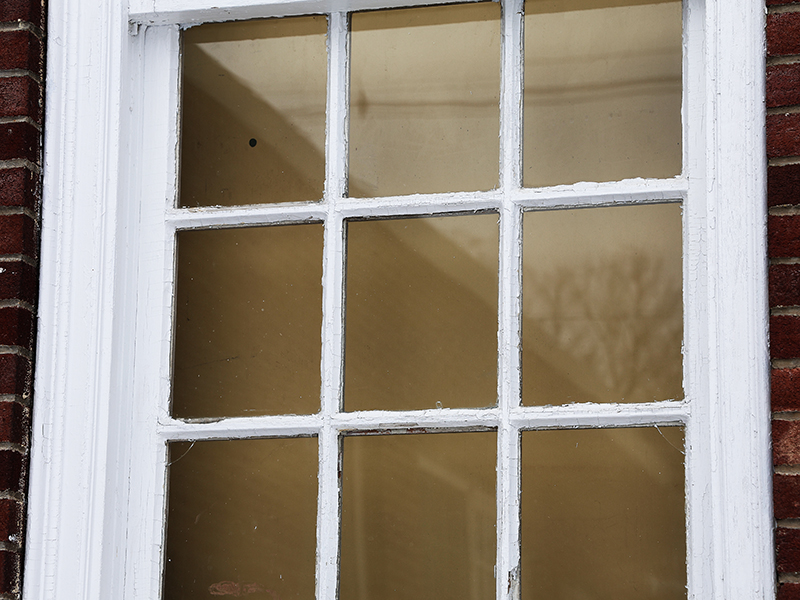

Efficient Windows

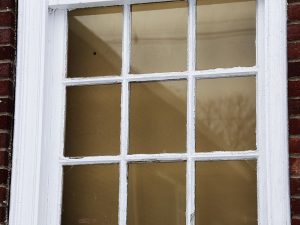

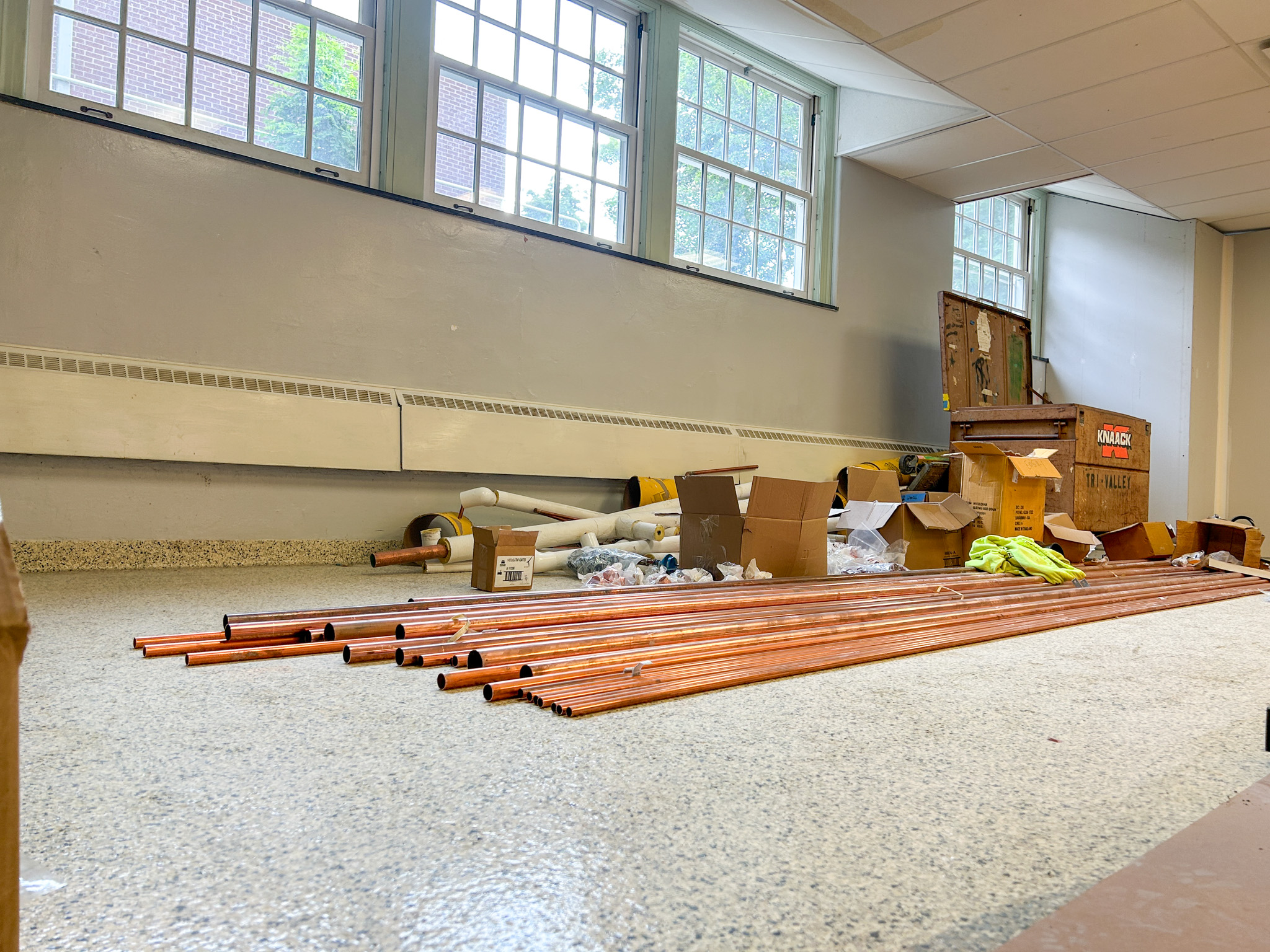

Stage and attic windows will be replaced with energy-efficient models that will reduce energy costs.

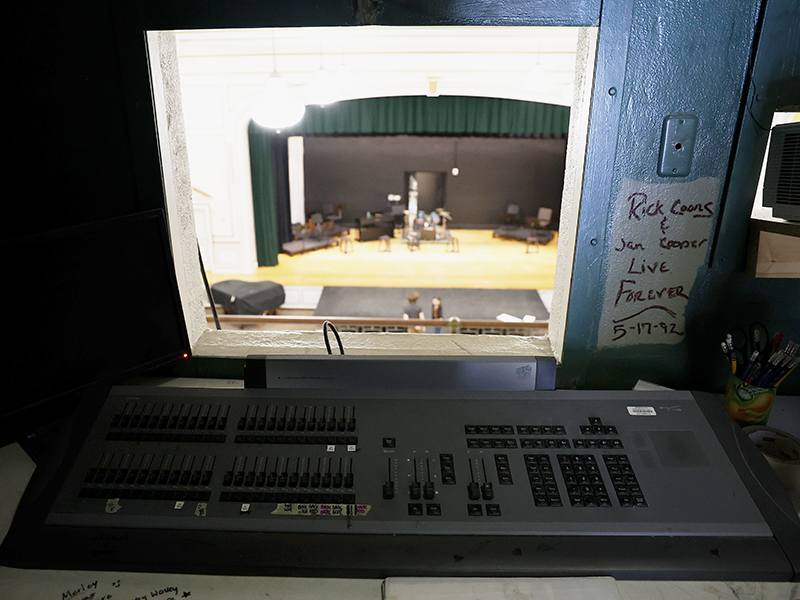

Auditorium

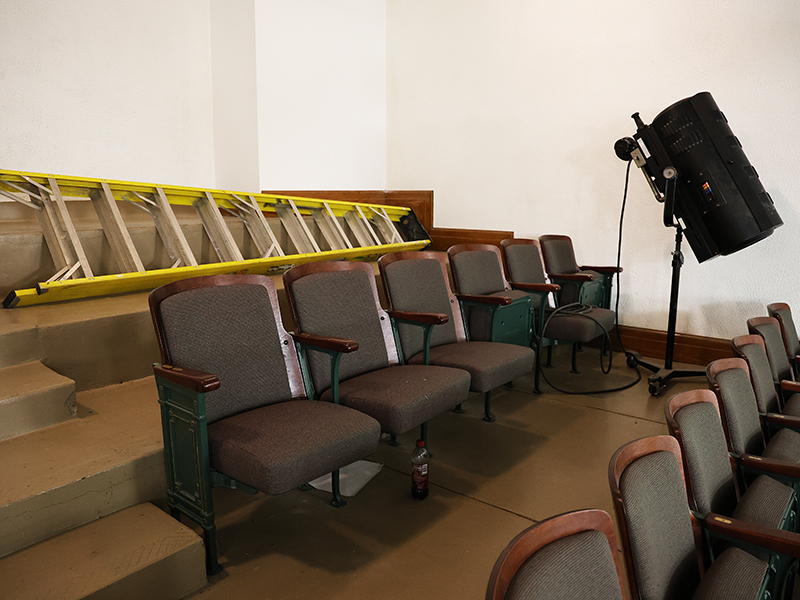

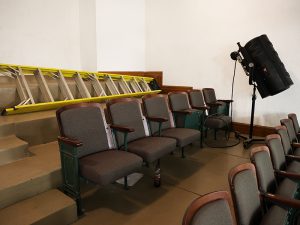

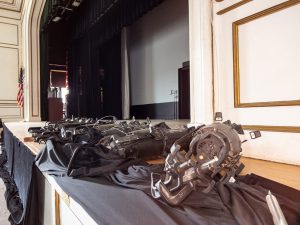

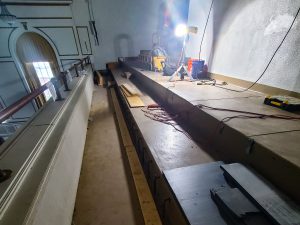

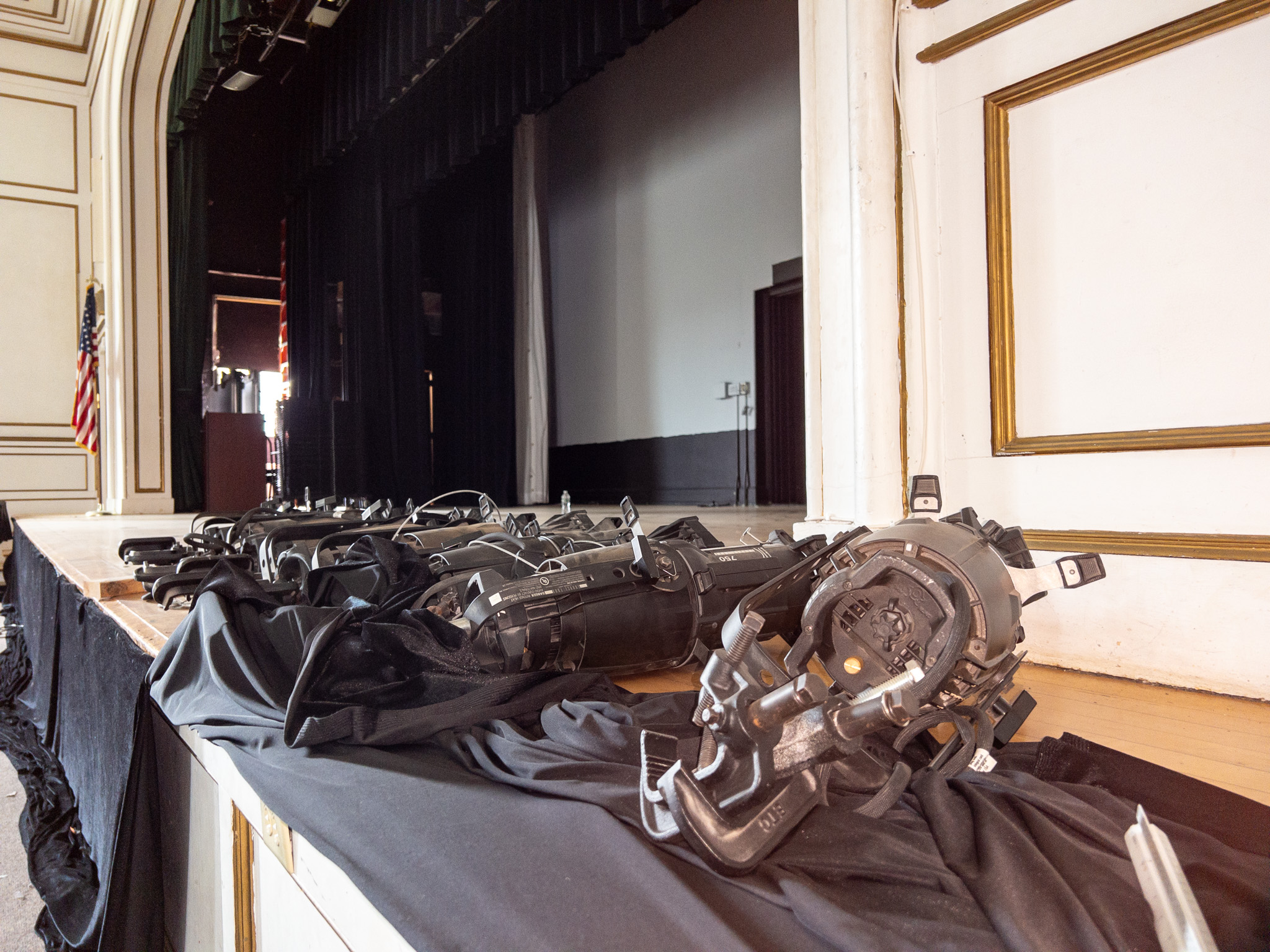

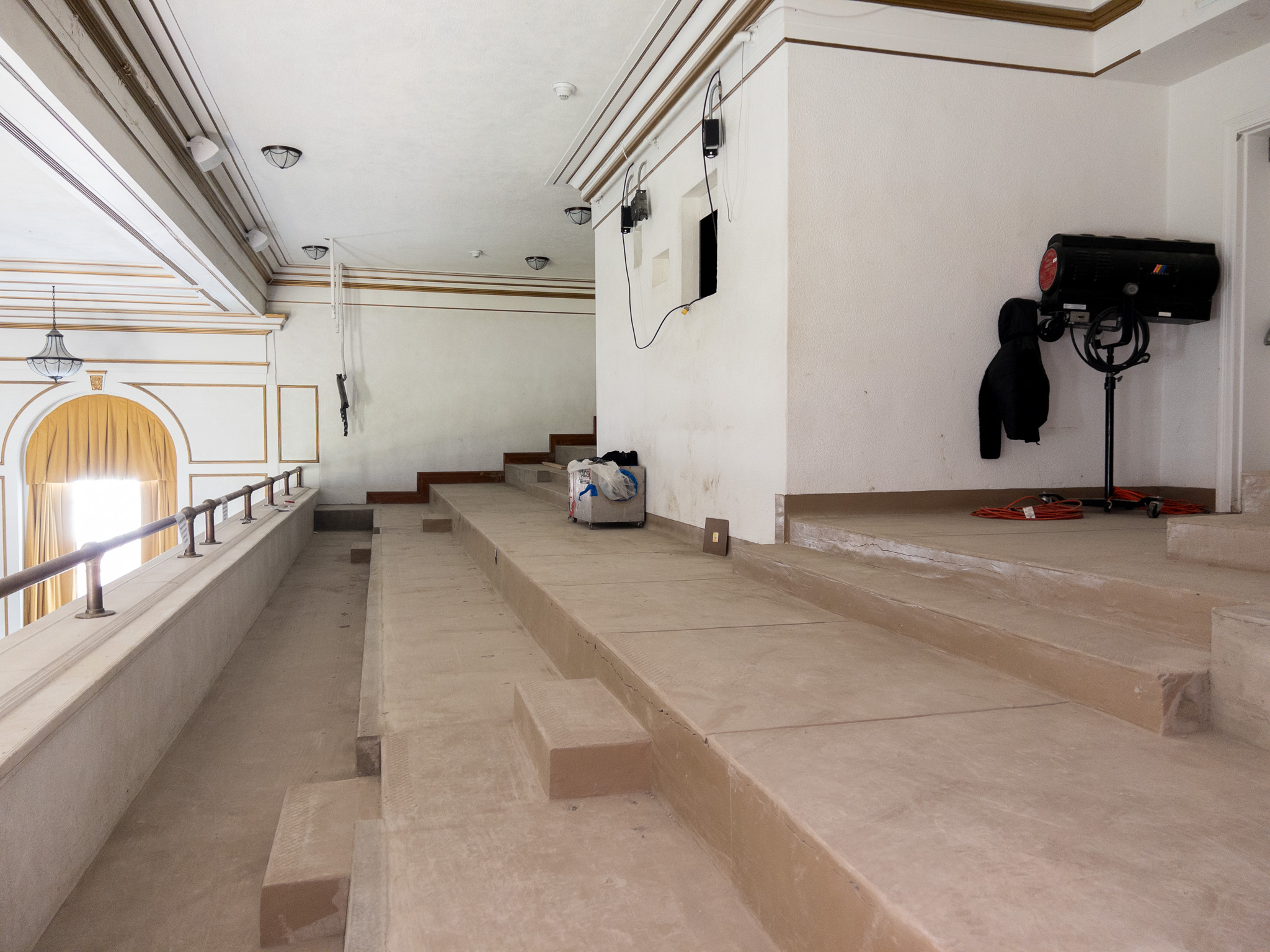

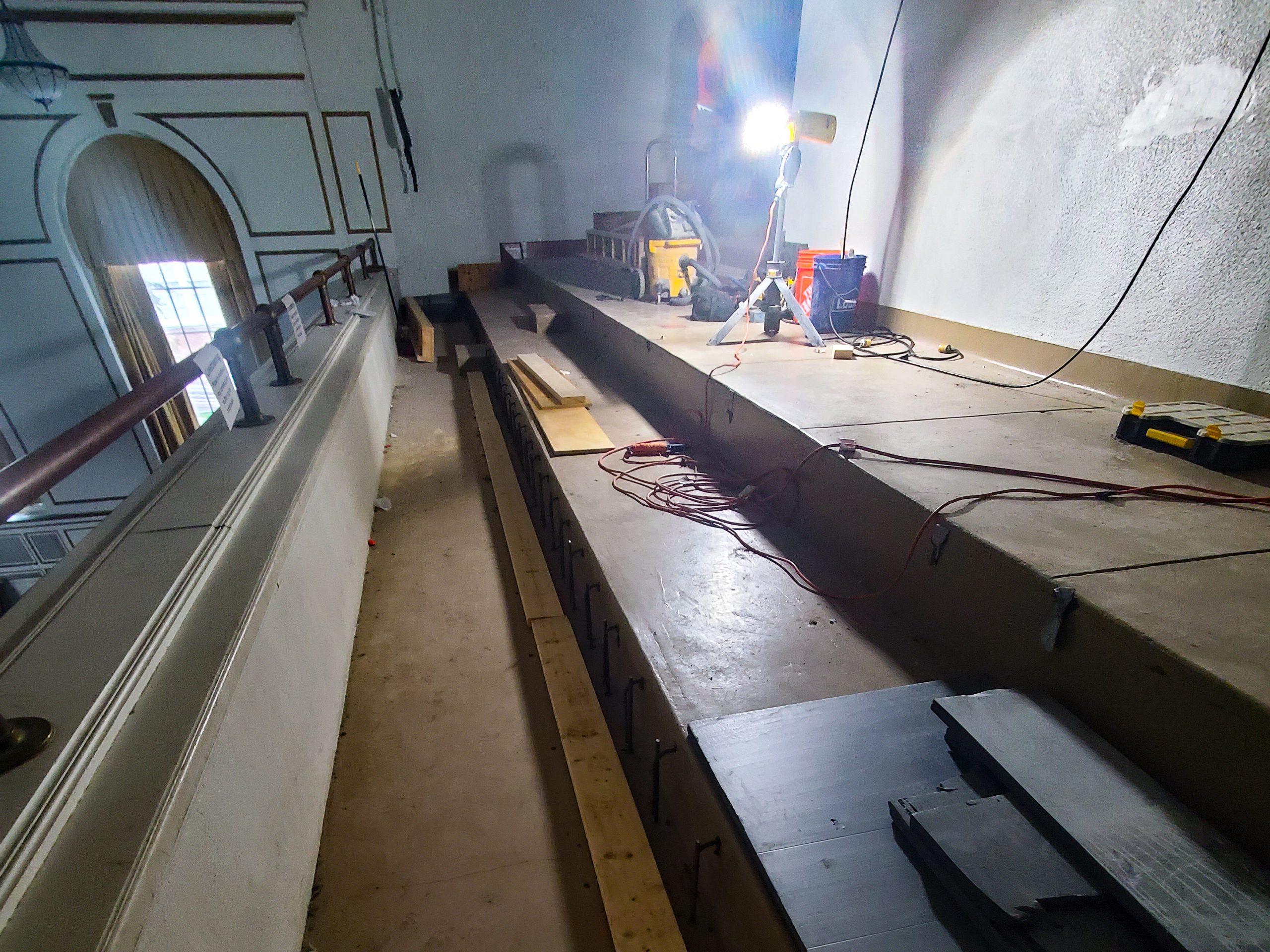

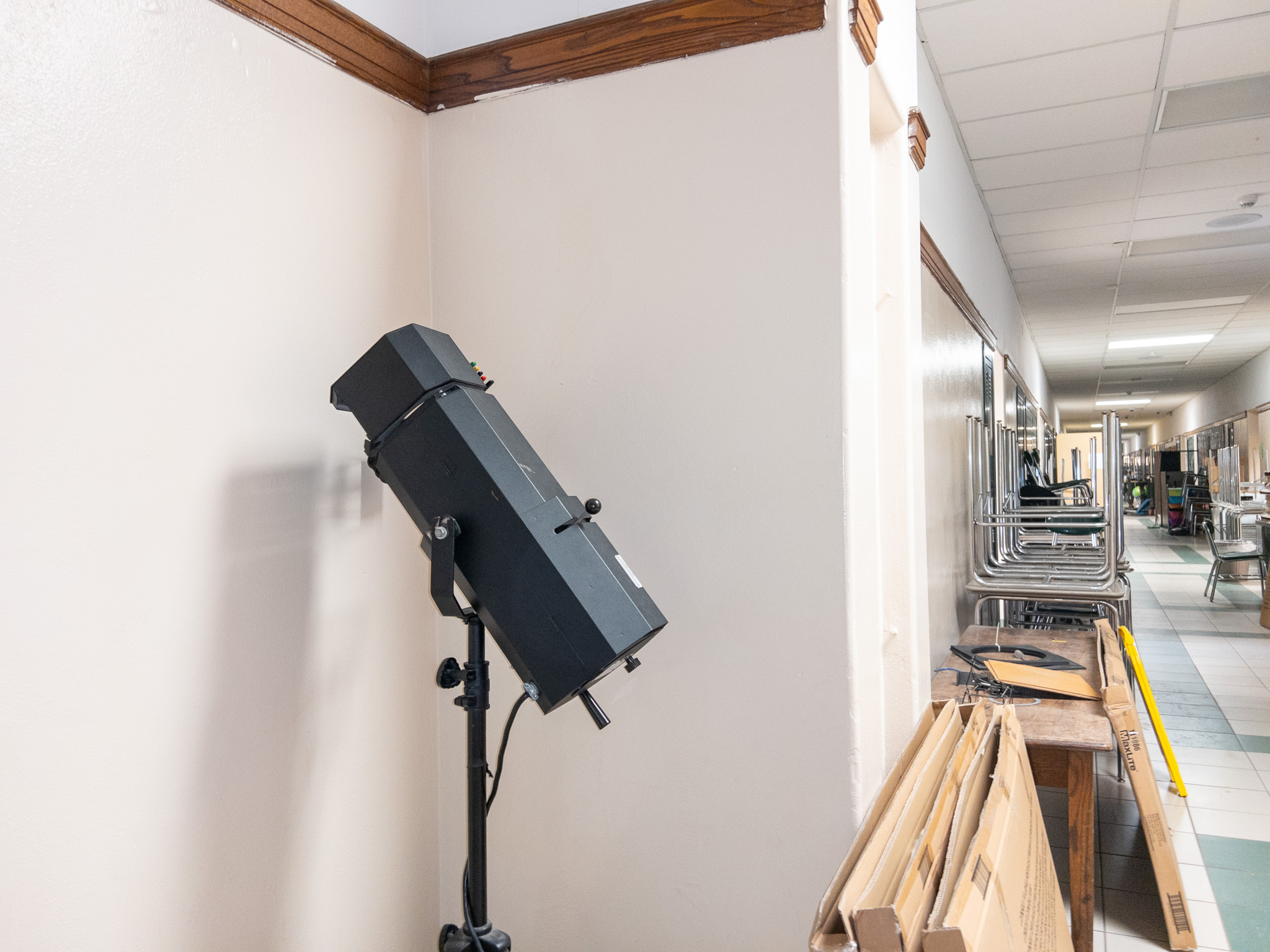

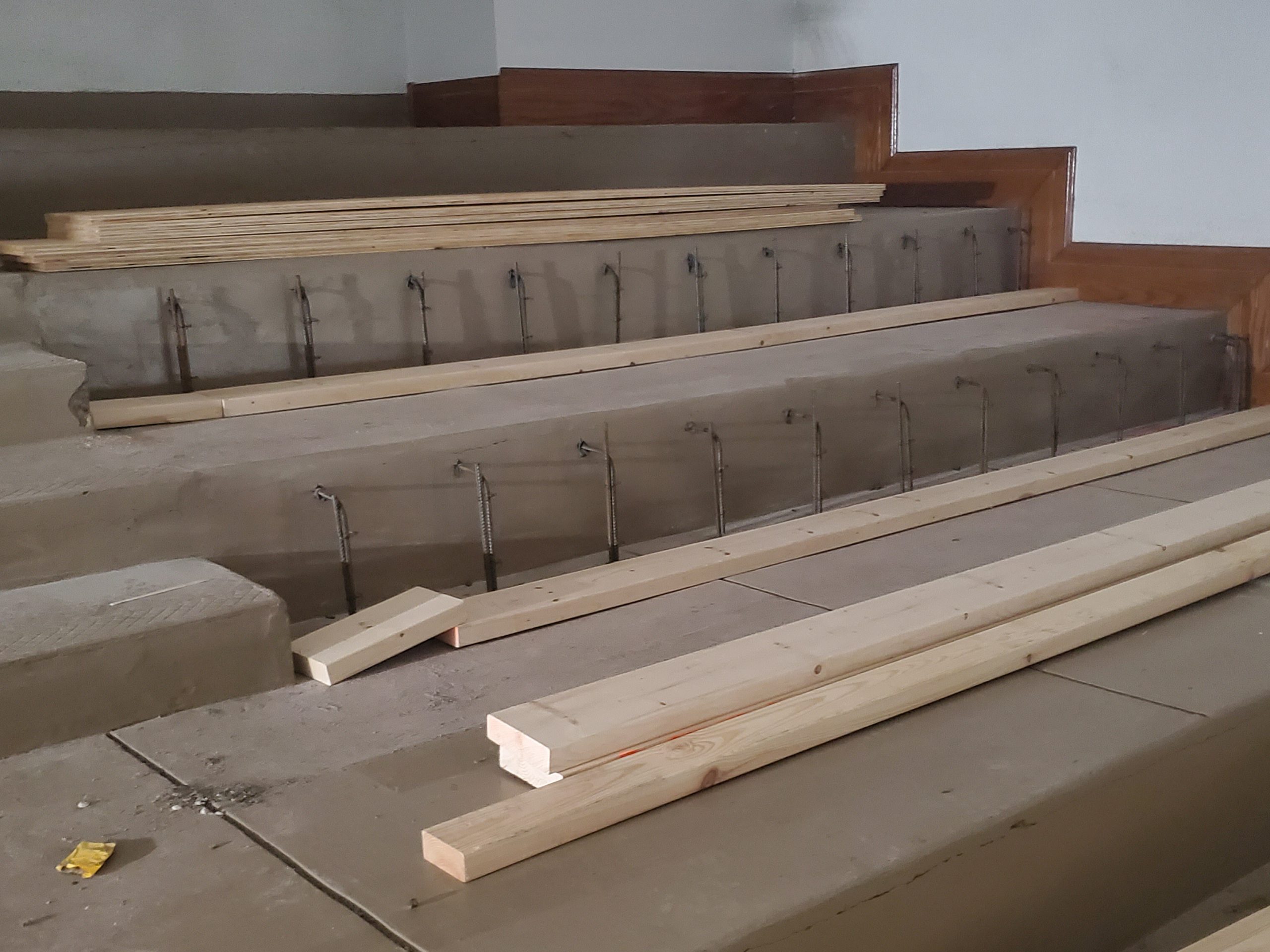

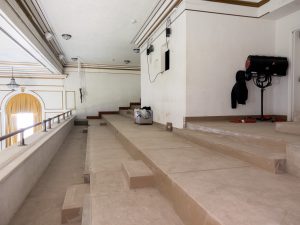

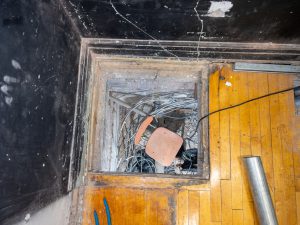

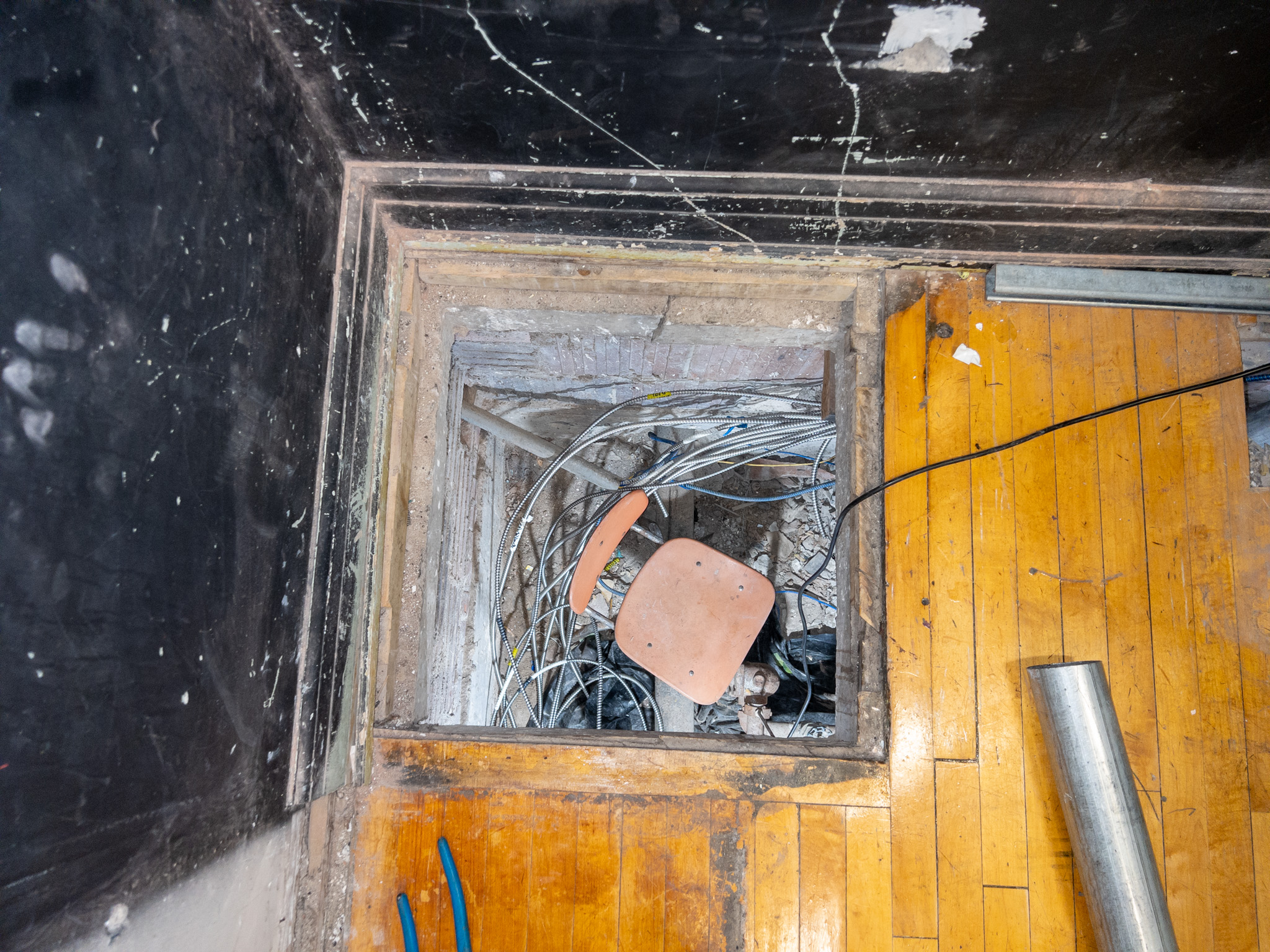

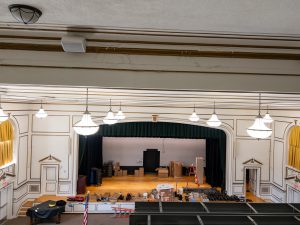

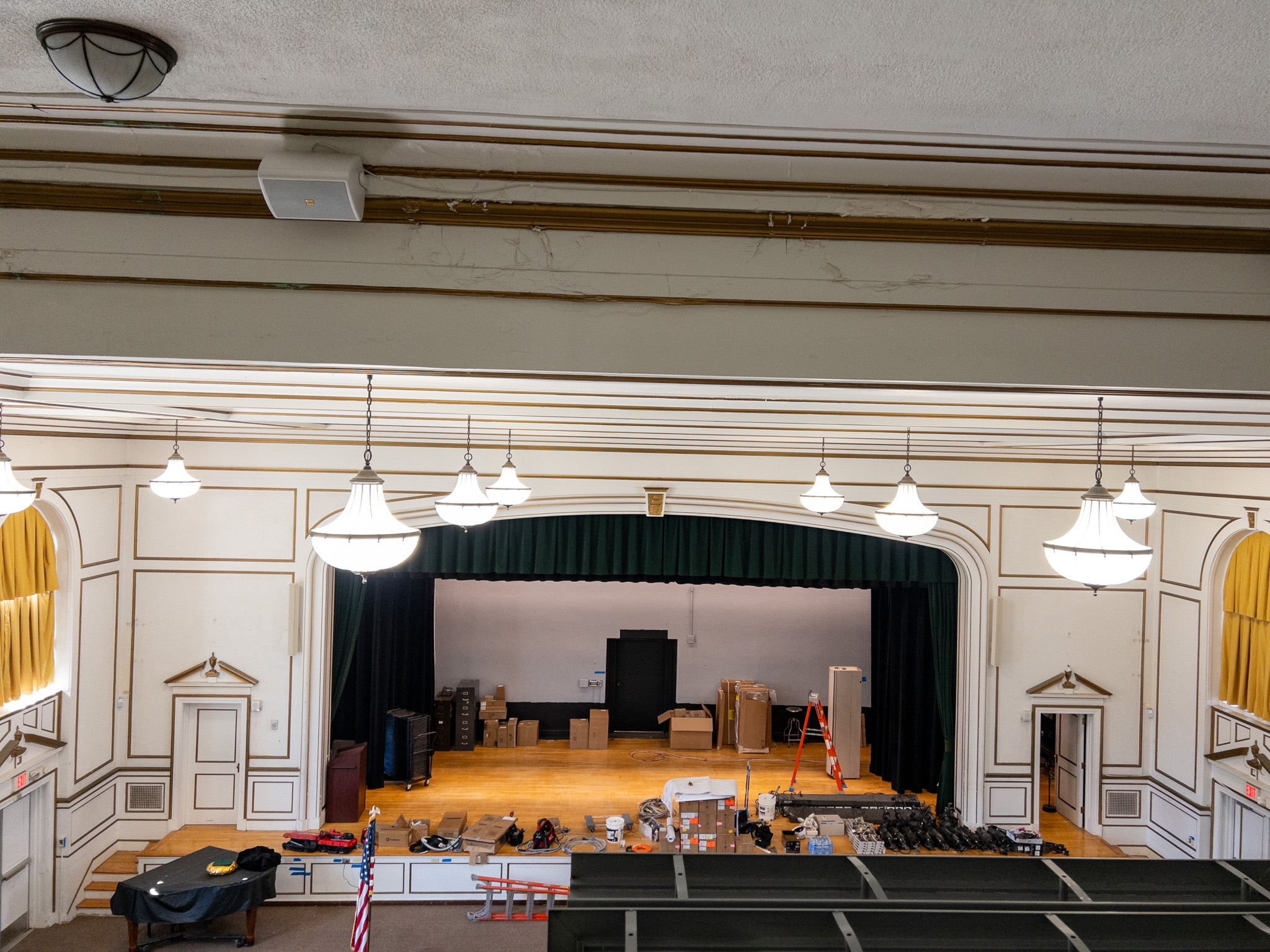

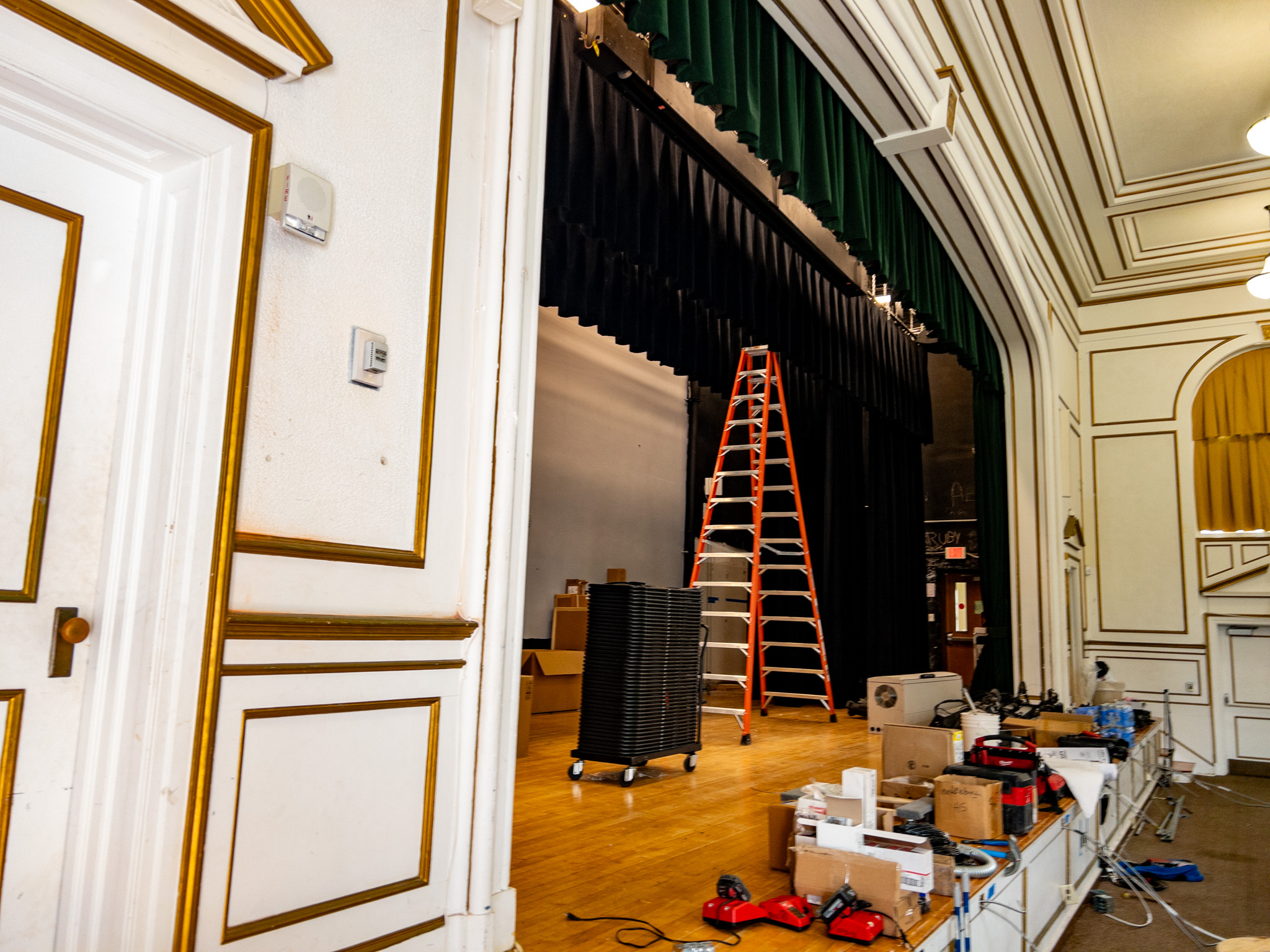

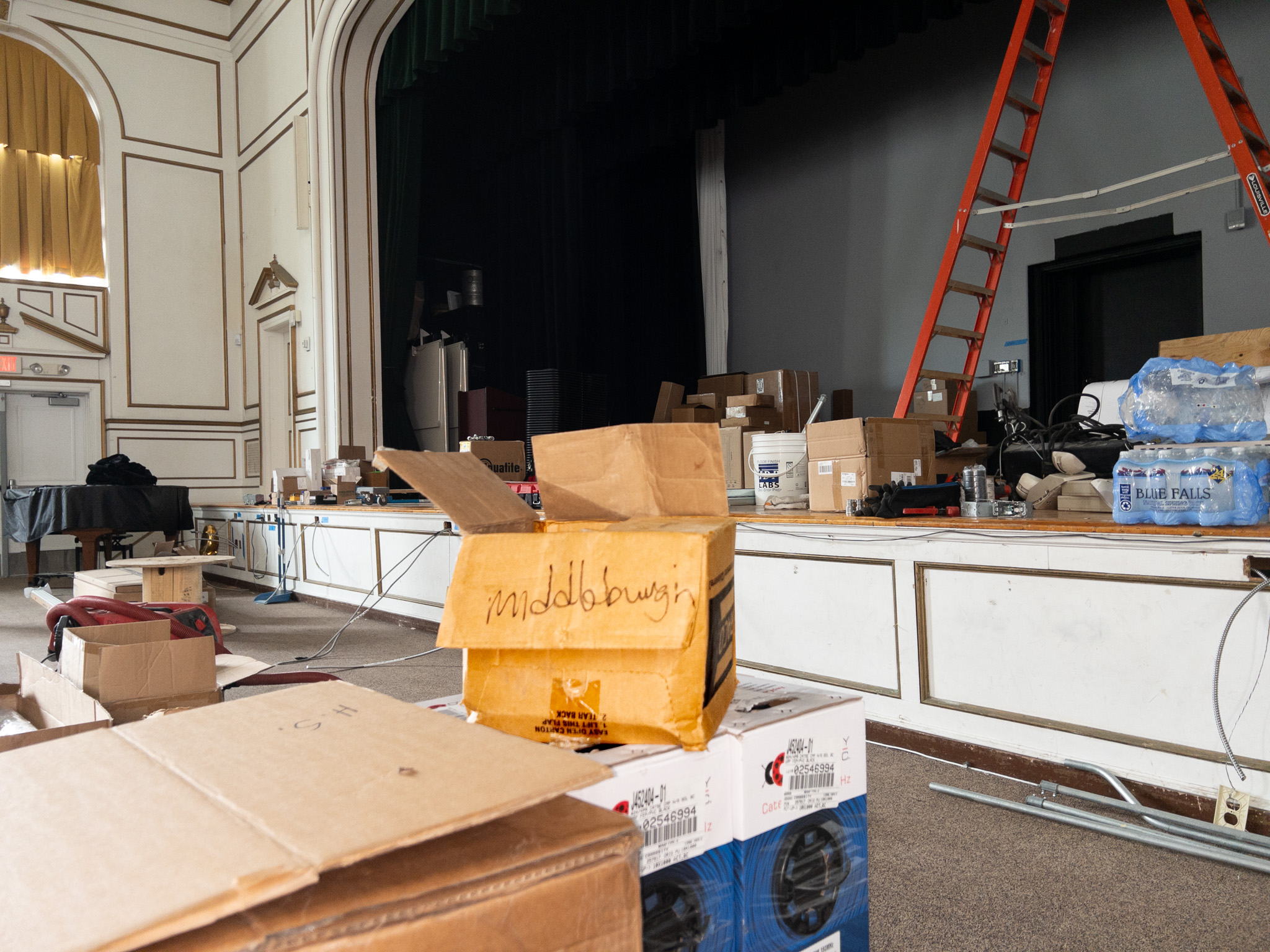

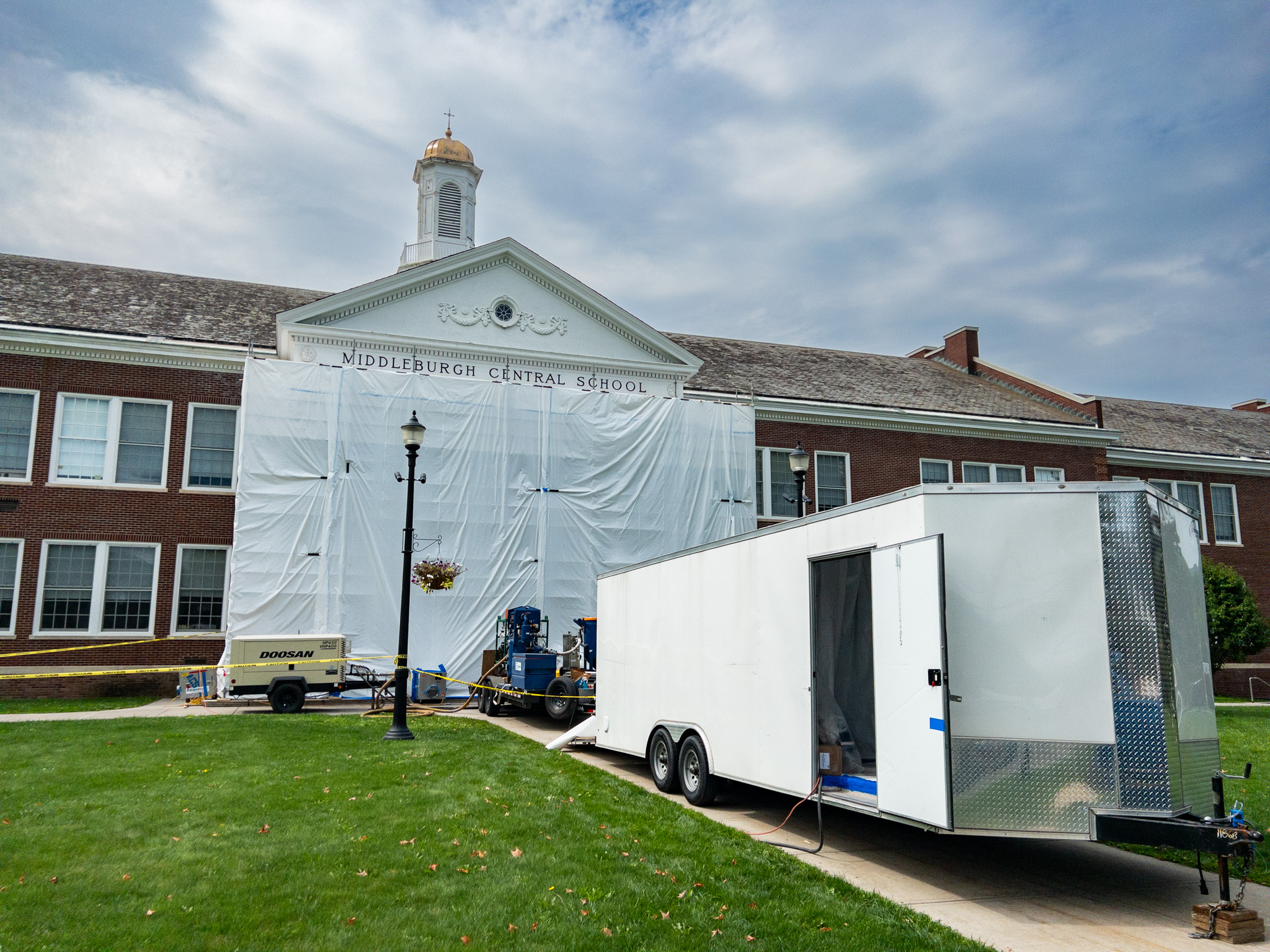

Updated lighting will modernize the space for both school and community events, while the restoration of a missing balcony seating section will expand access. Work will begin right after graduation and be completed by Oct. 2026.

Preservation

Over the summer of 2026, the building’s main roof will have gutter repairs to address drainage issues and deterioration of the Yankee gutter system.

Cafeteria Bathrooms

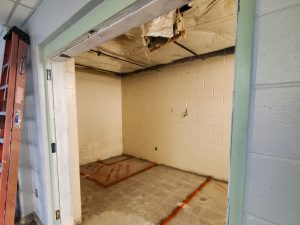

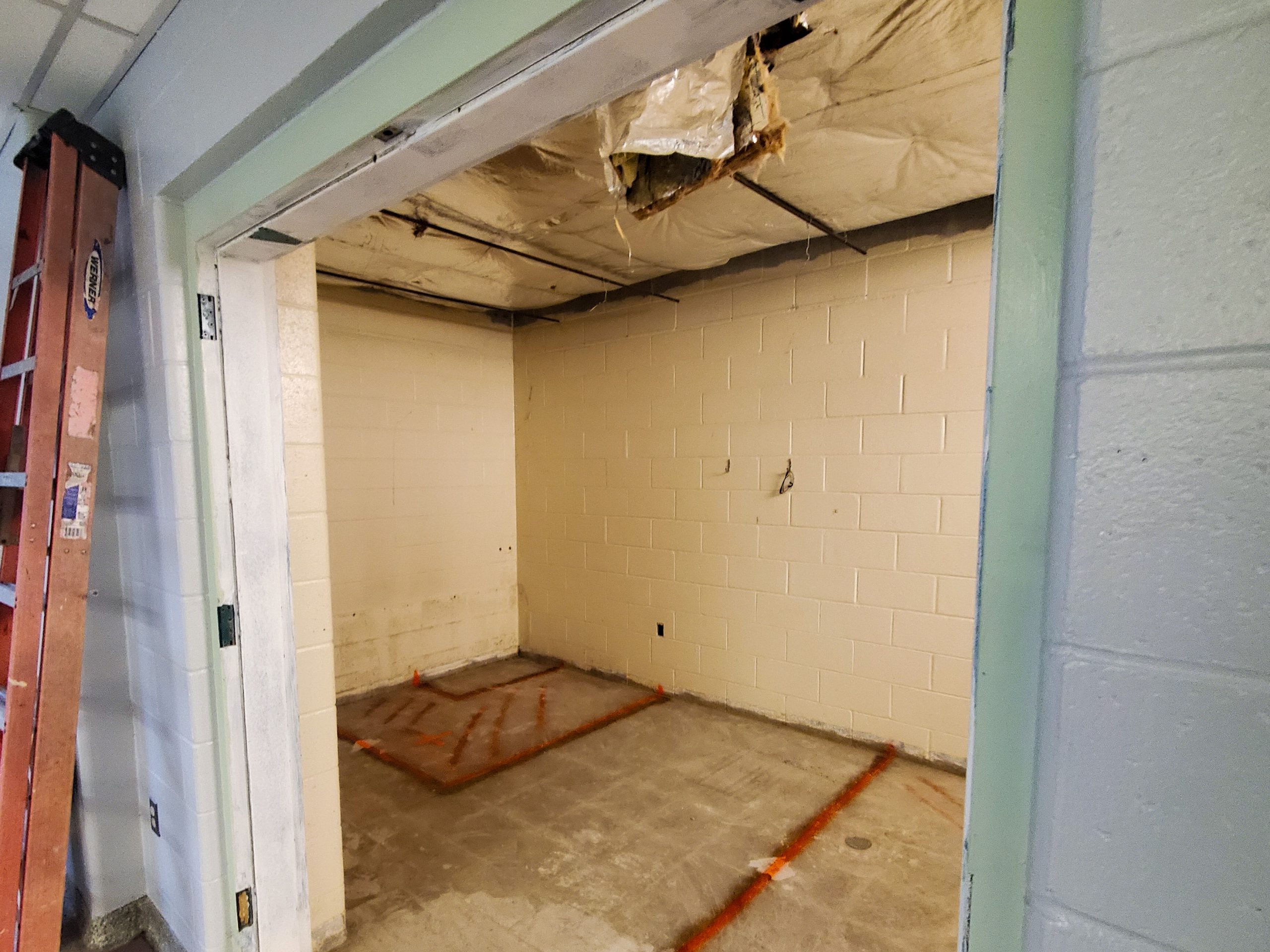

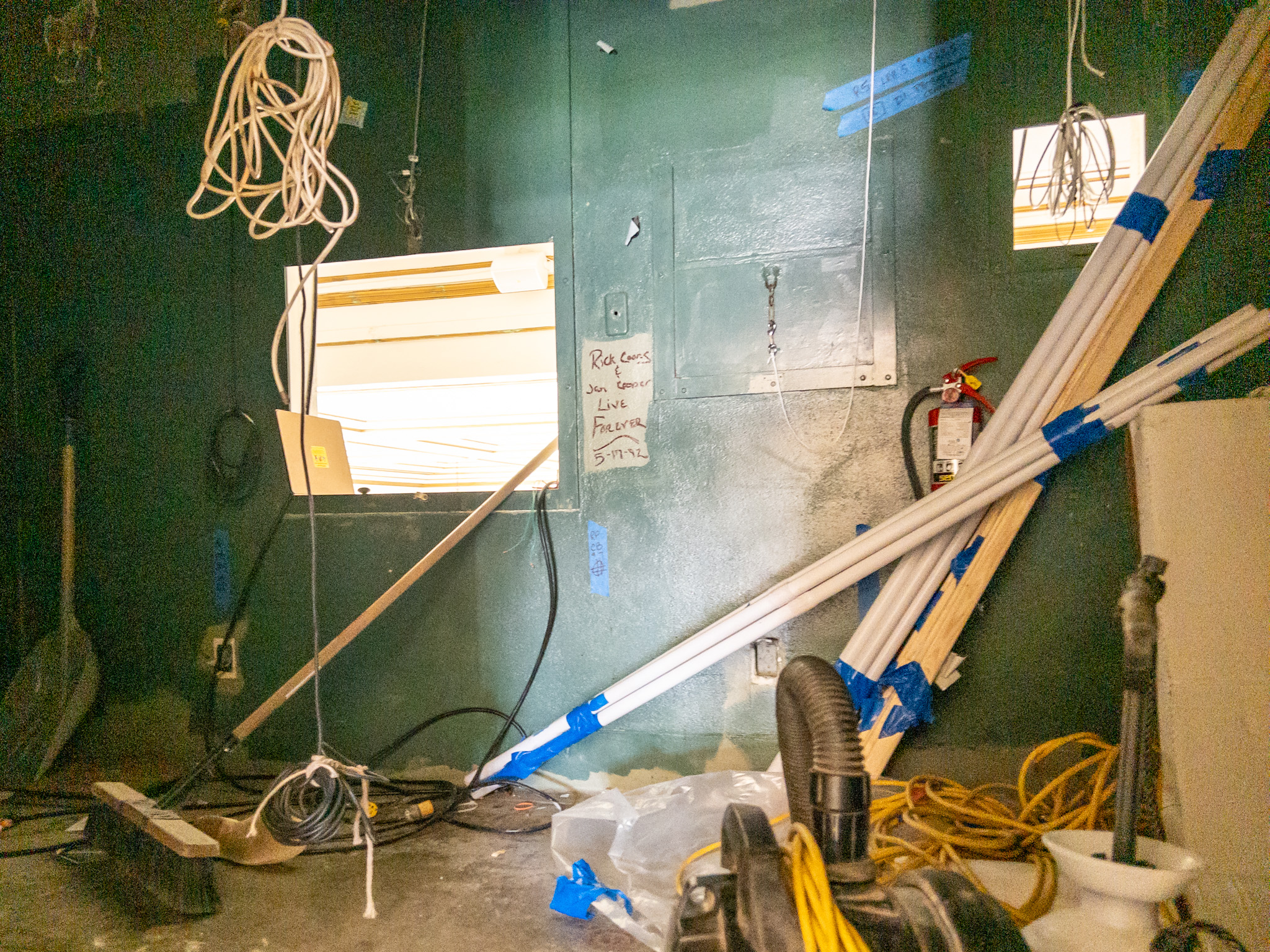

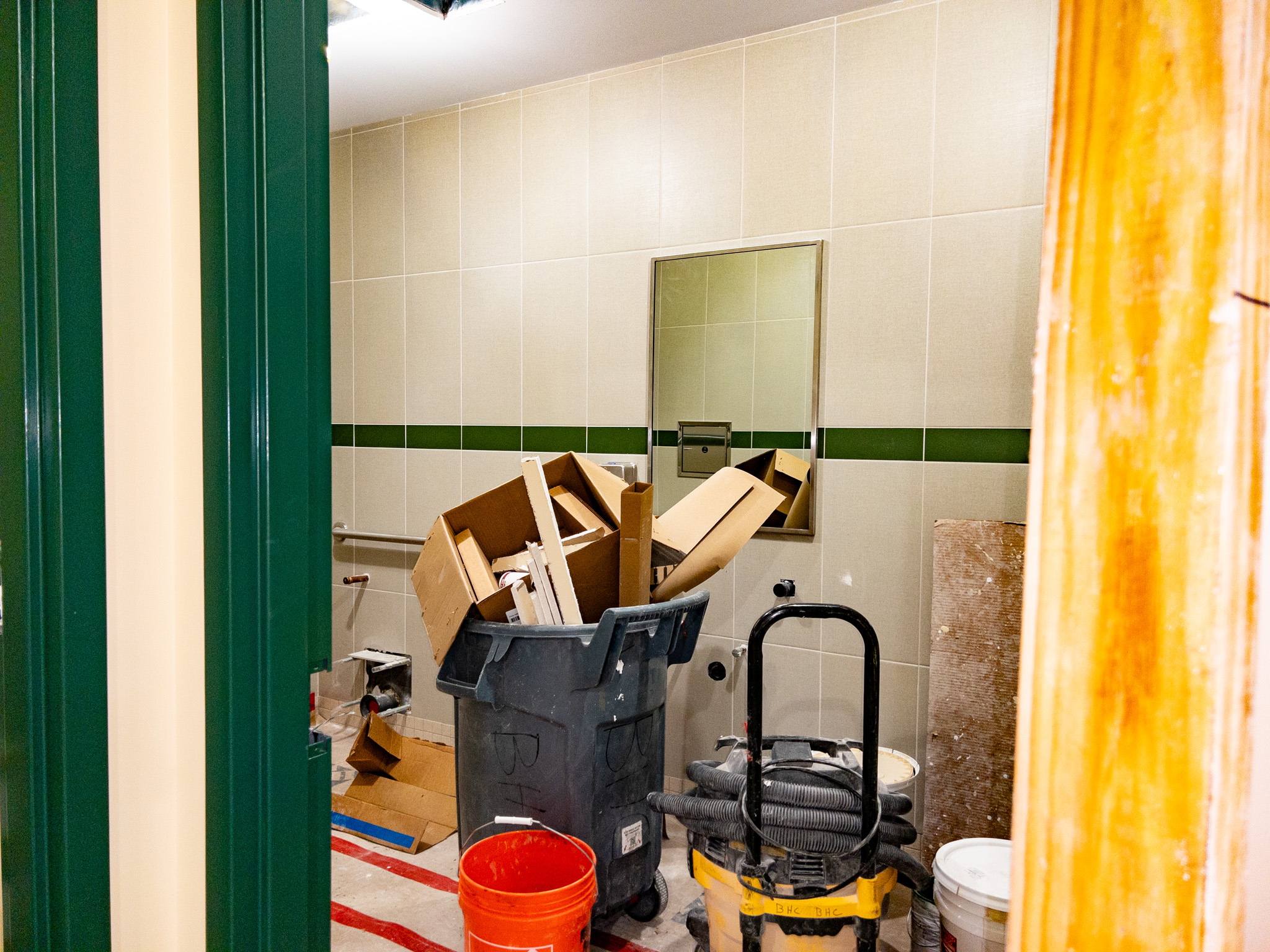

Out-of-service bathrooms in the cafeteria will be replaced with ADA-compliant facilities. This work will begin in the summer of 2026 and is expected to be completed by October 2026.

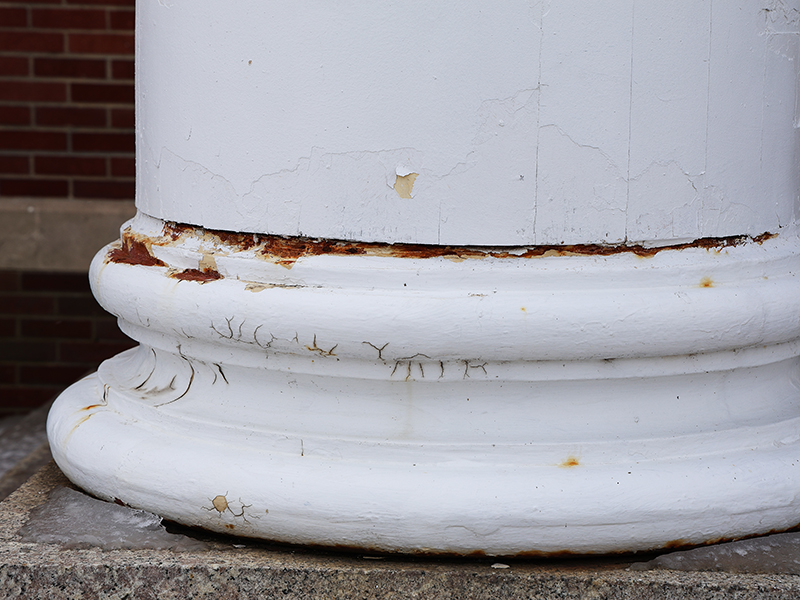

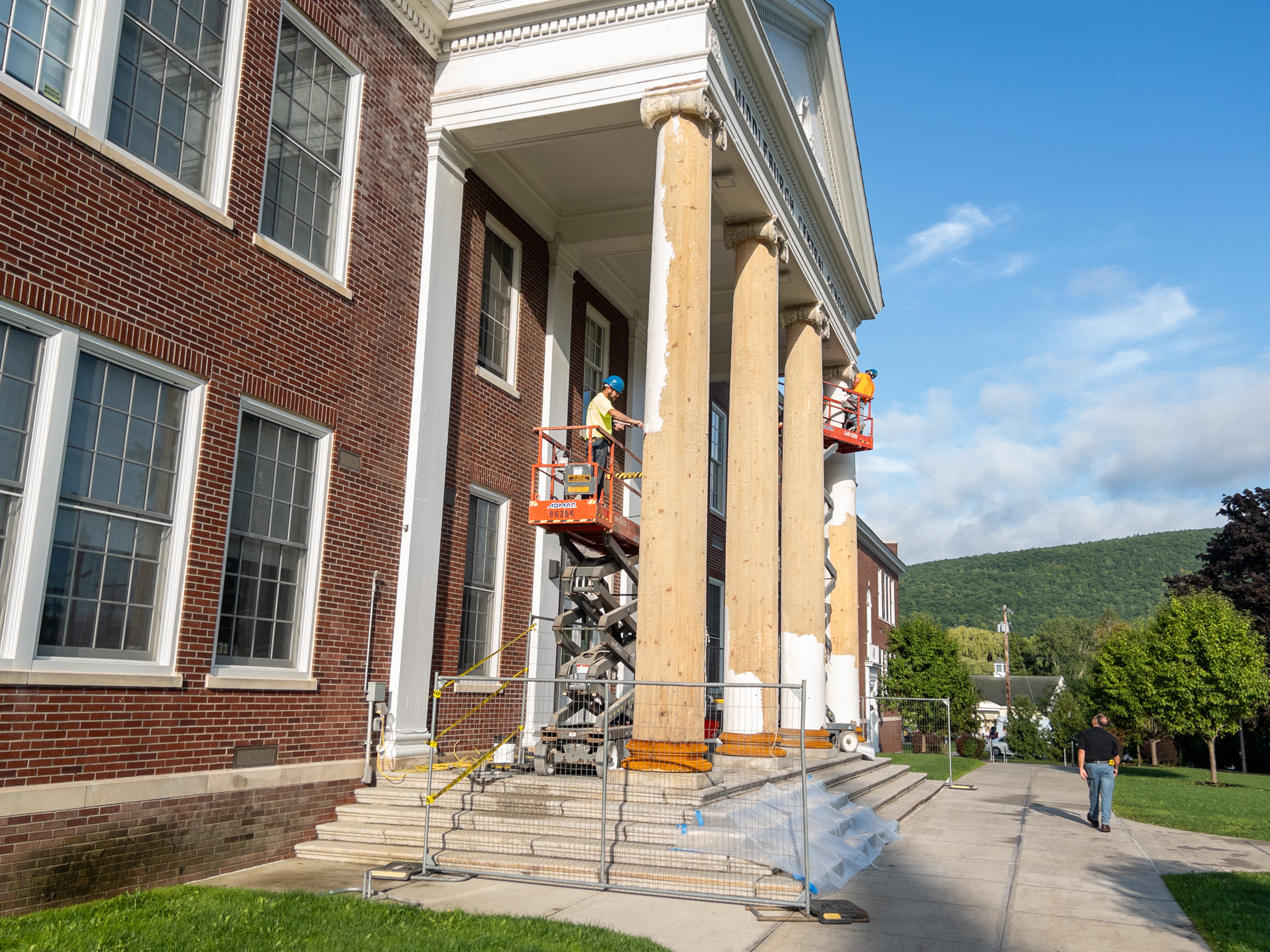

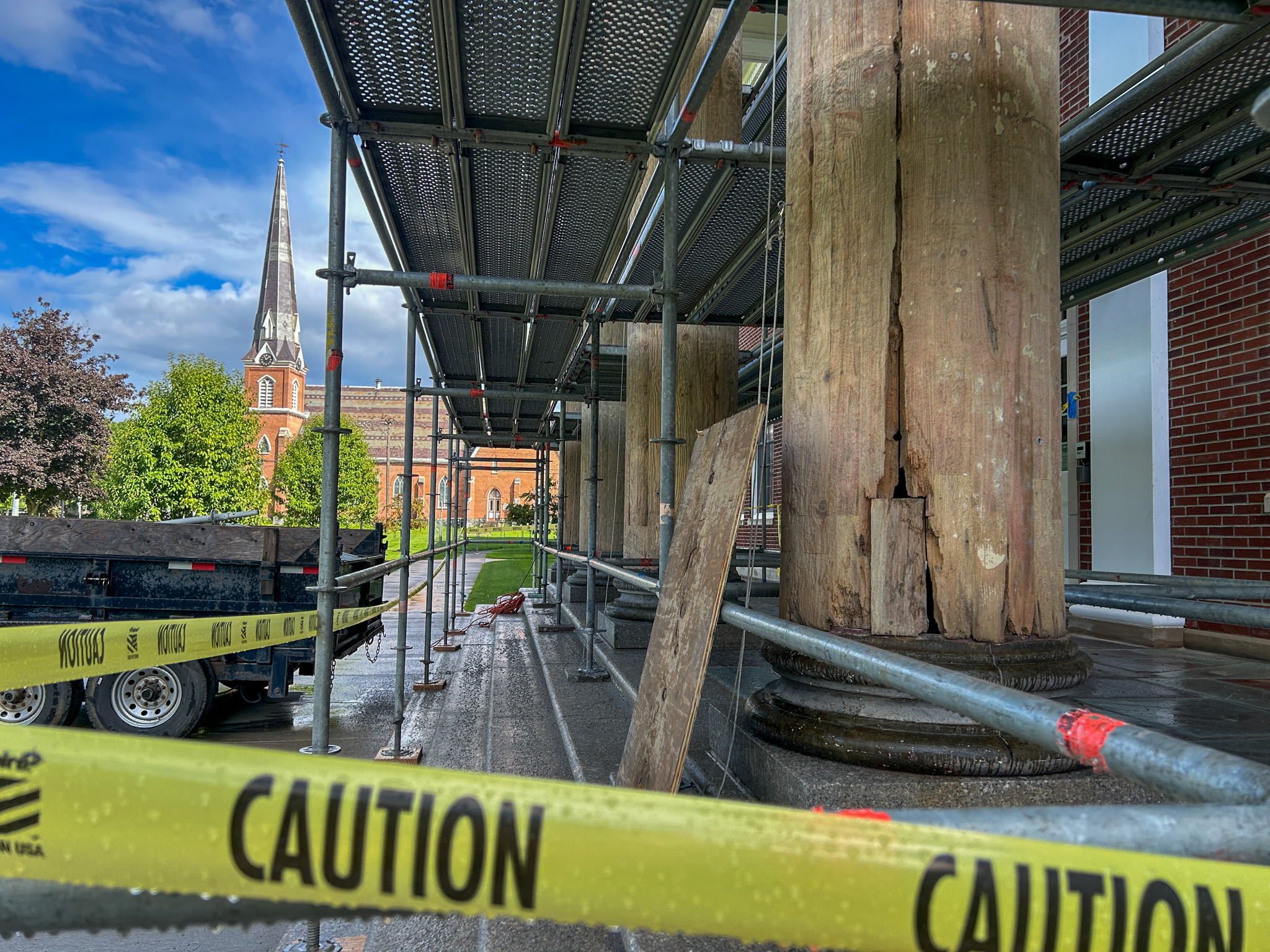

Building Columns

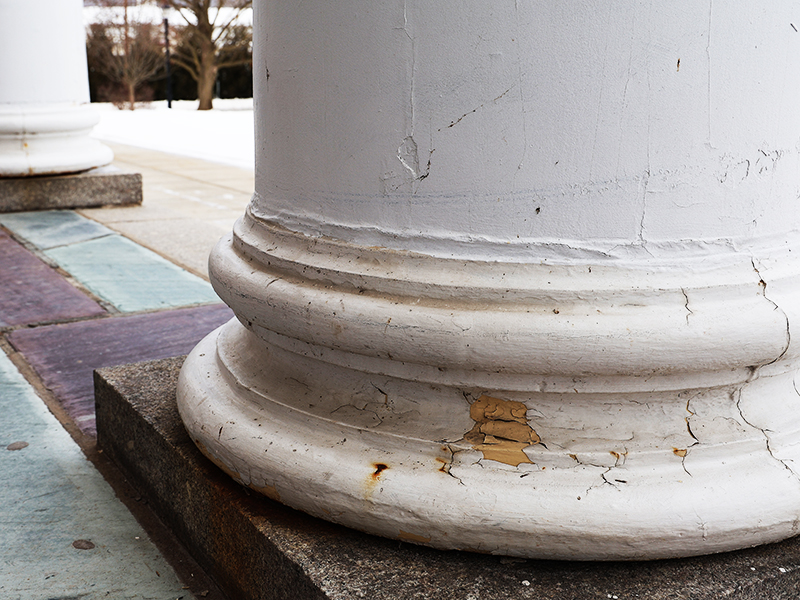

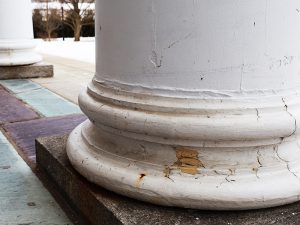

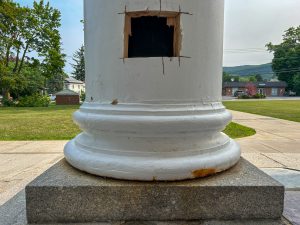

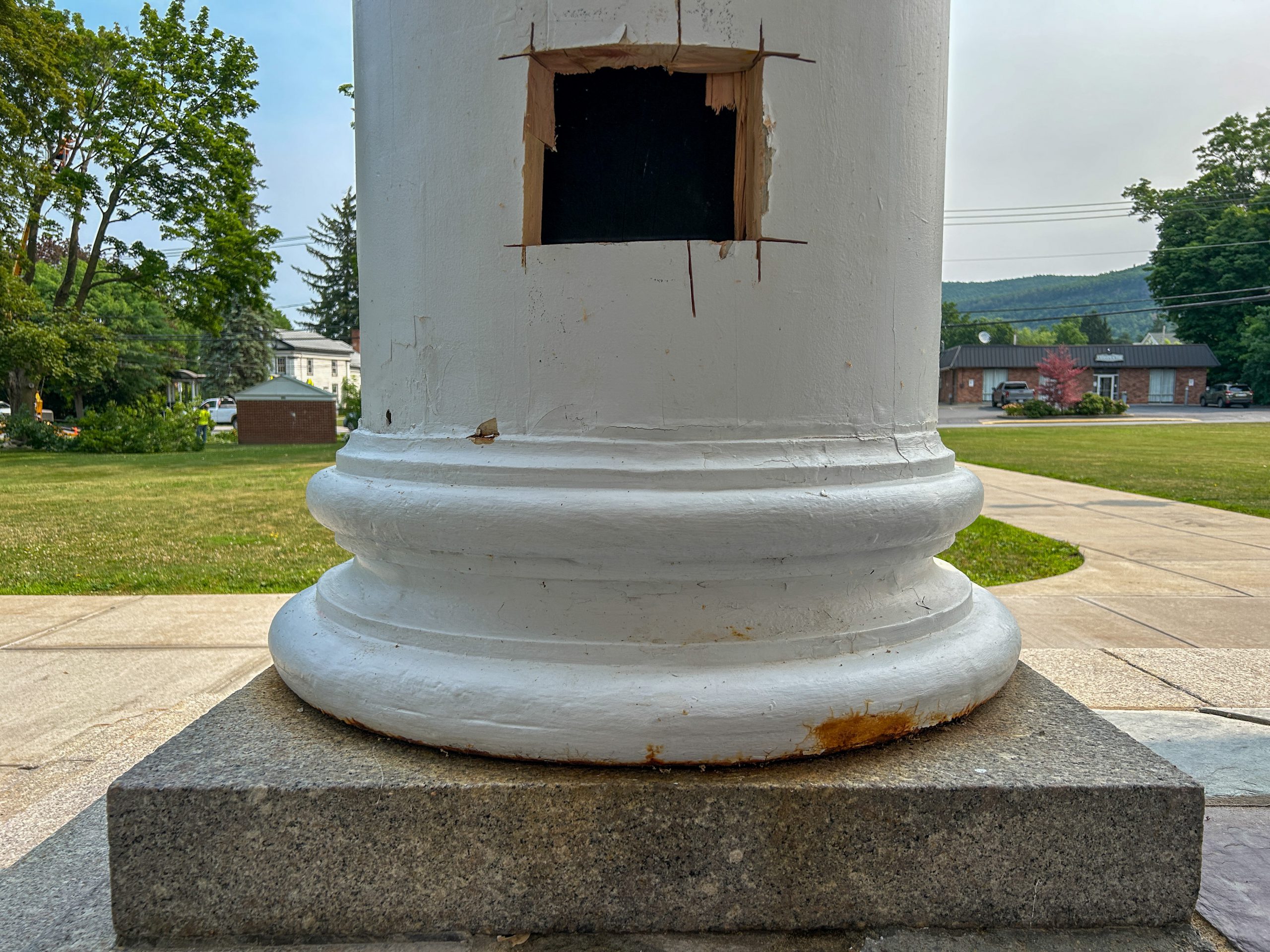

The main entry columns will receive structural repairs to ensure their longevity. The district is awaiting bids on this portion of the project.

Back to Top

Transportation Building

Several upgrades will ensure the bus garage remains safe and efficient.

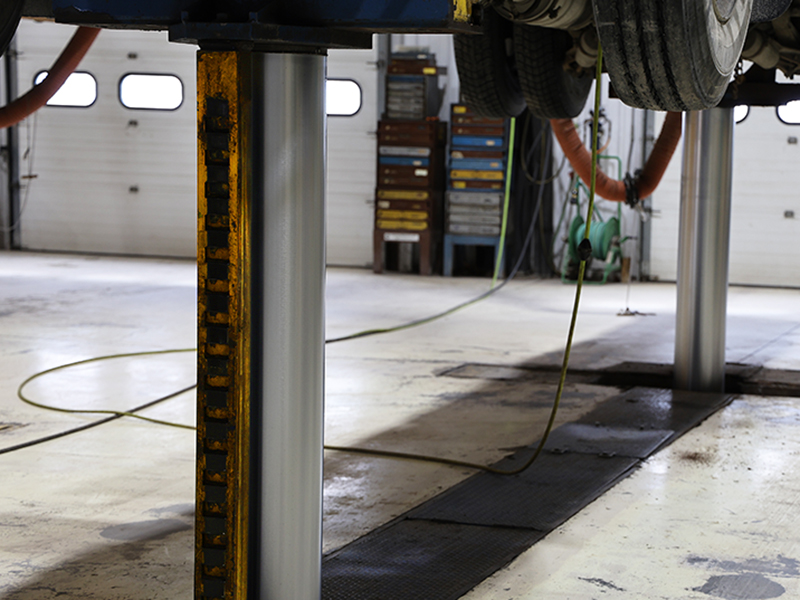

Bus Lifts

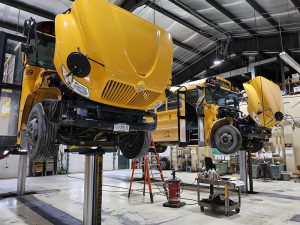

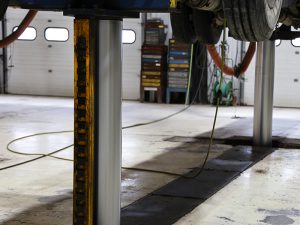

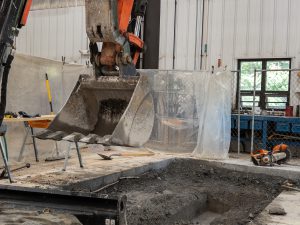

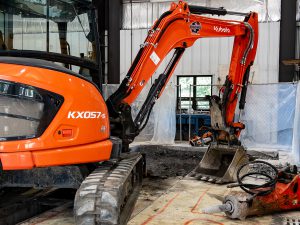

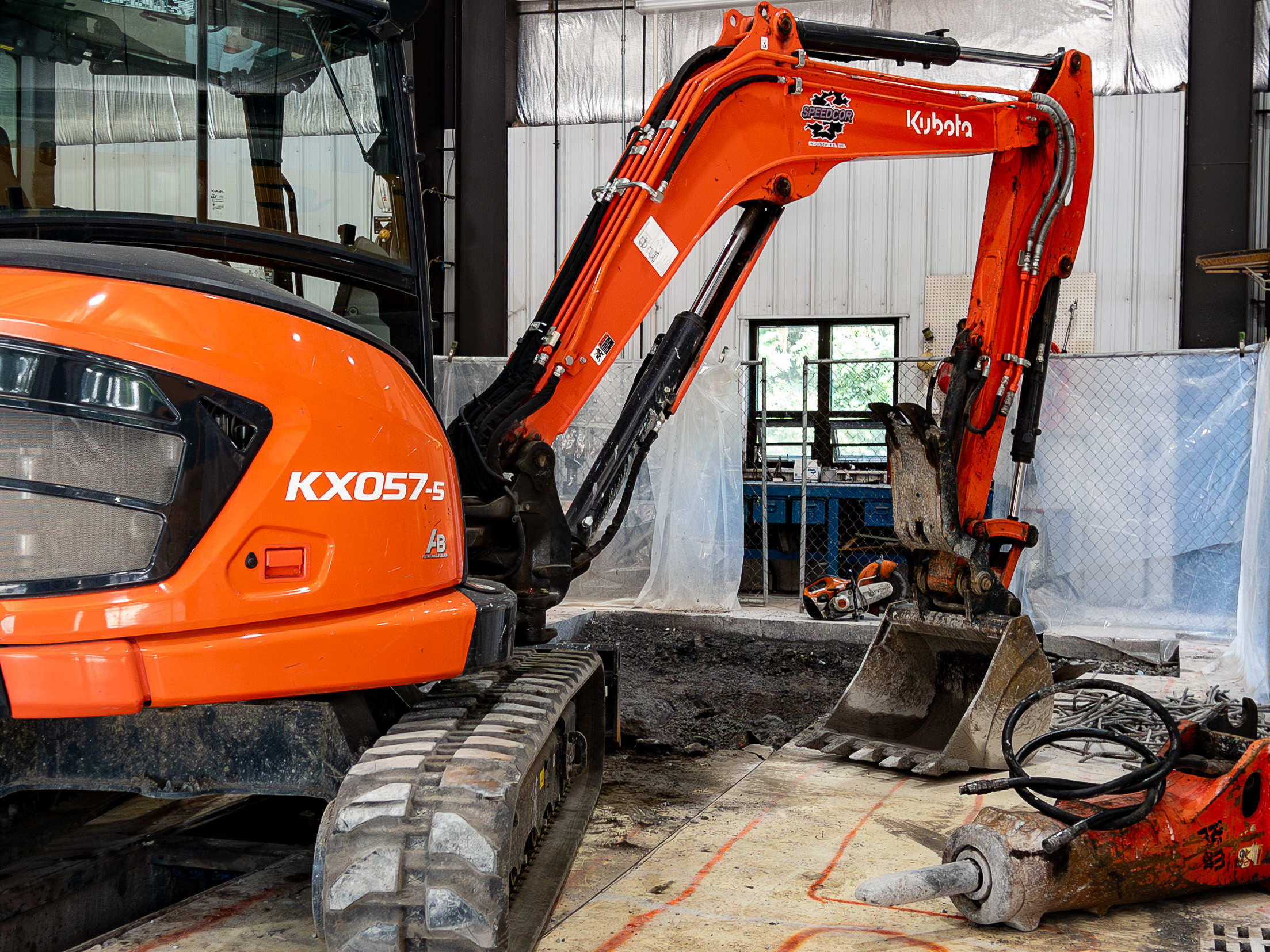

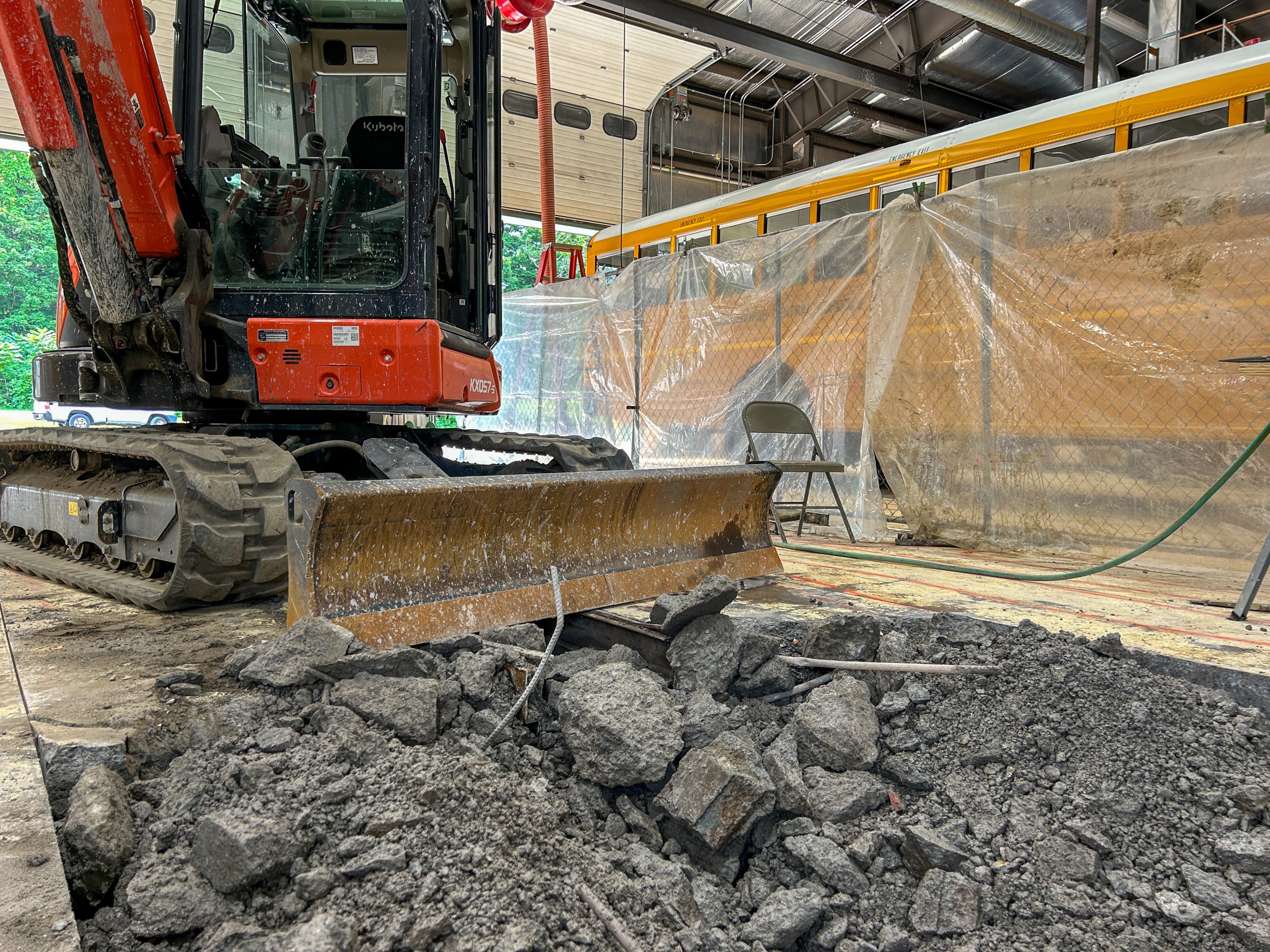

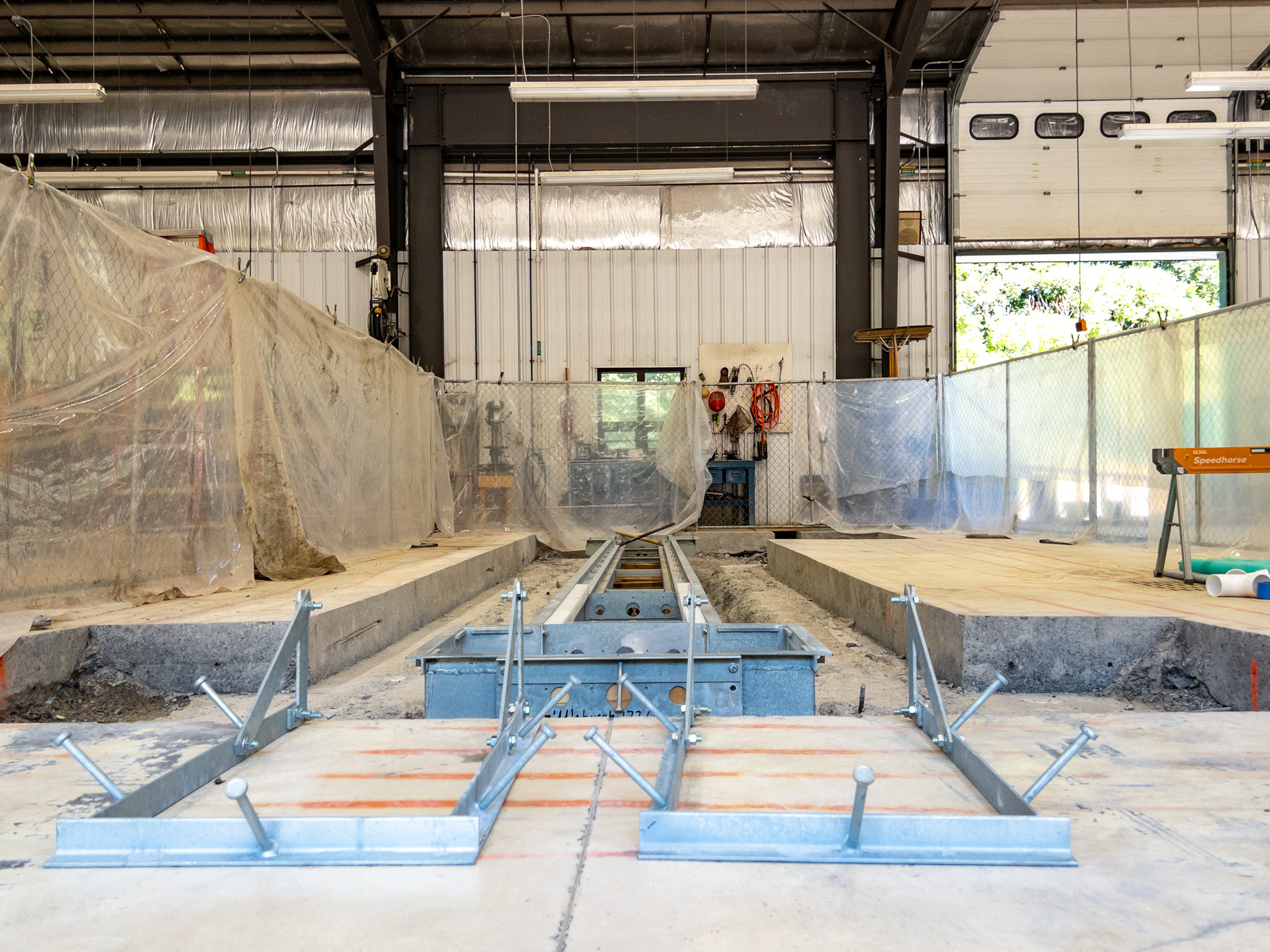

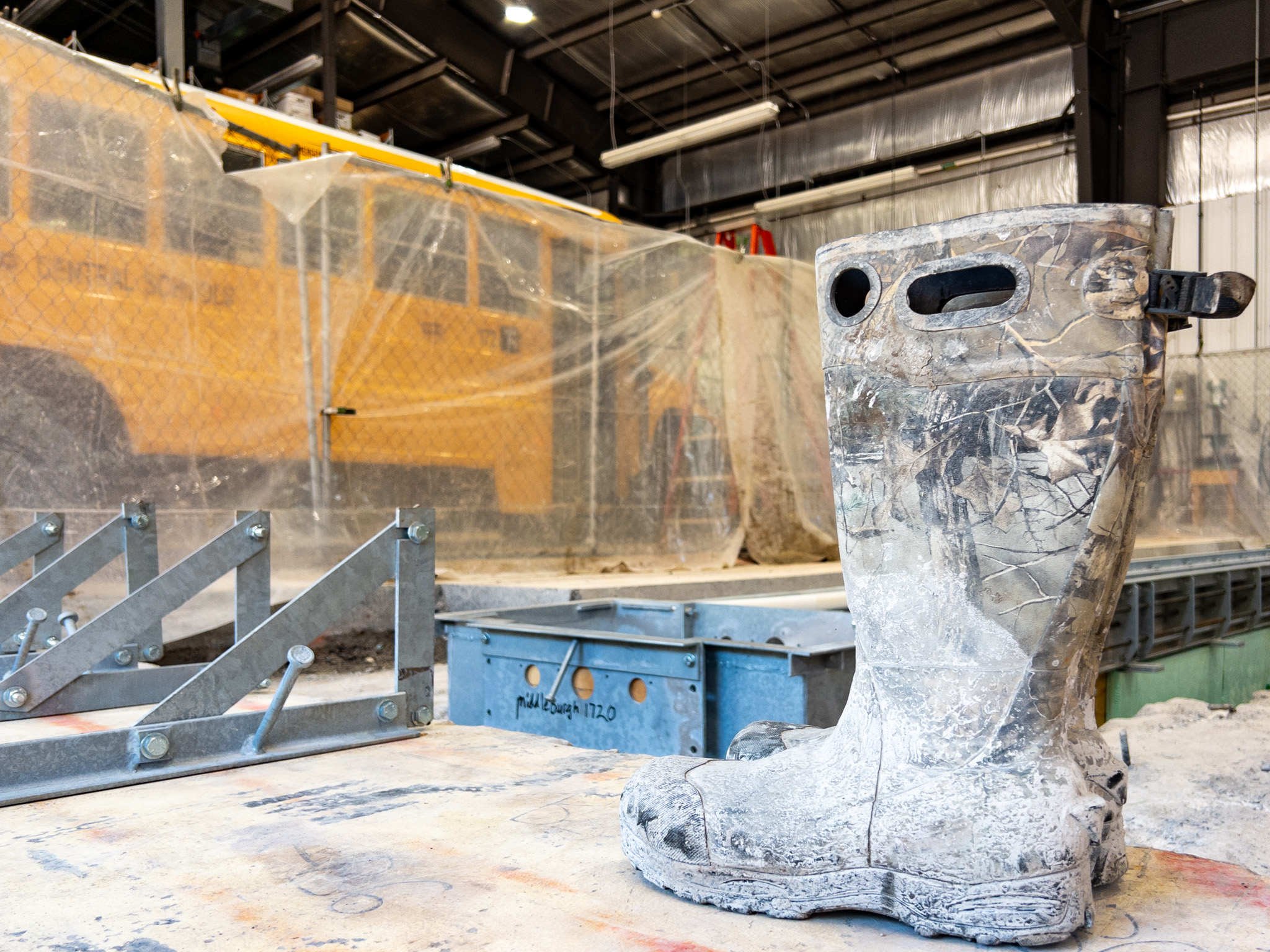

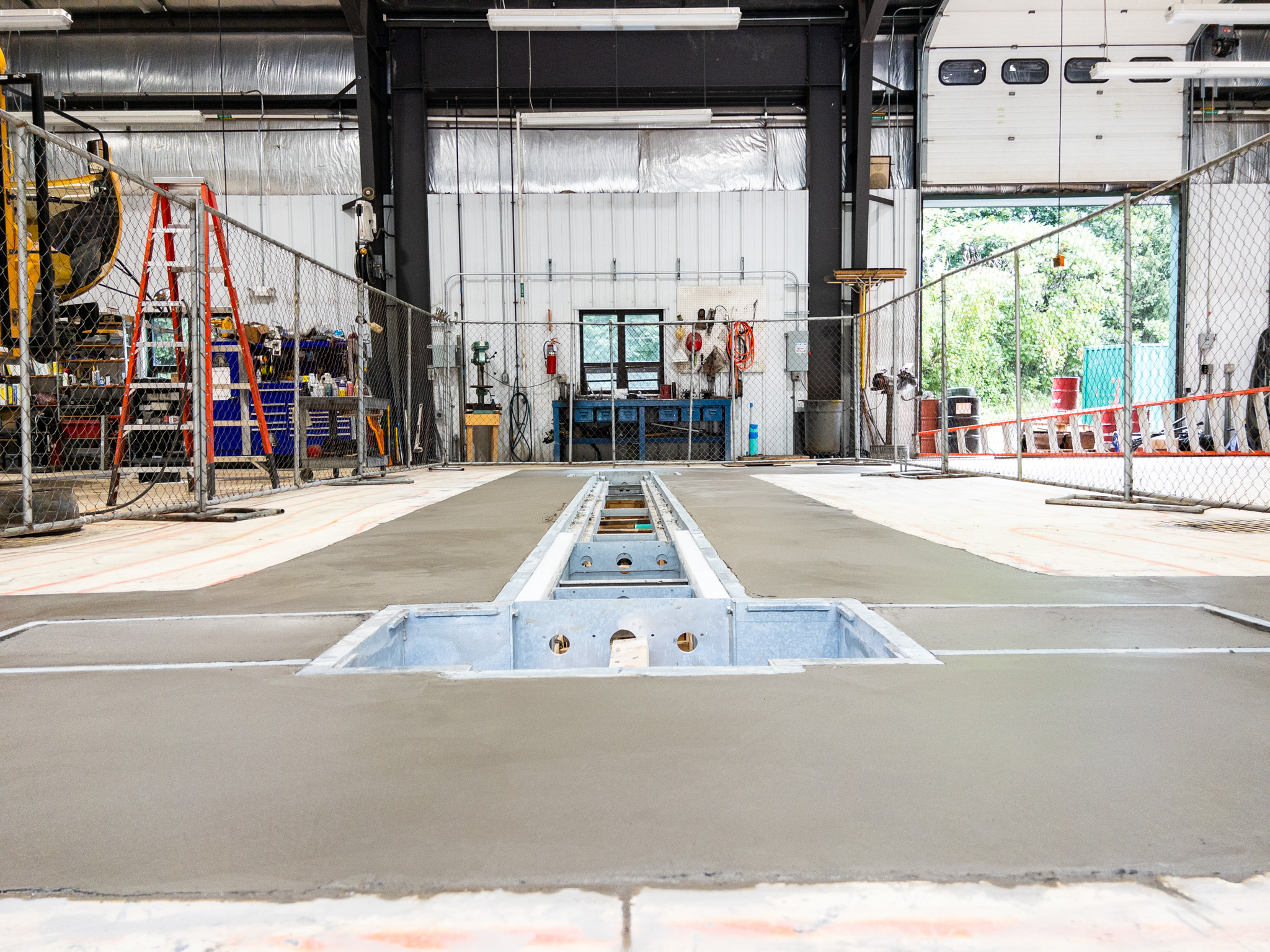

Two lifts, which have already exceeded their life expectancy, will be replaced during the summer of 2026.

Floor

During the summer of 2026, a sealer will be applied to preserve the integrity of the floor.

Grounds

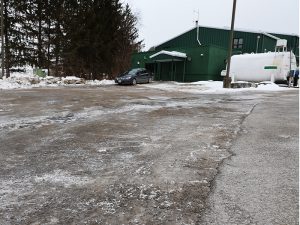

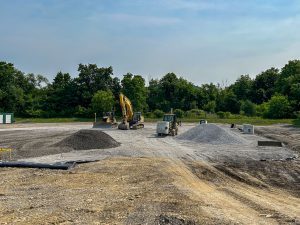

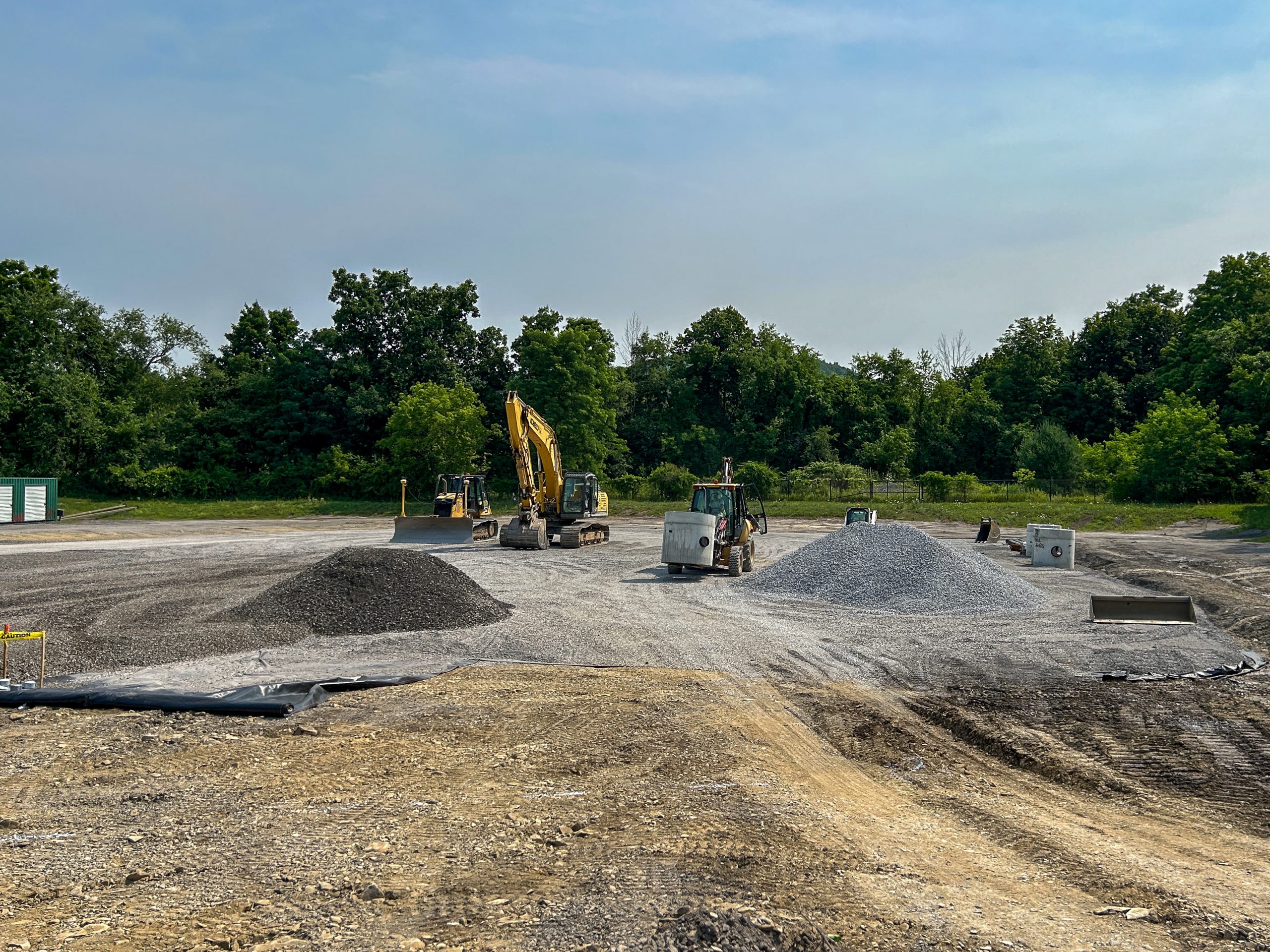

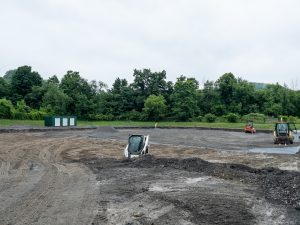

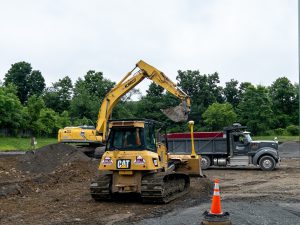

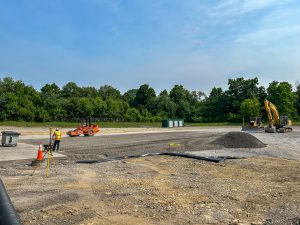

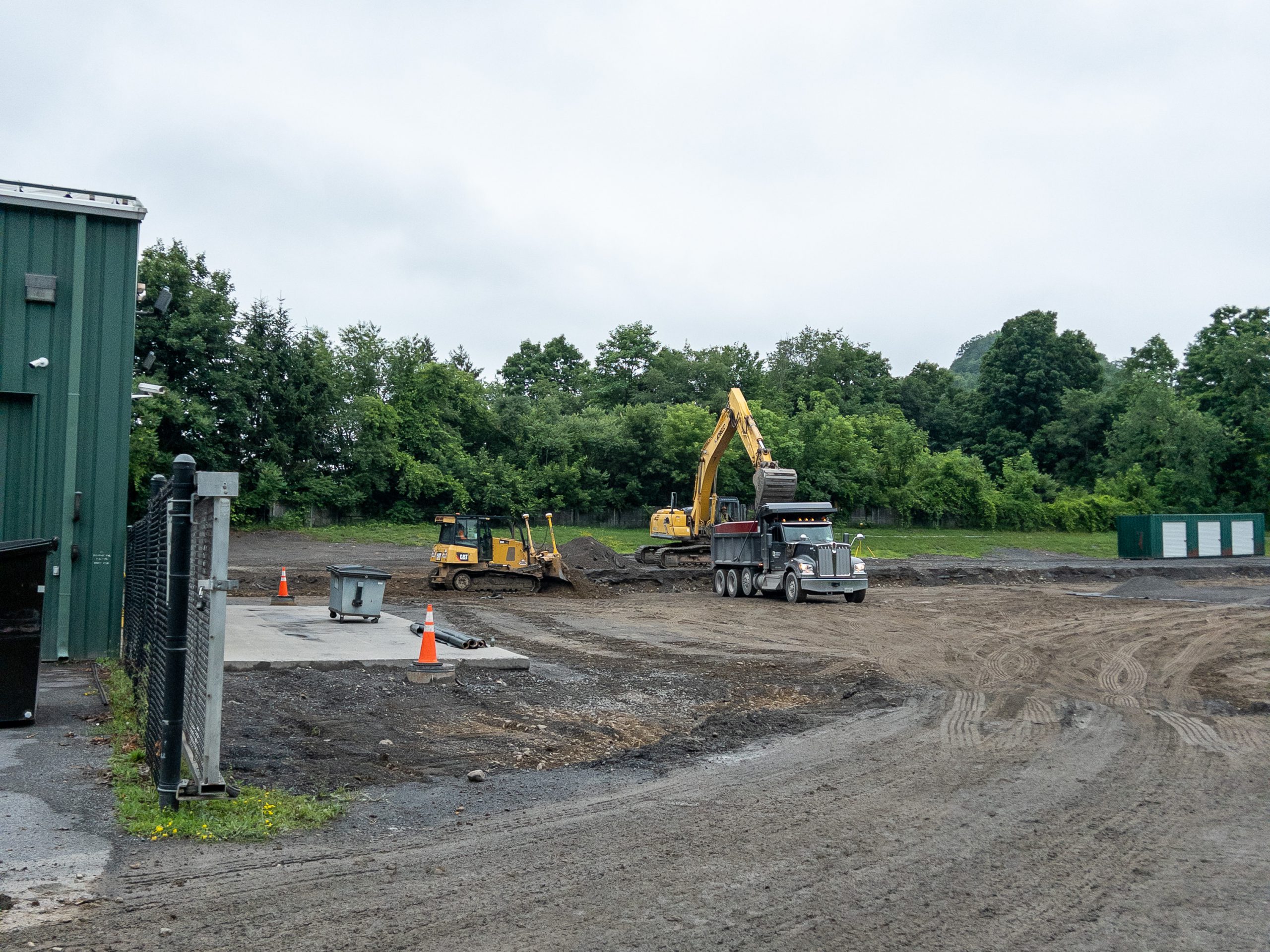

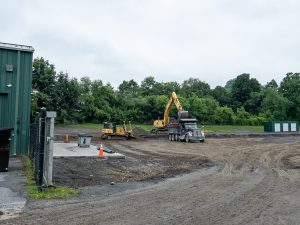

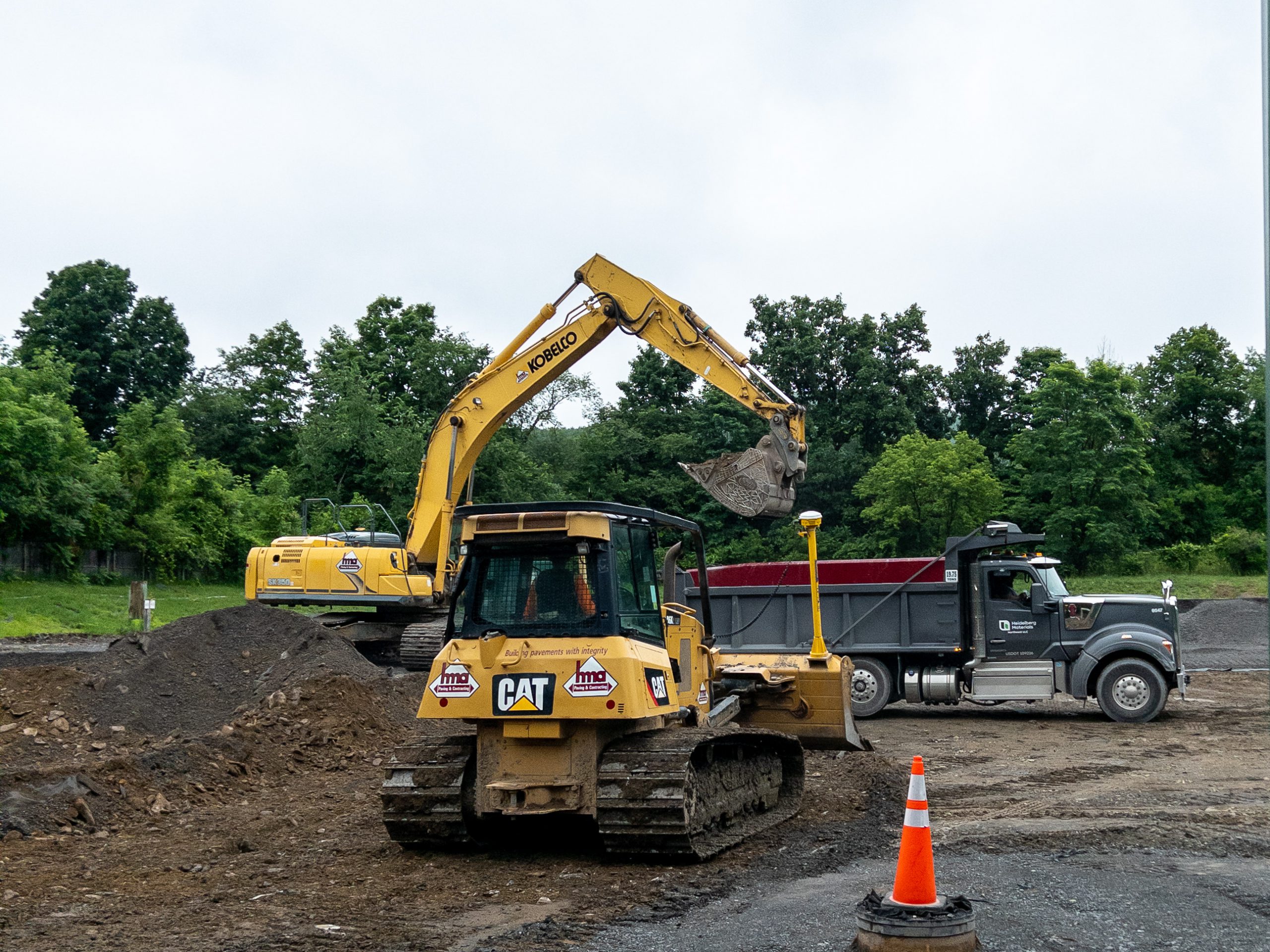

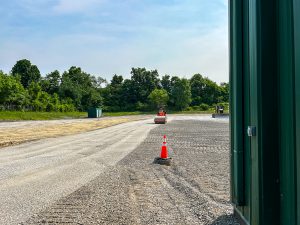

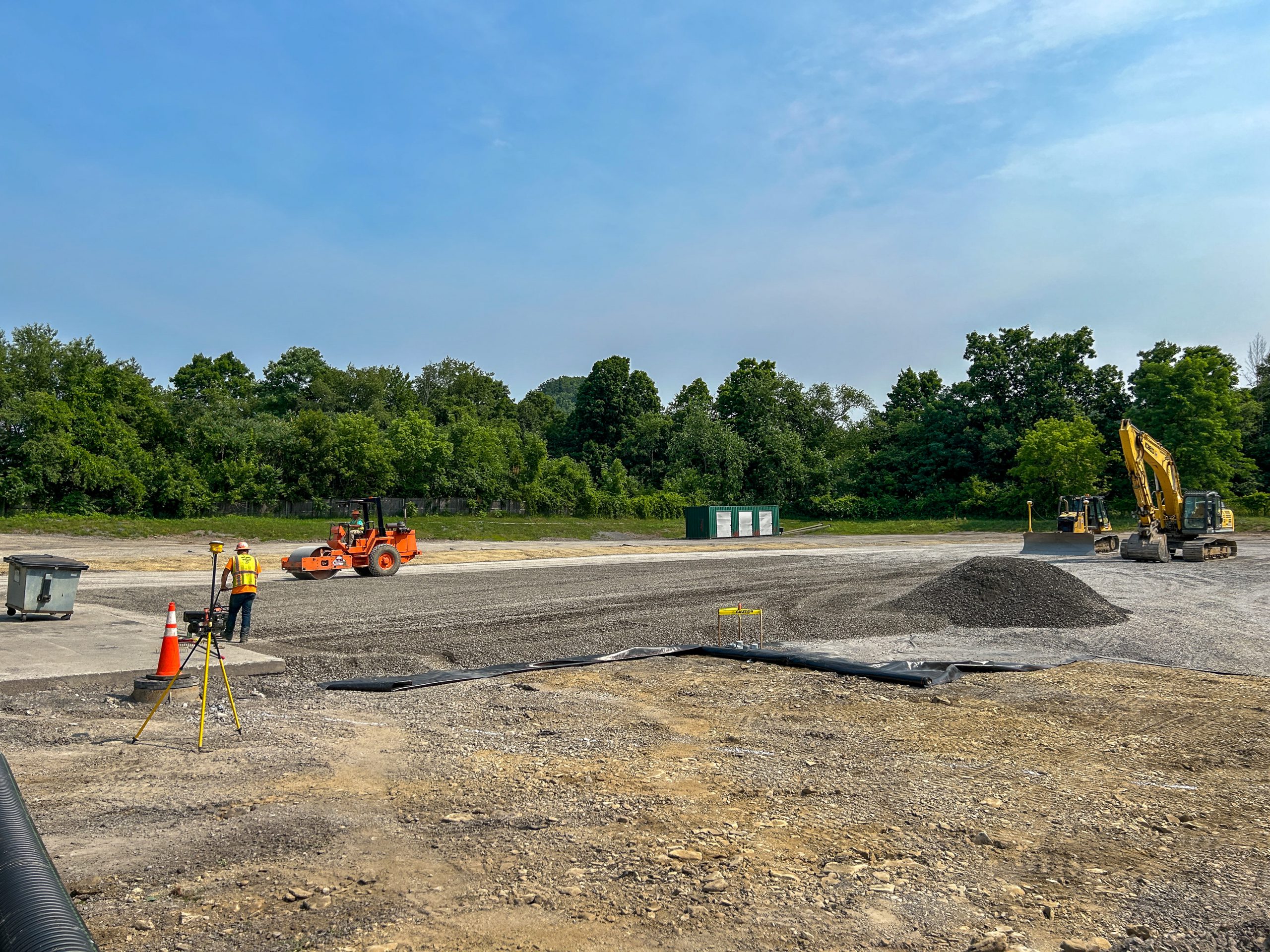

Additional drainage will be installed to prevent water intrusion, helping to protect both the structure and surrounding grounds. This work will be completed during July and August 2026.

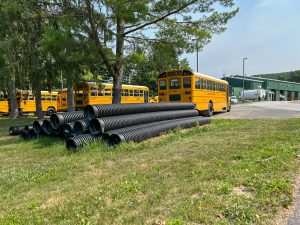

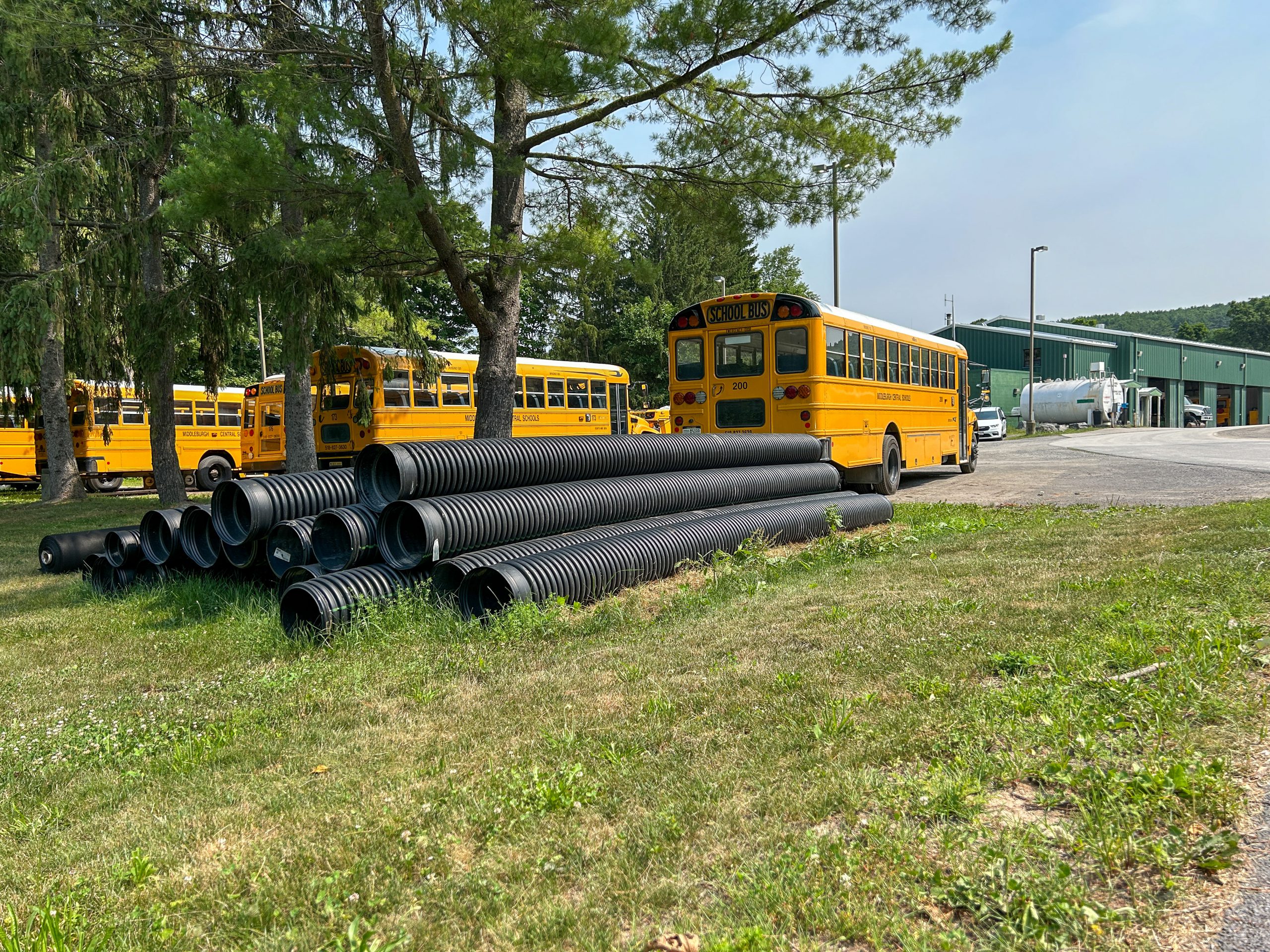

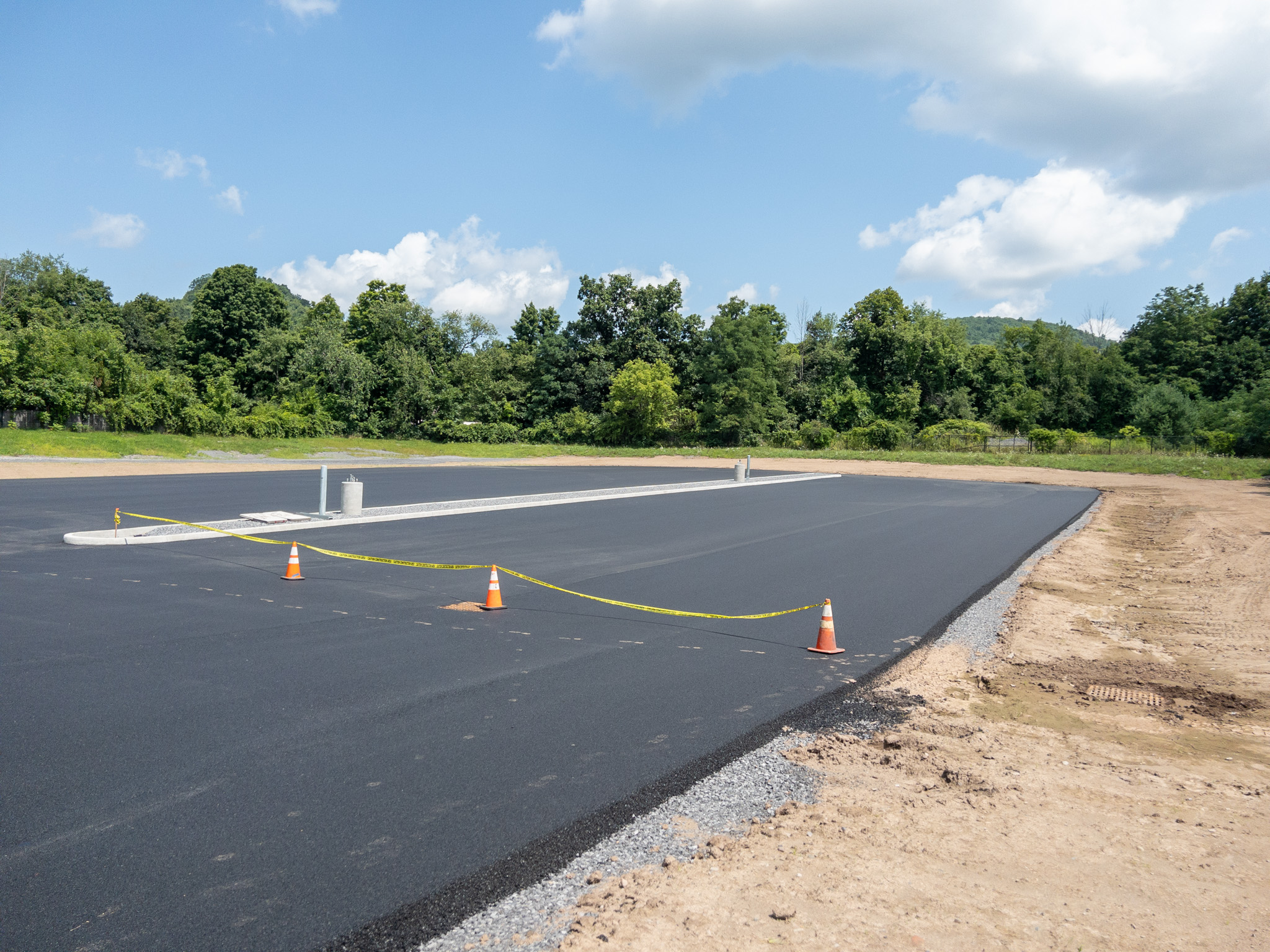

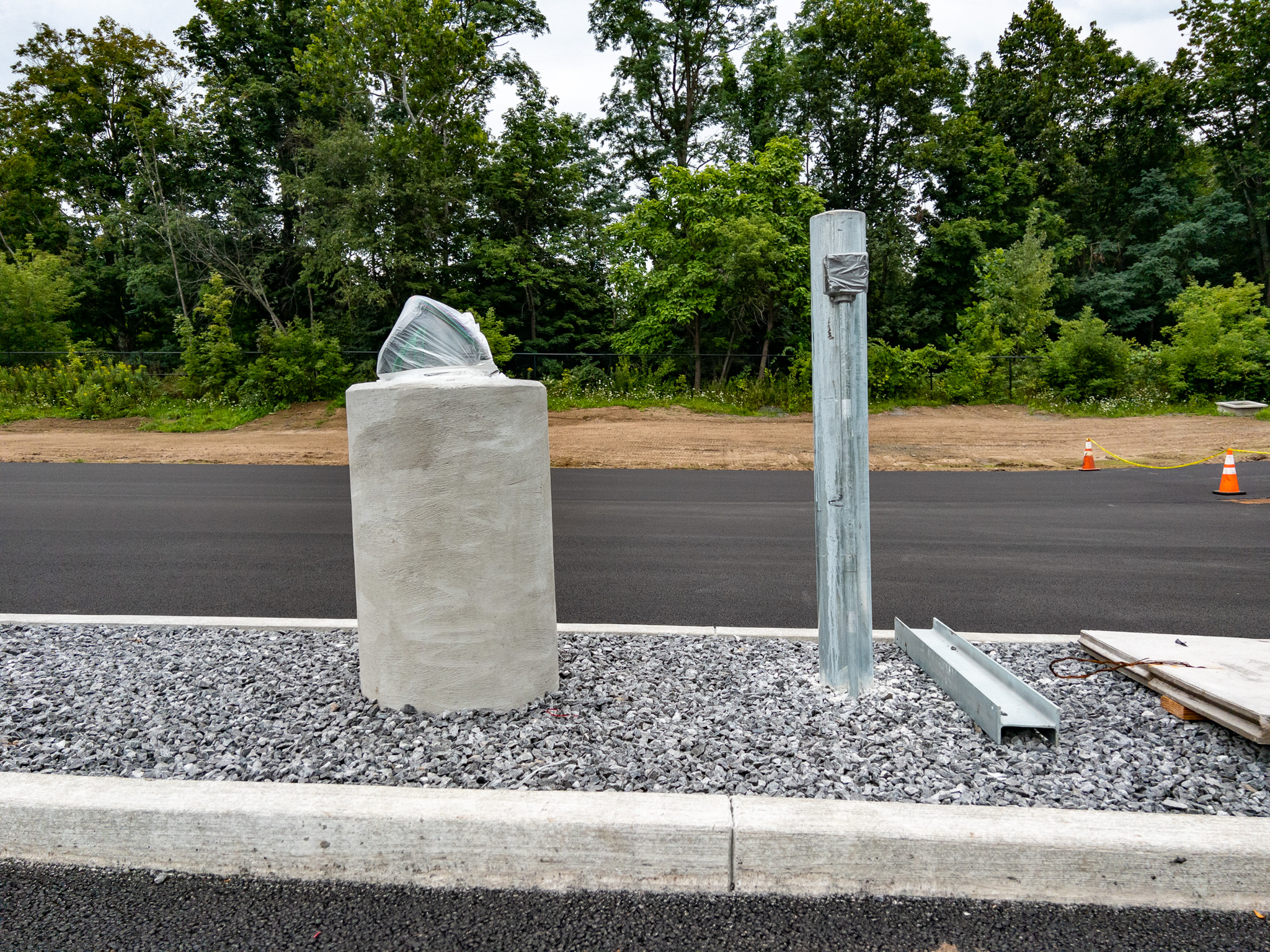

Conduit Installation

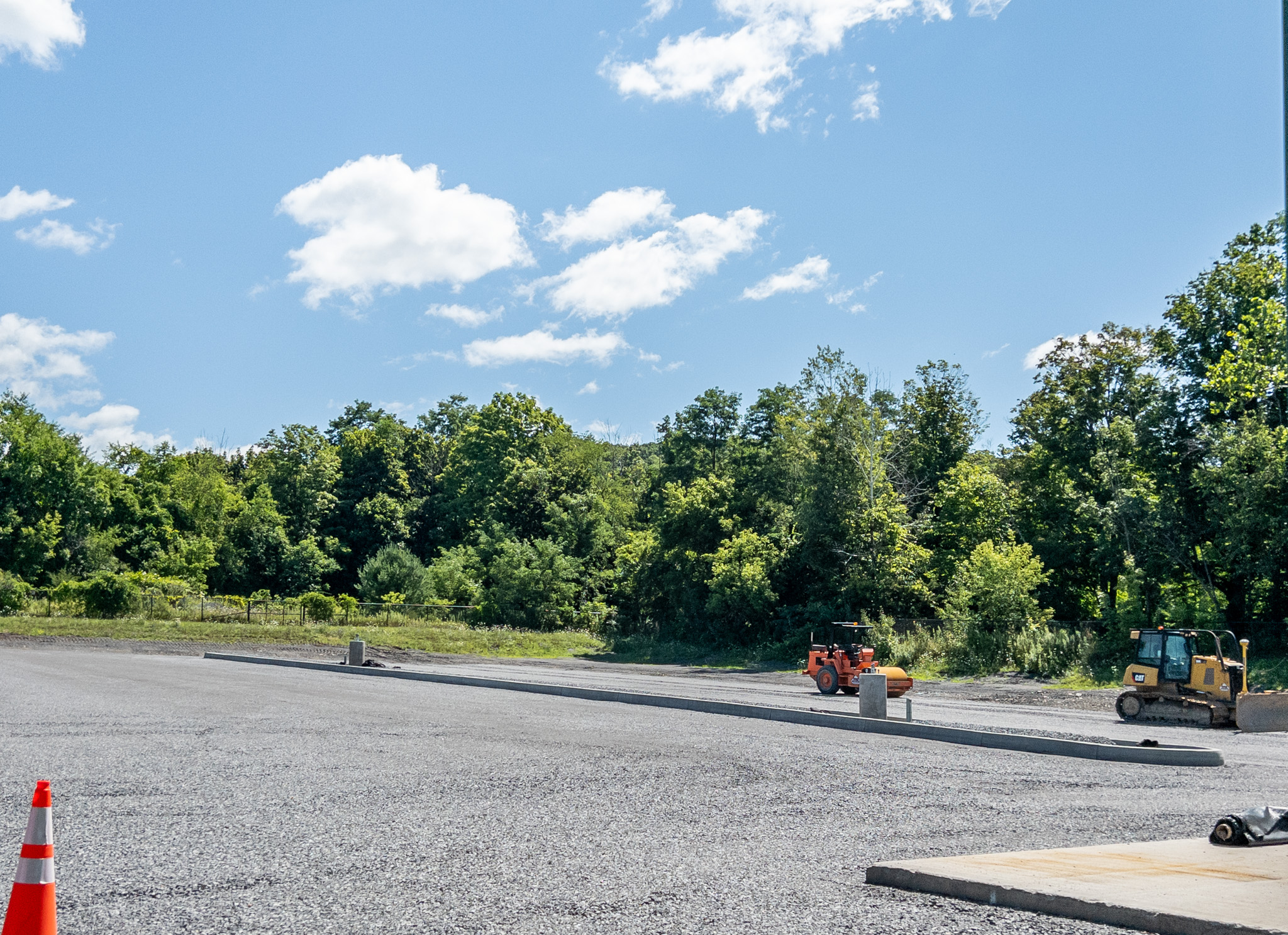

Conduit will be installed under the parking lot to prepare for state-mandated electric vehicle charging. This work will also occur over the summer of 2026.
